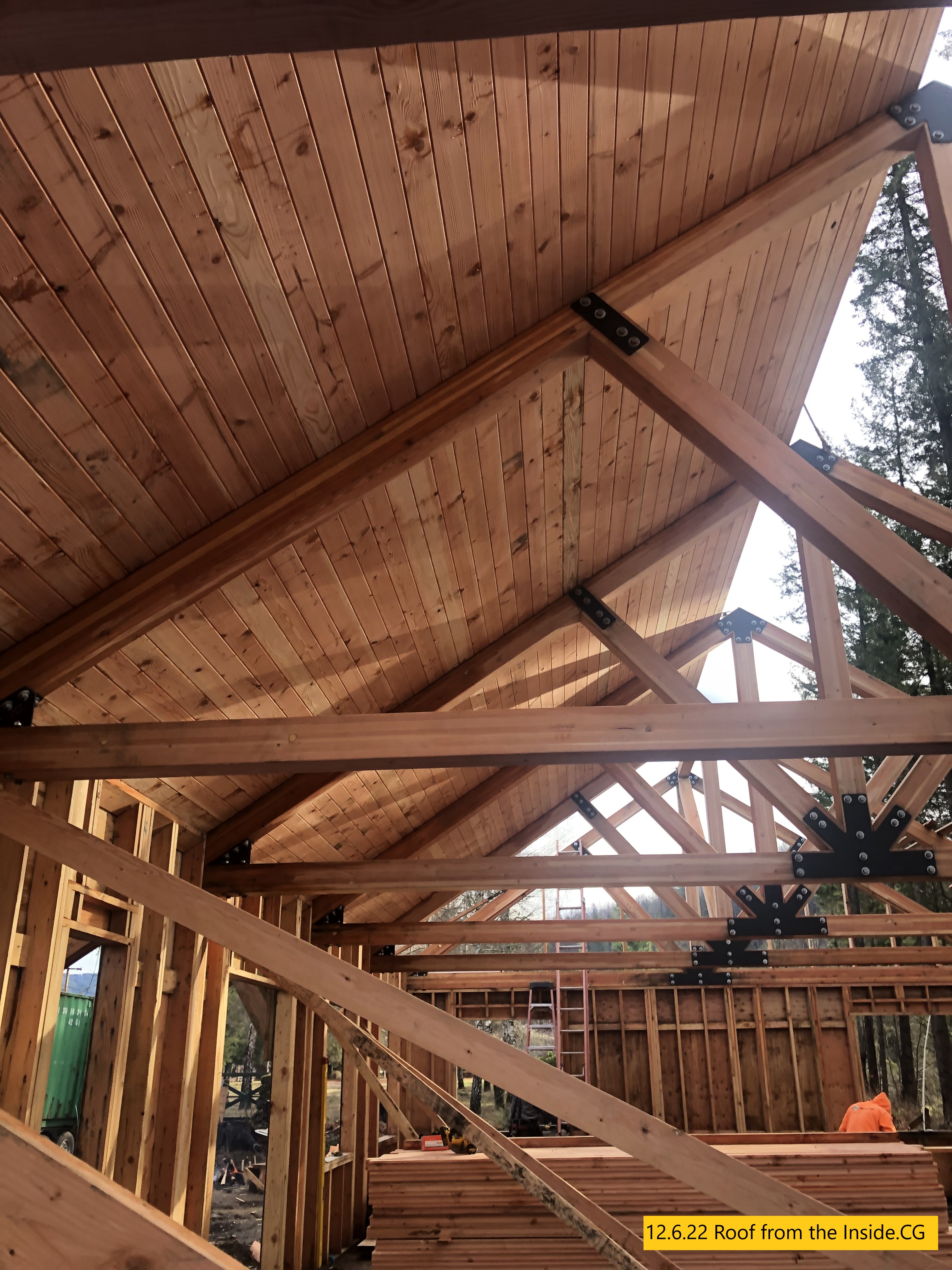

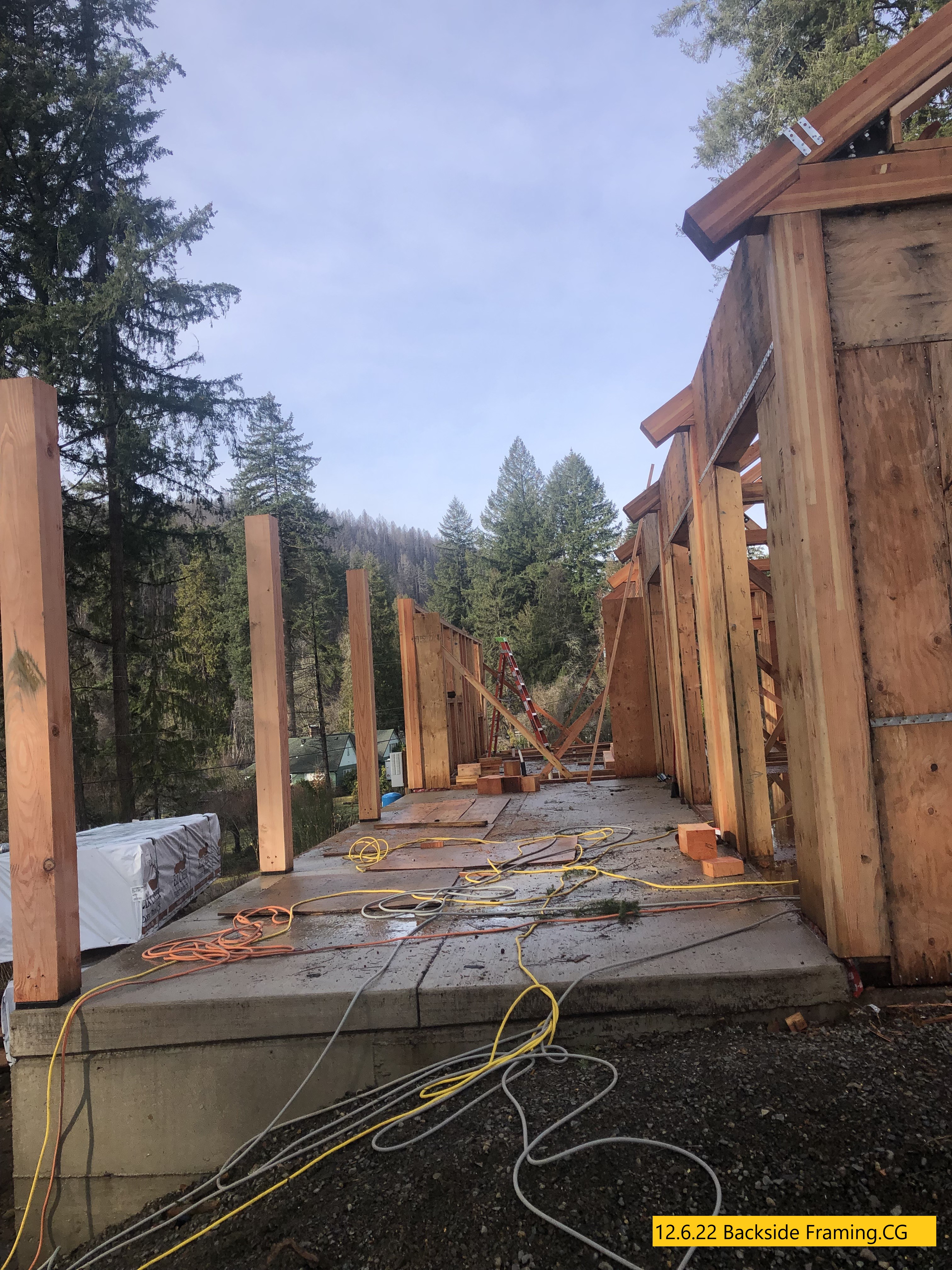

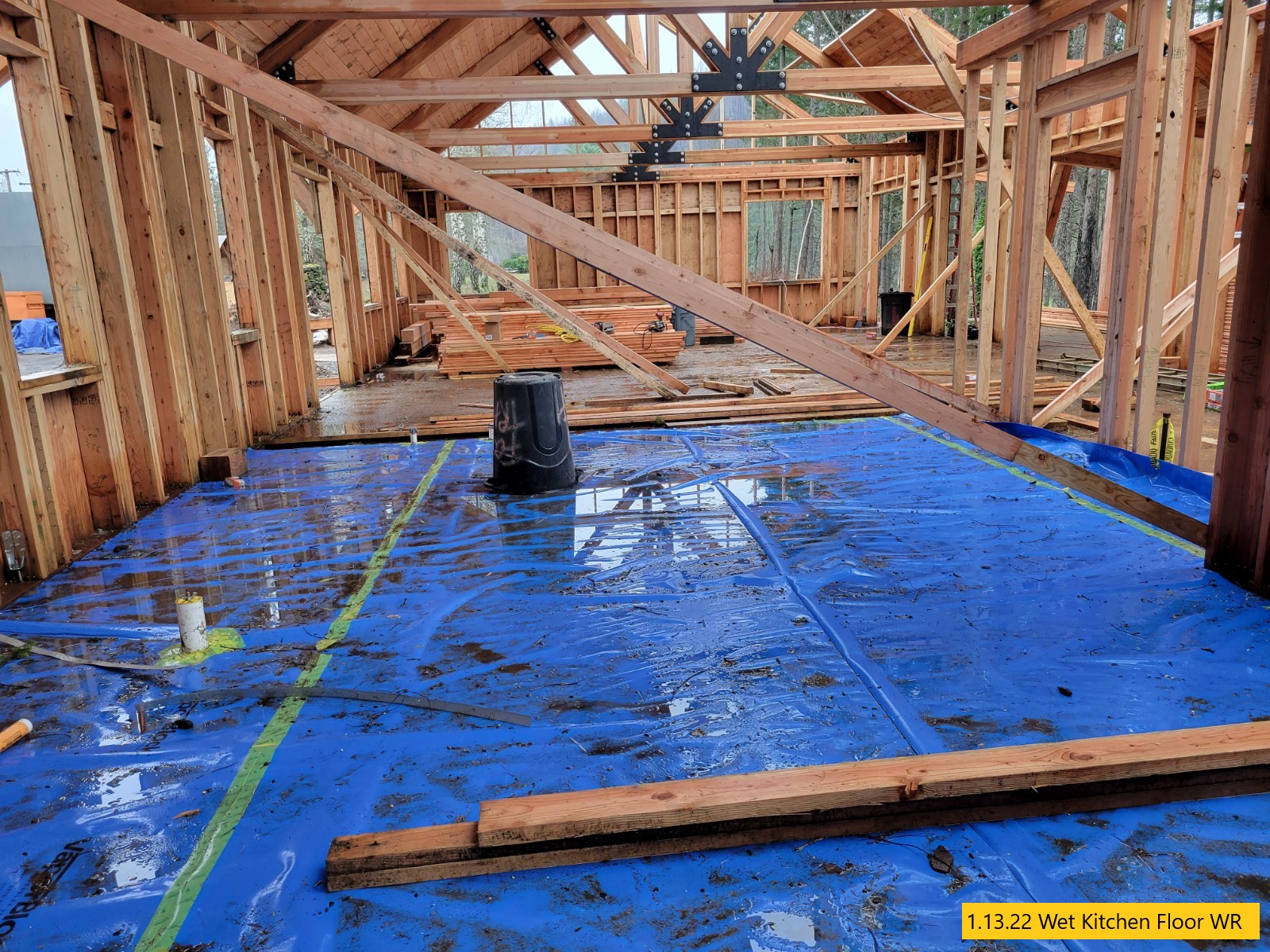

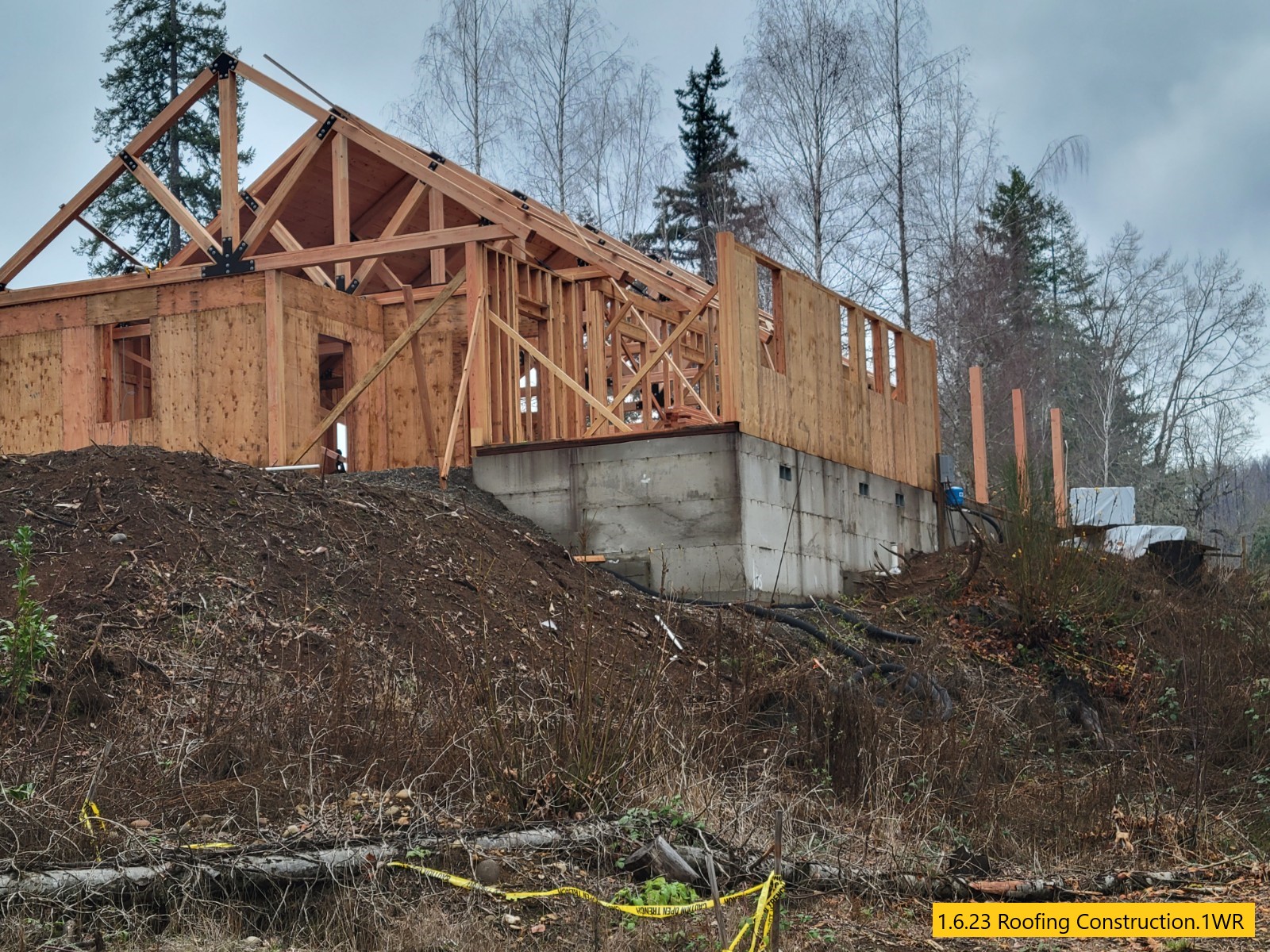

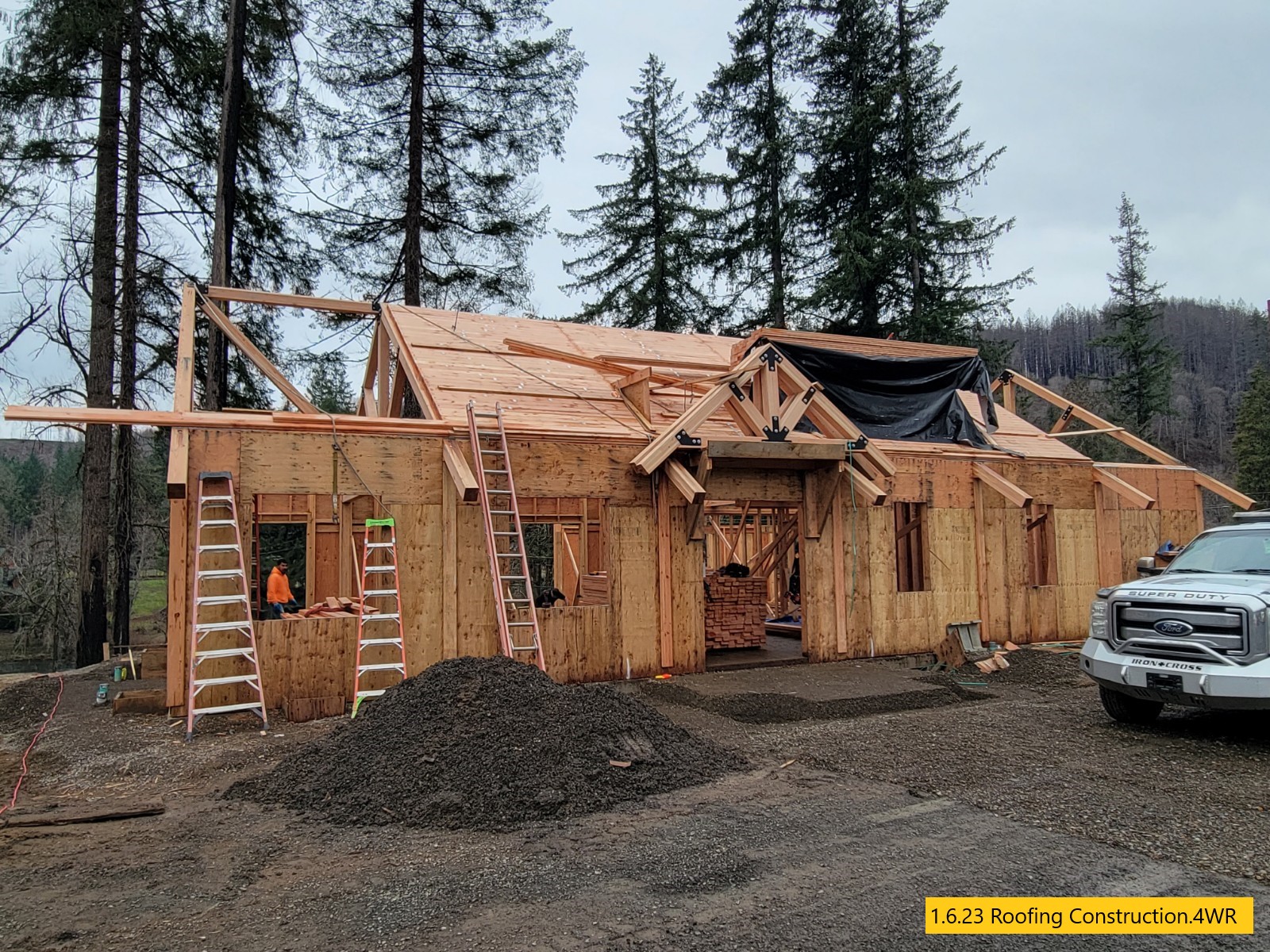

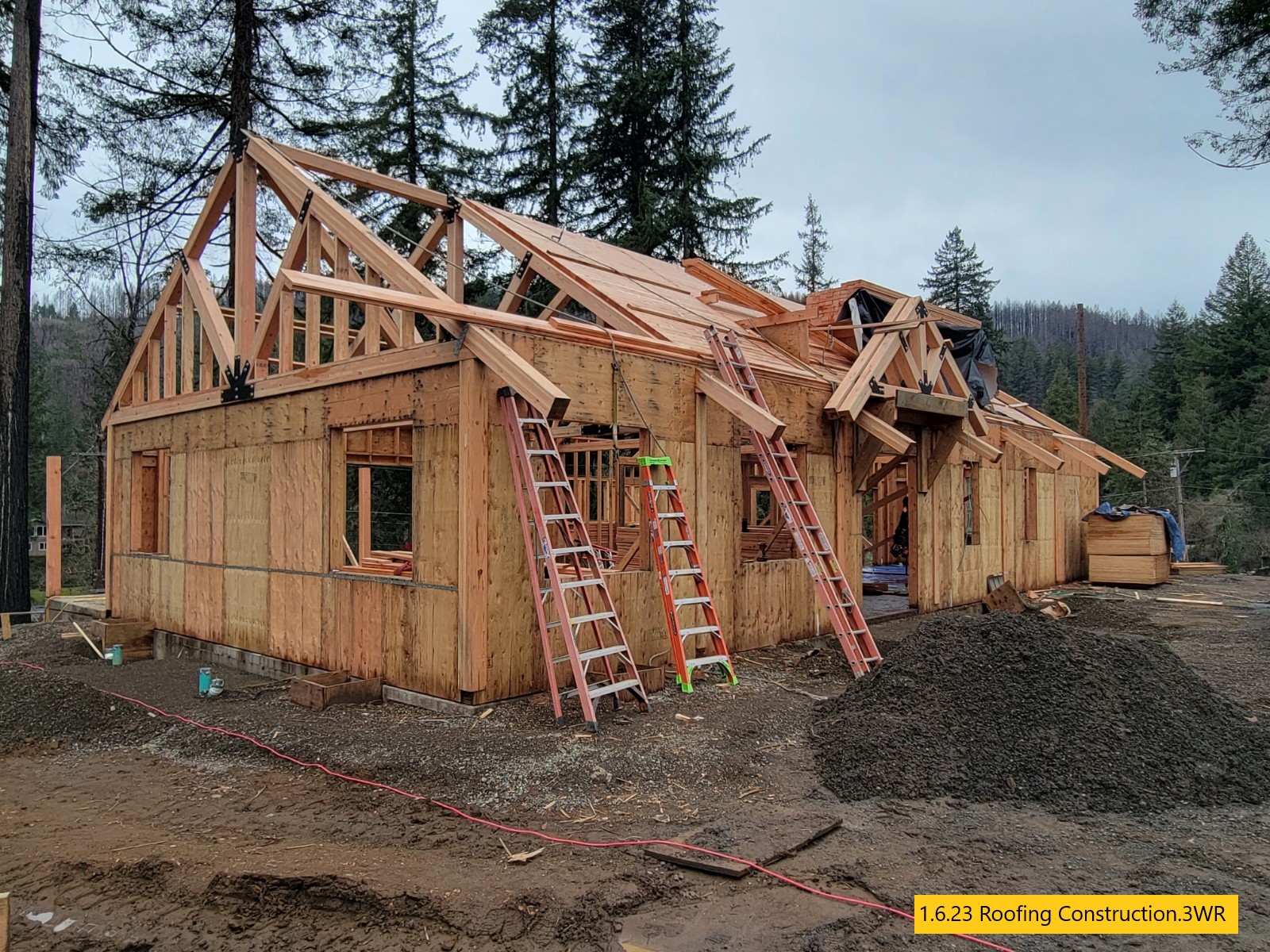

January 6, 2023

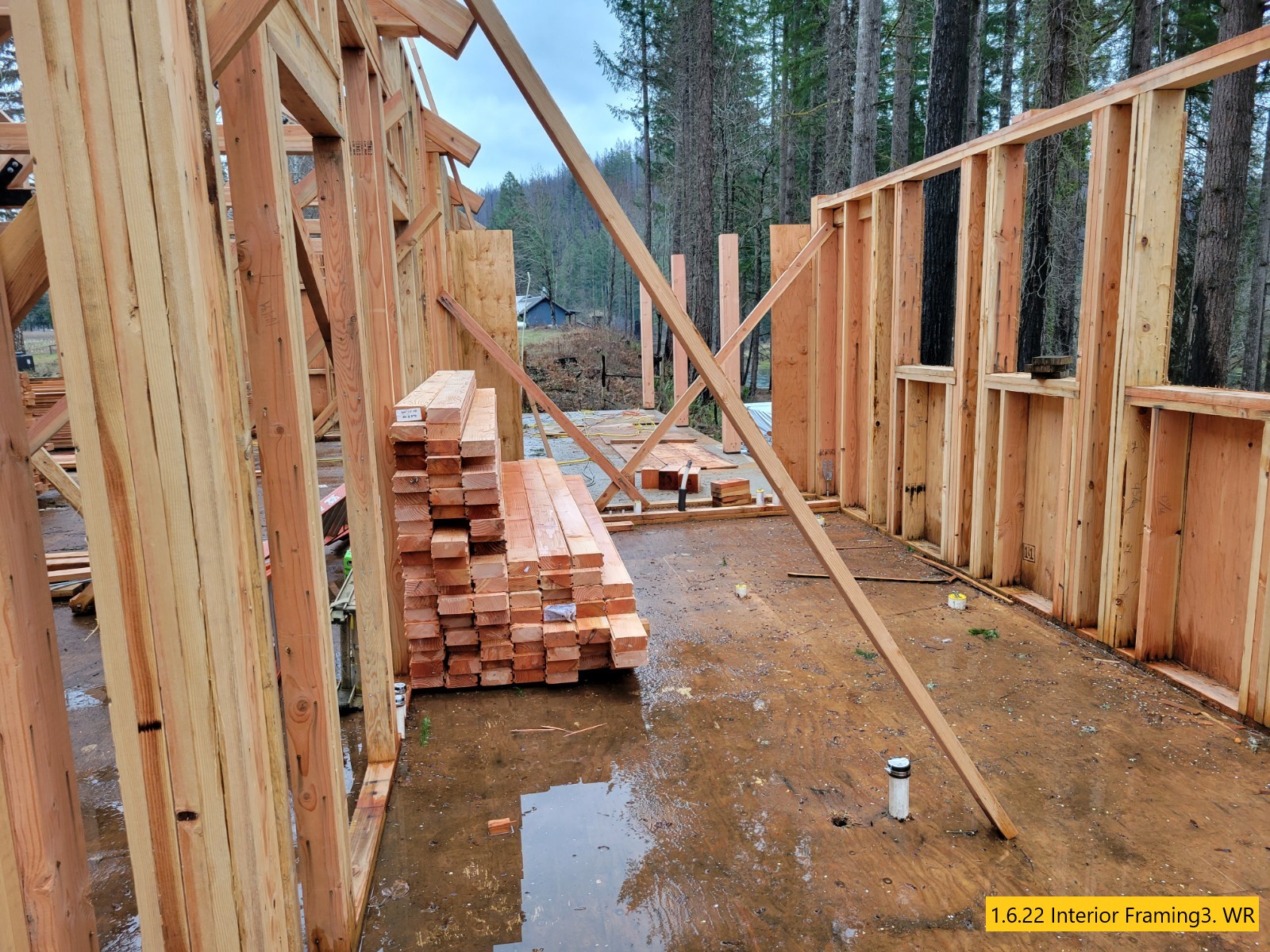

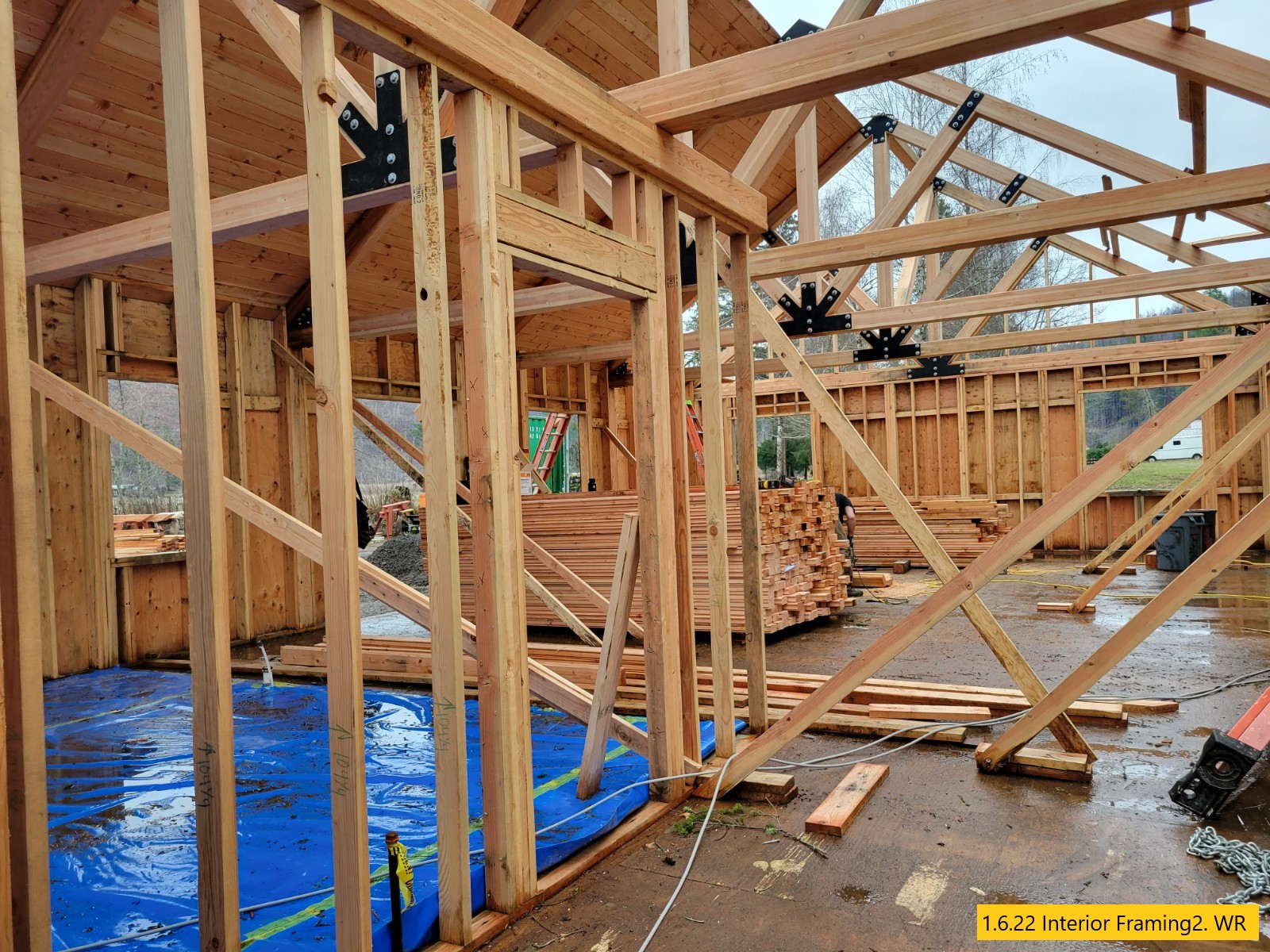

Roof Decking and Interior Framing

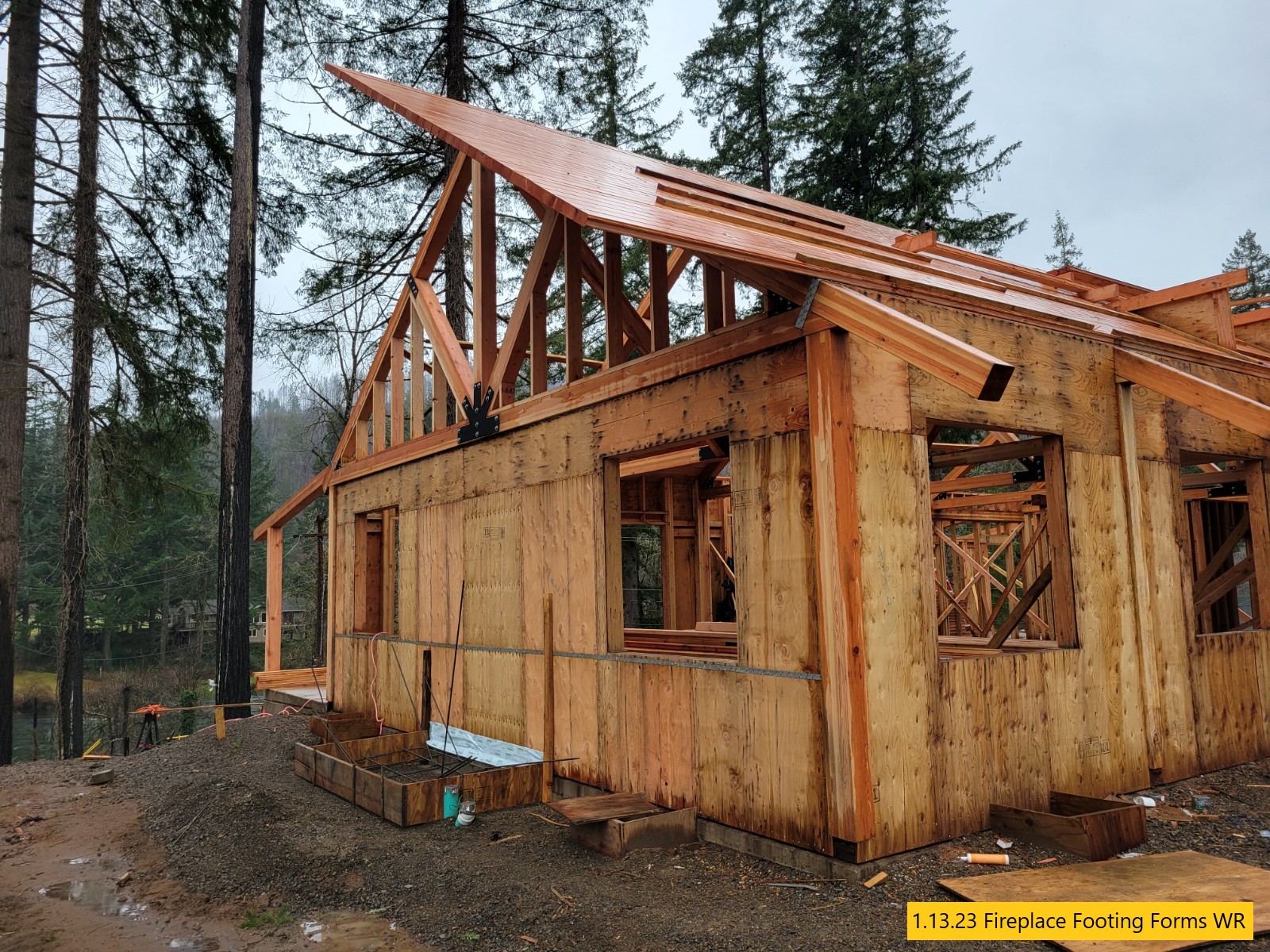

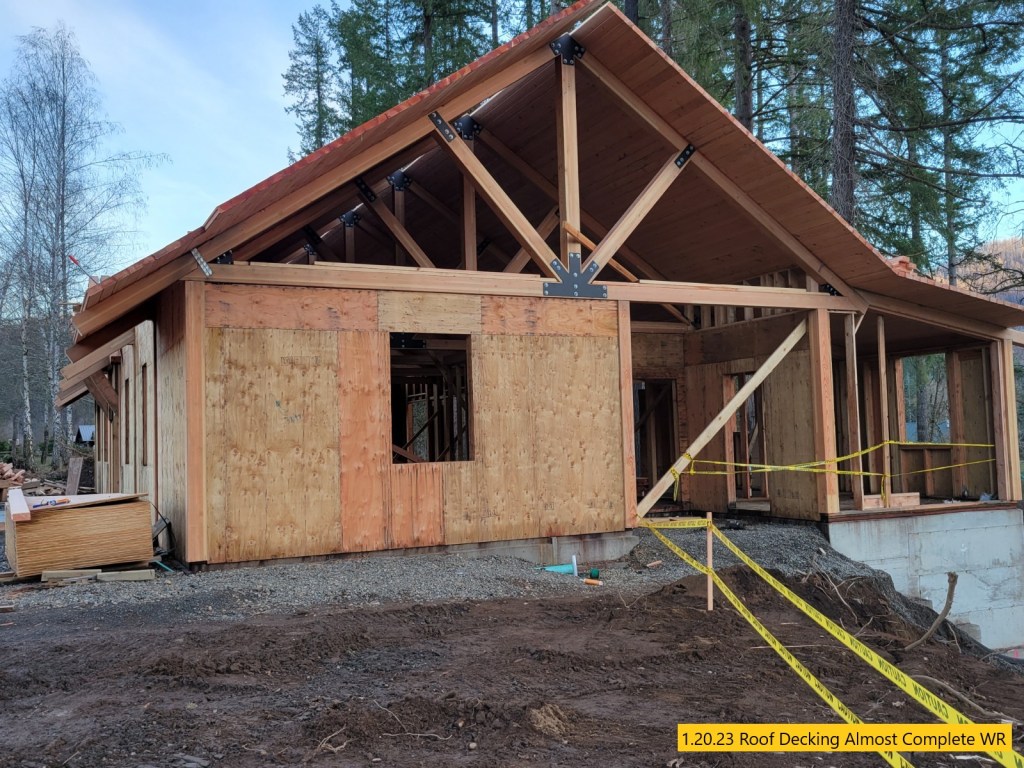

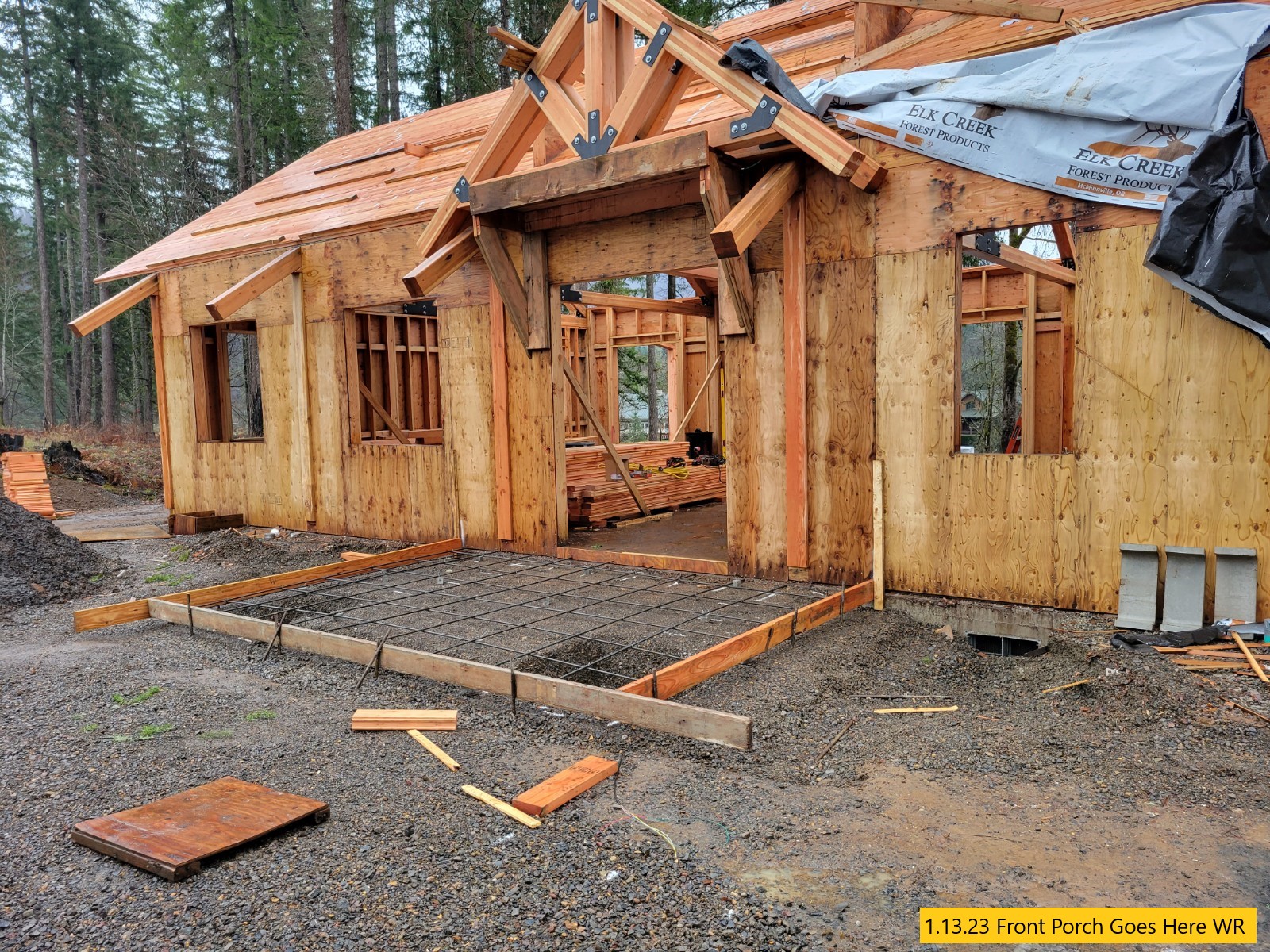

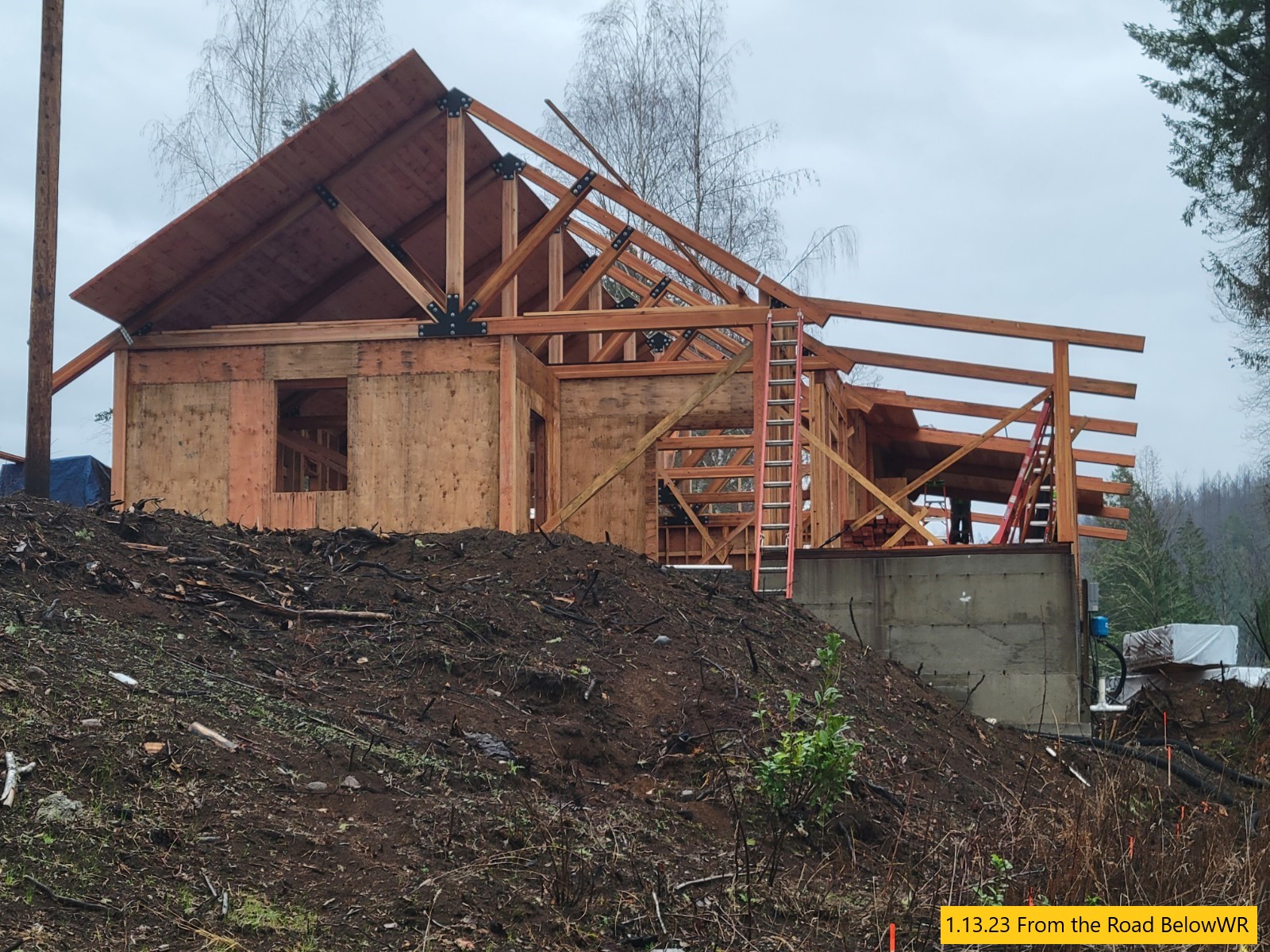

January 13, 2023

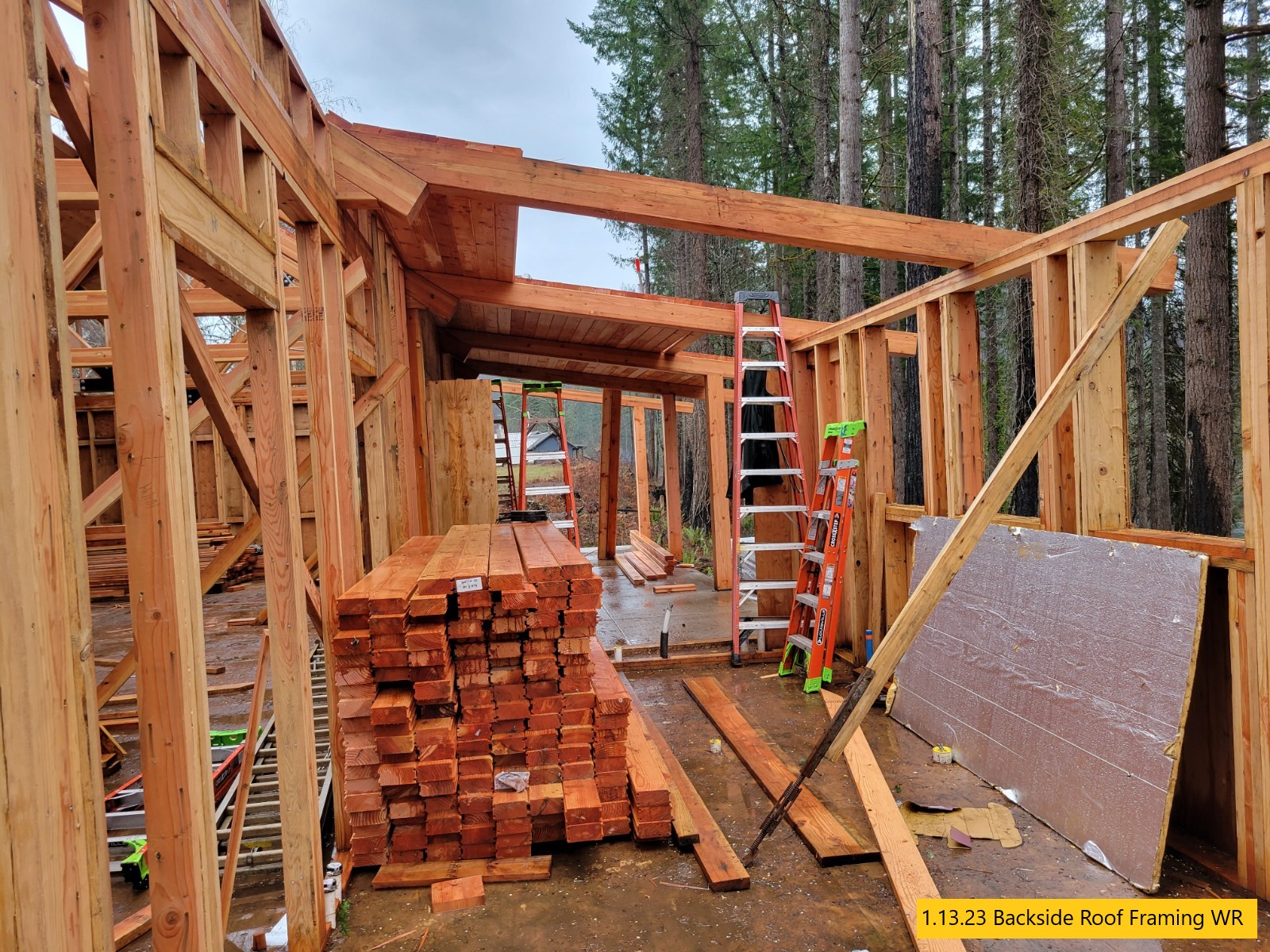

Roof Decking and Interior Framing

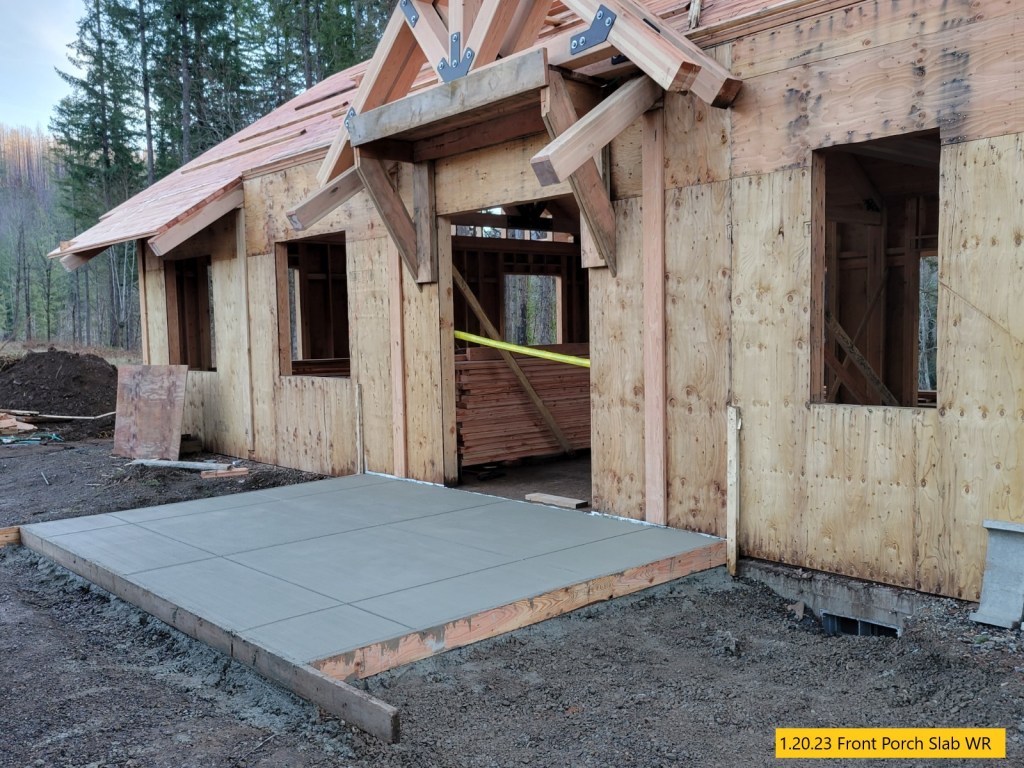

January 20, 2023

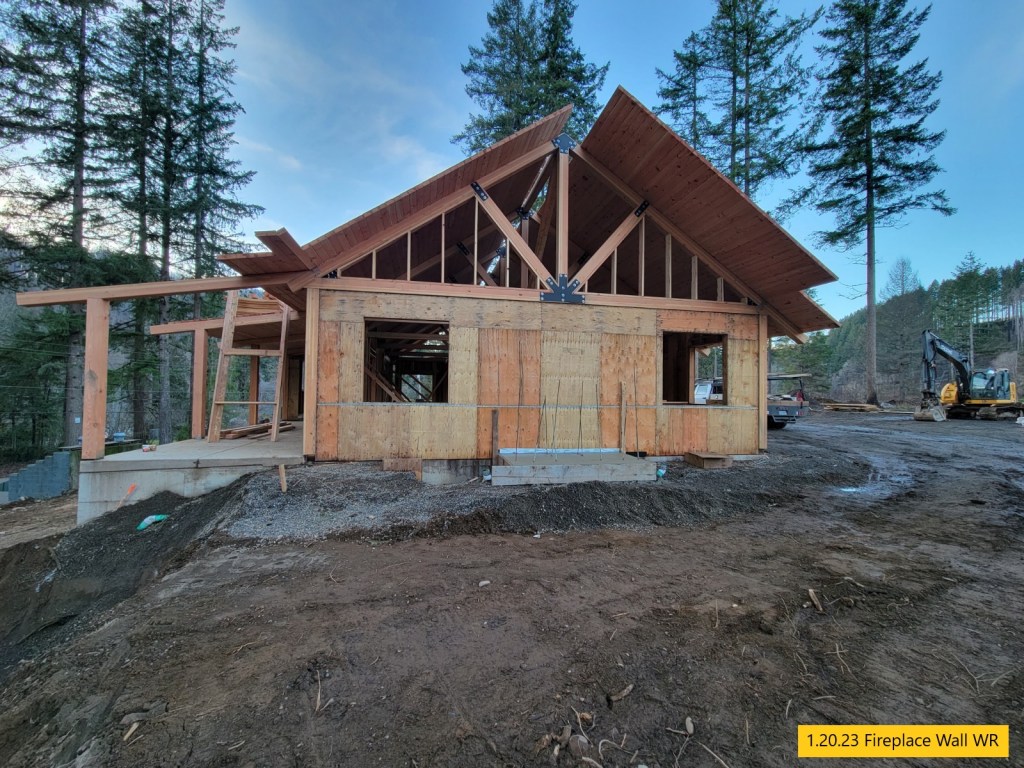

Retaining Wall Footings, Roof Decking, Porch and Fireplace Slabs

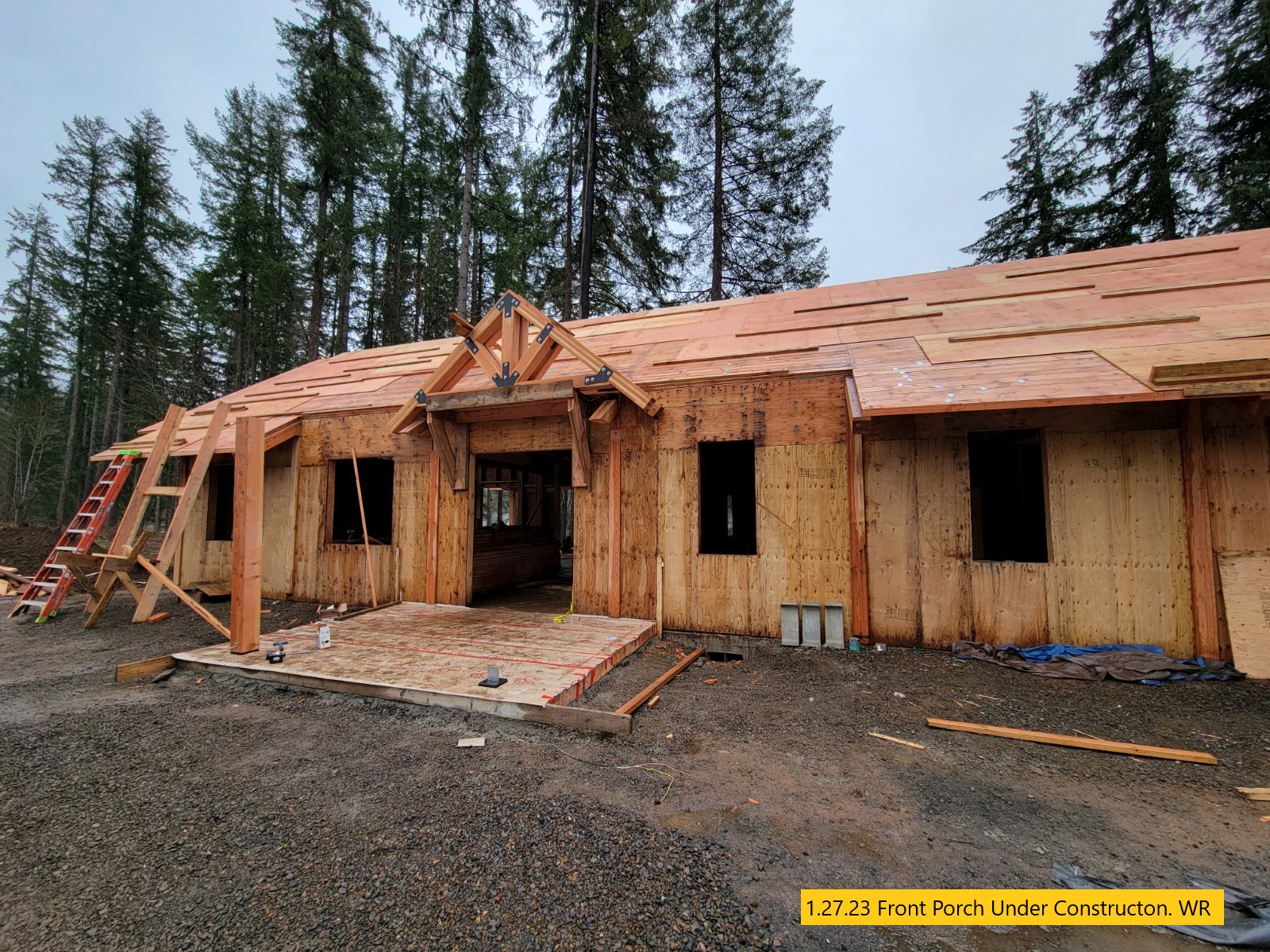

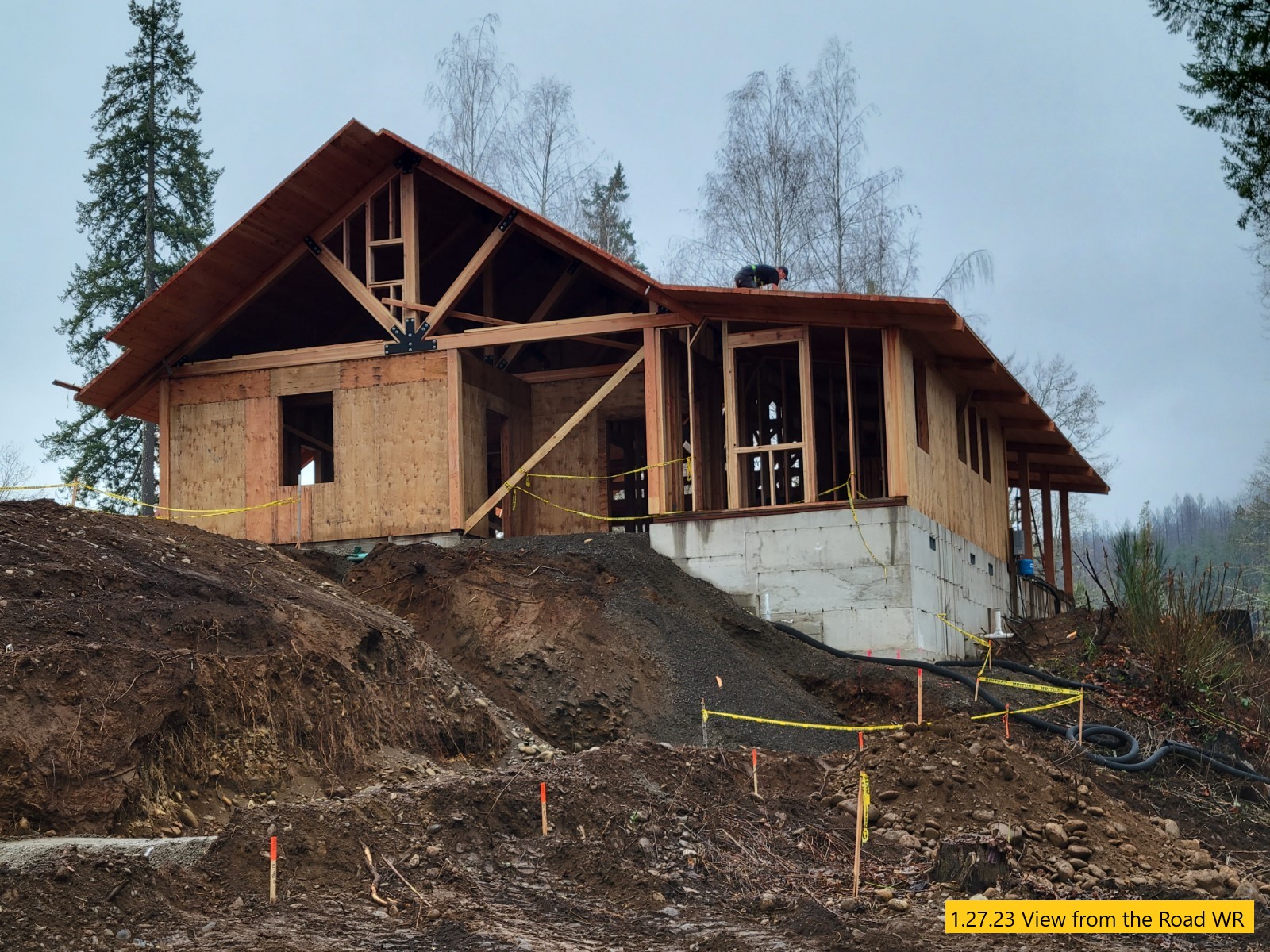

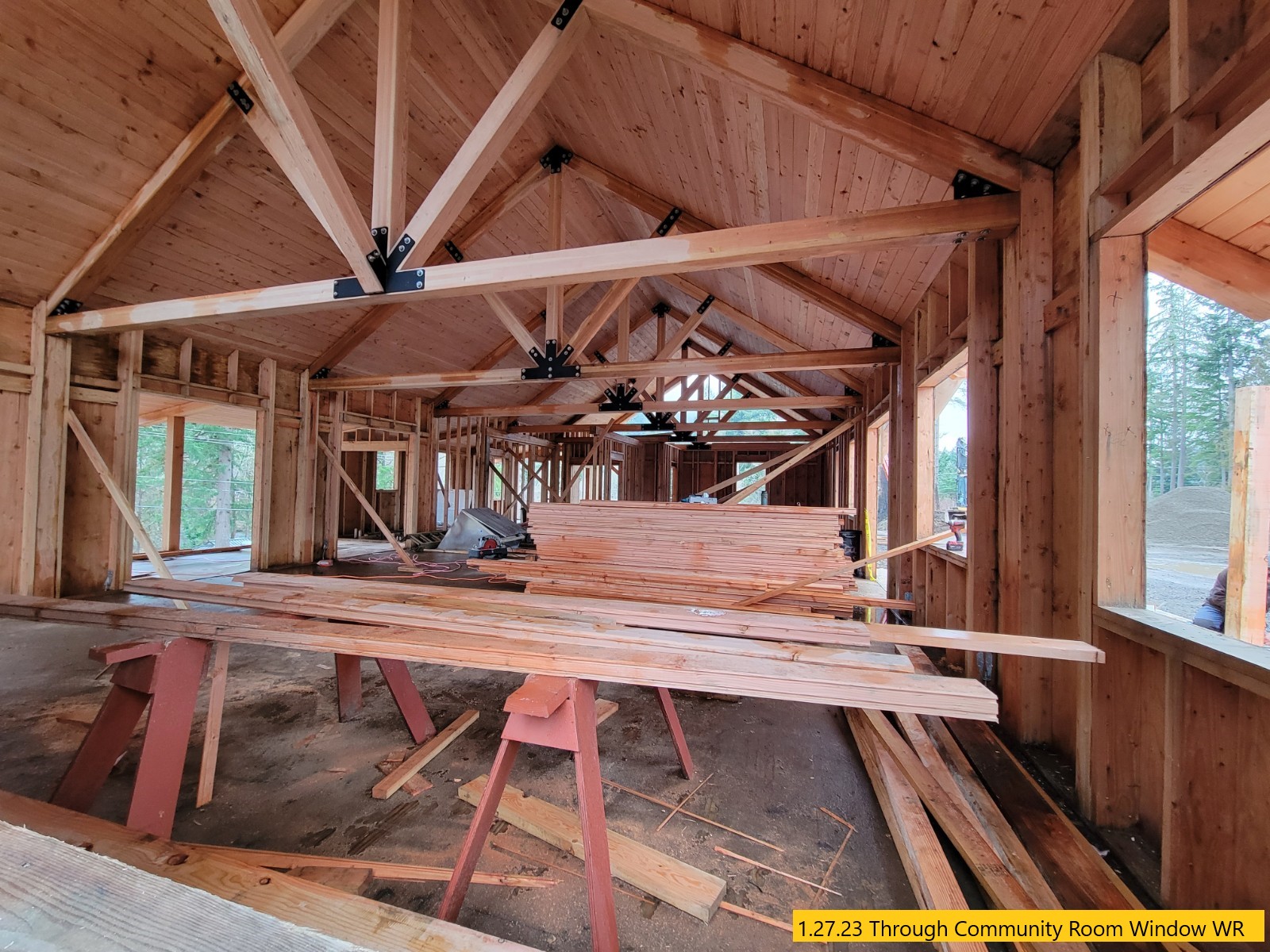

January 27, 2023

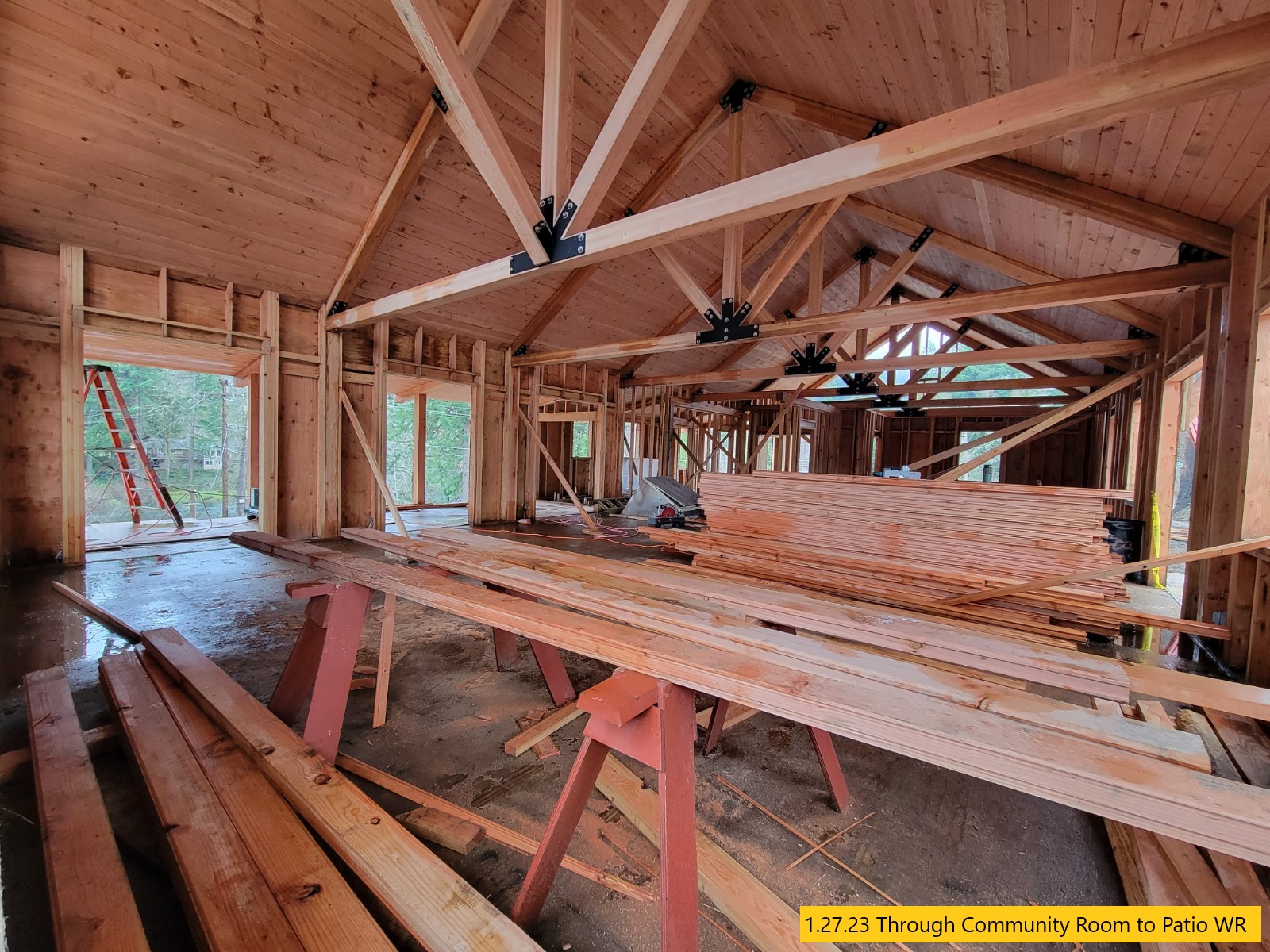

January Update from our Project Manager Craig Gustafson

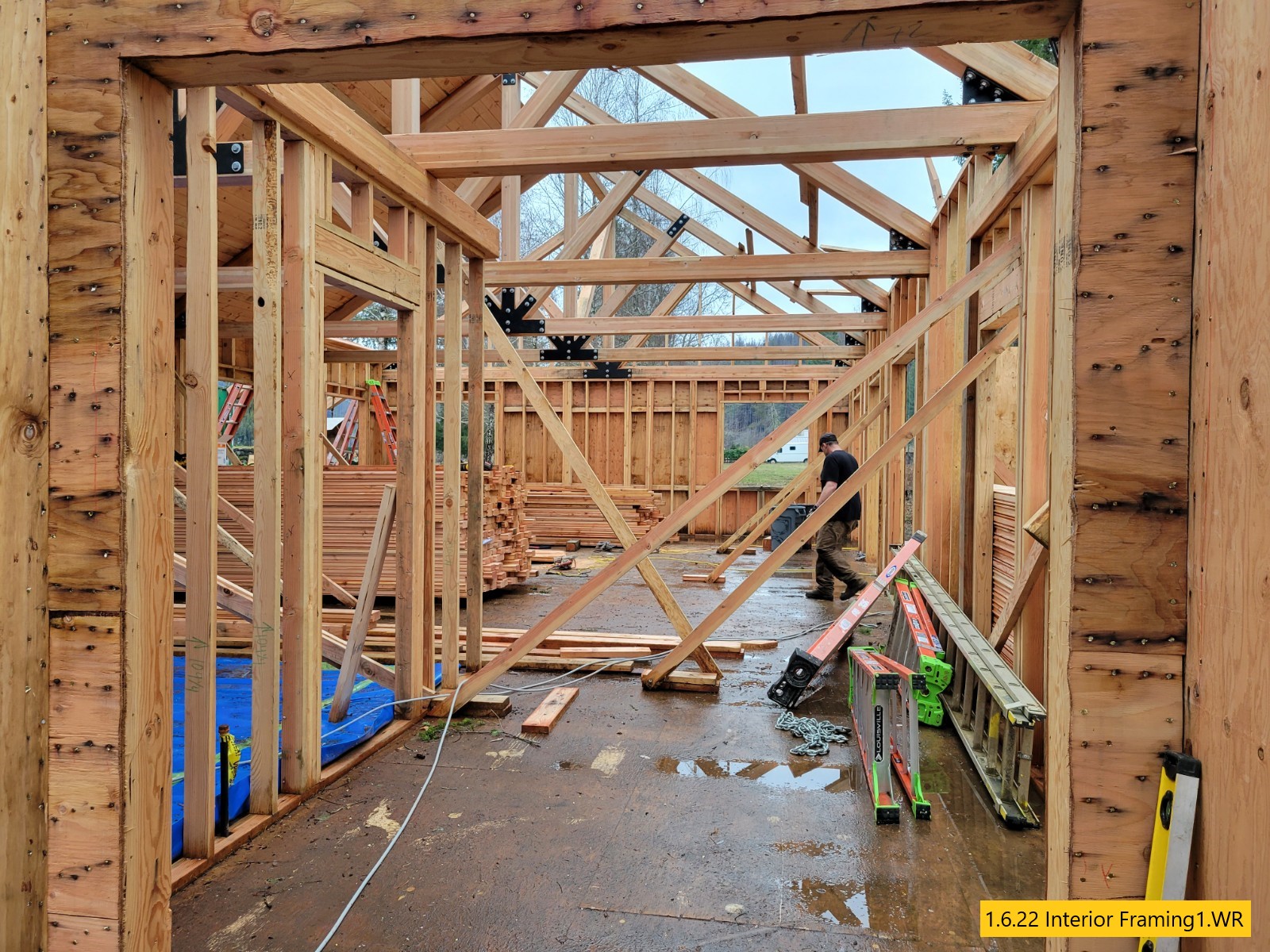

- Framing construction approximately 80% complete
- Trusses were installed in December

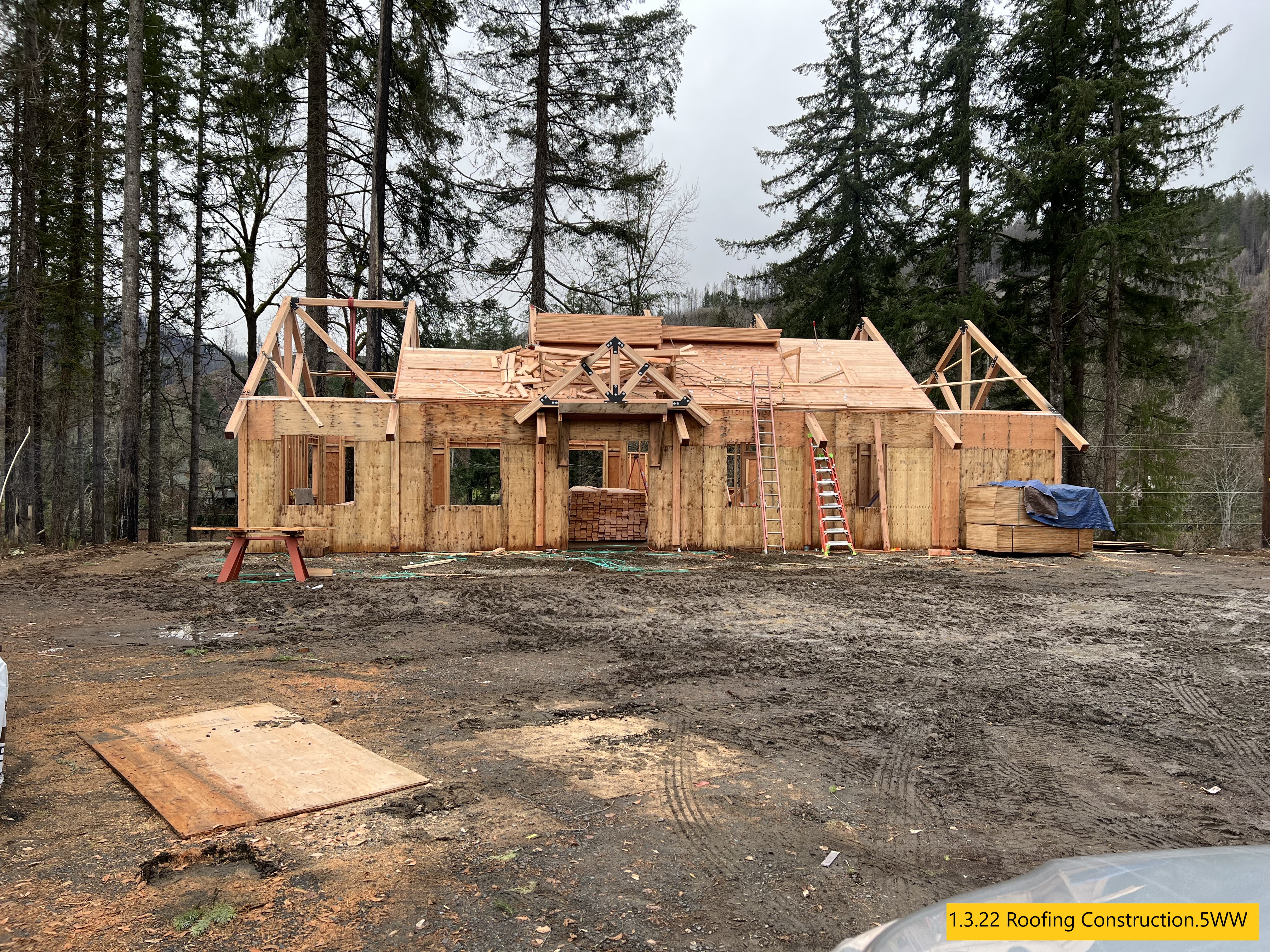

- Tongue and Groove (T&G) roof decking 95% complete

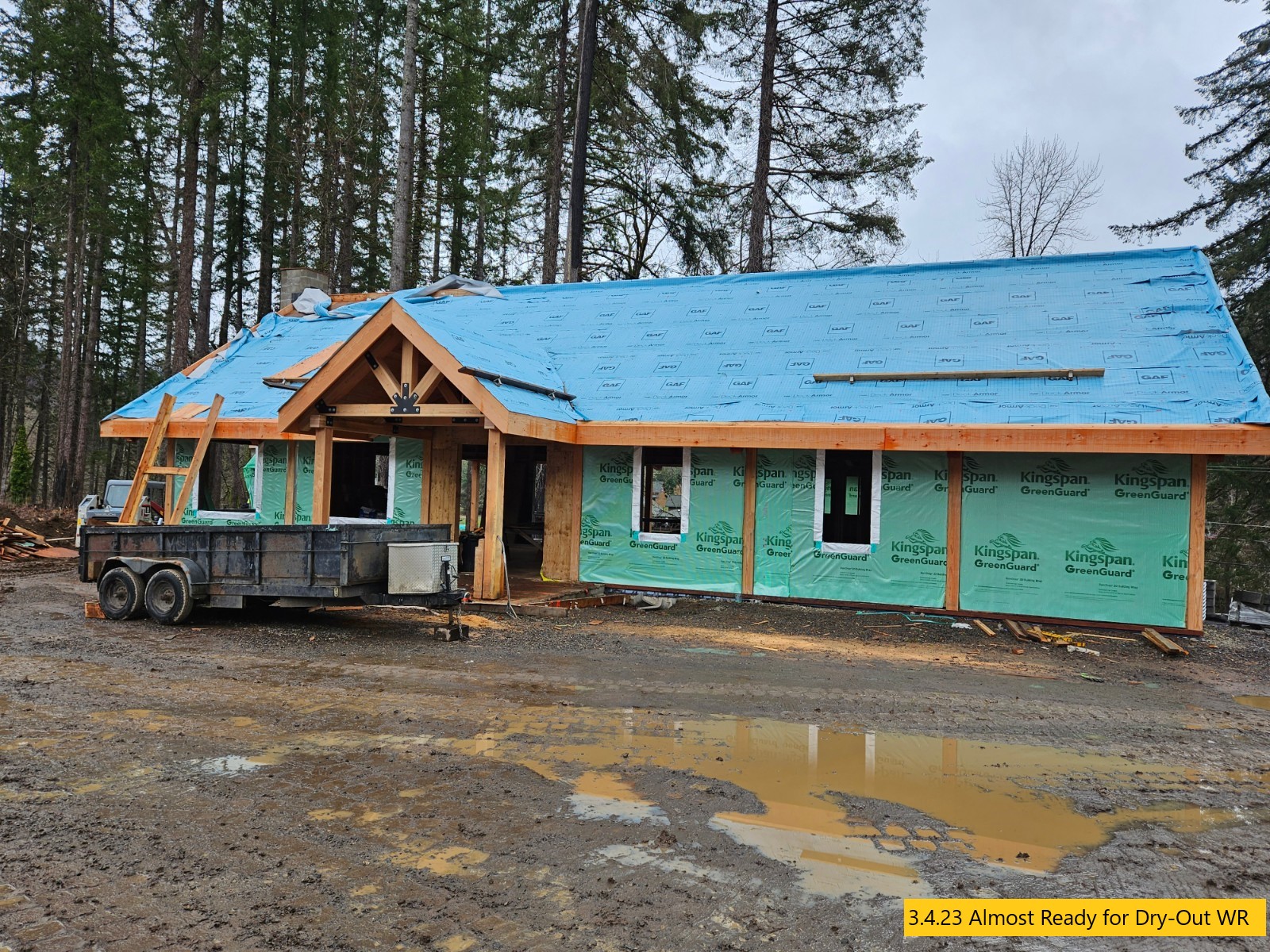

- When roof decking is complete Dorman will begin building dry-out

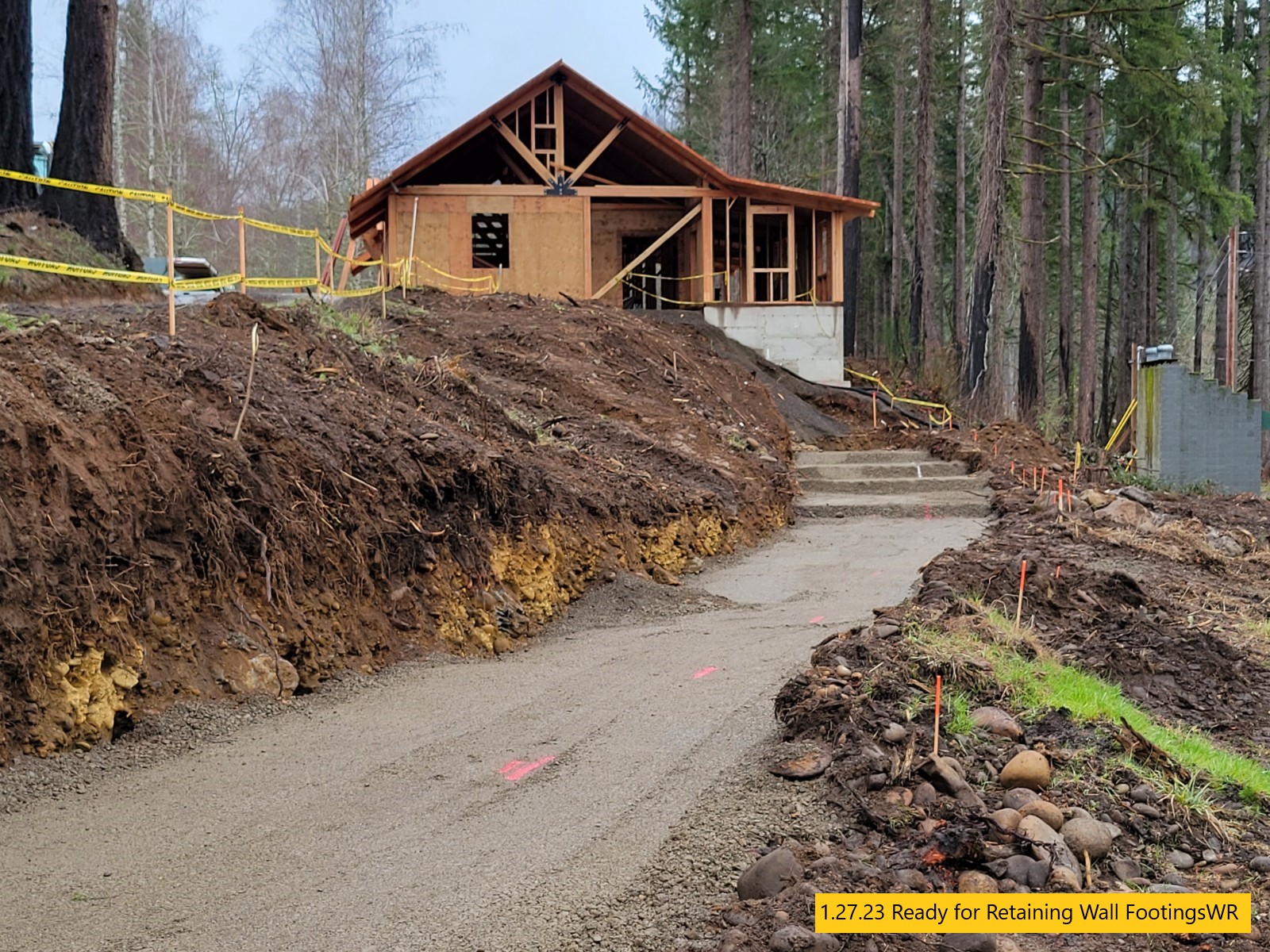

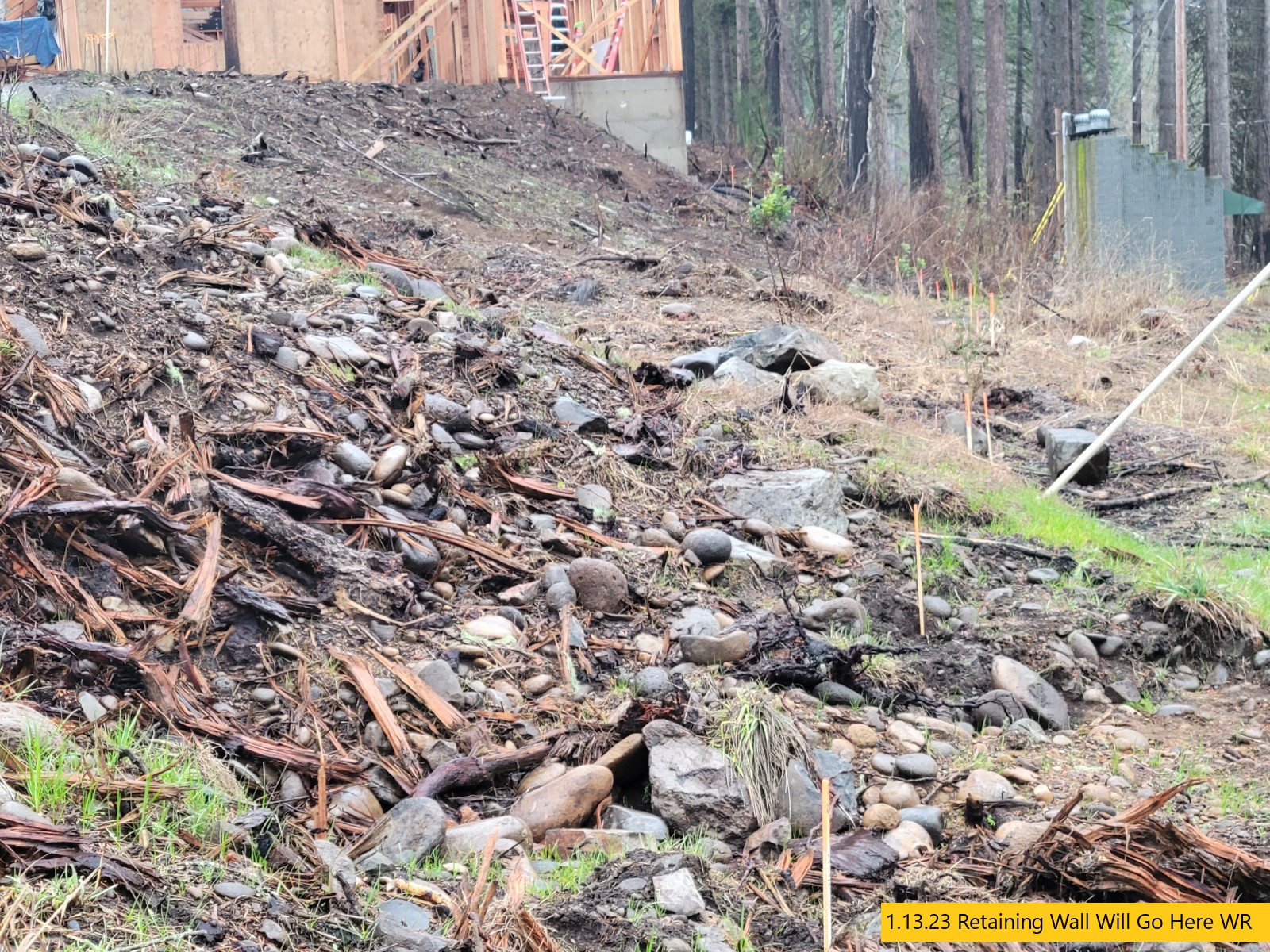

- Retaining Wall footing excavation is complete
- New underground electrical will be 100% underground

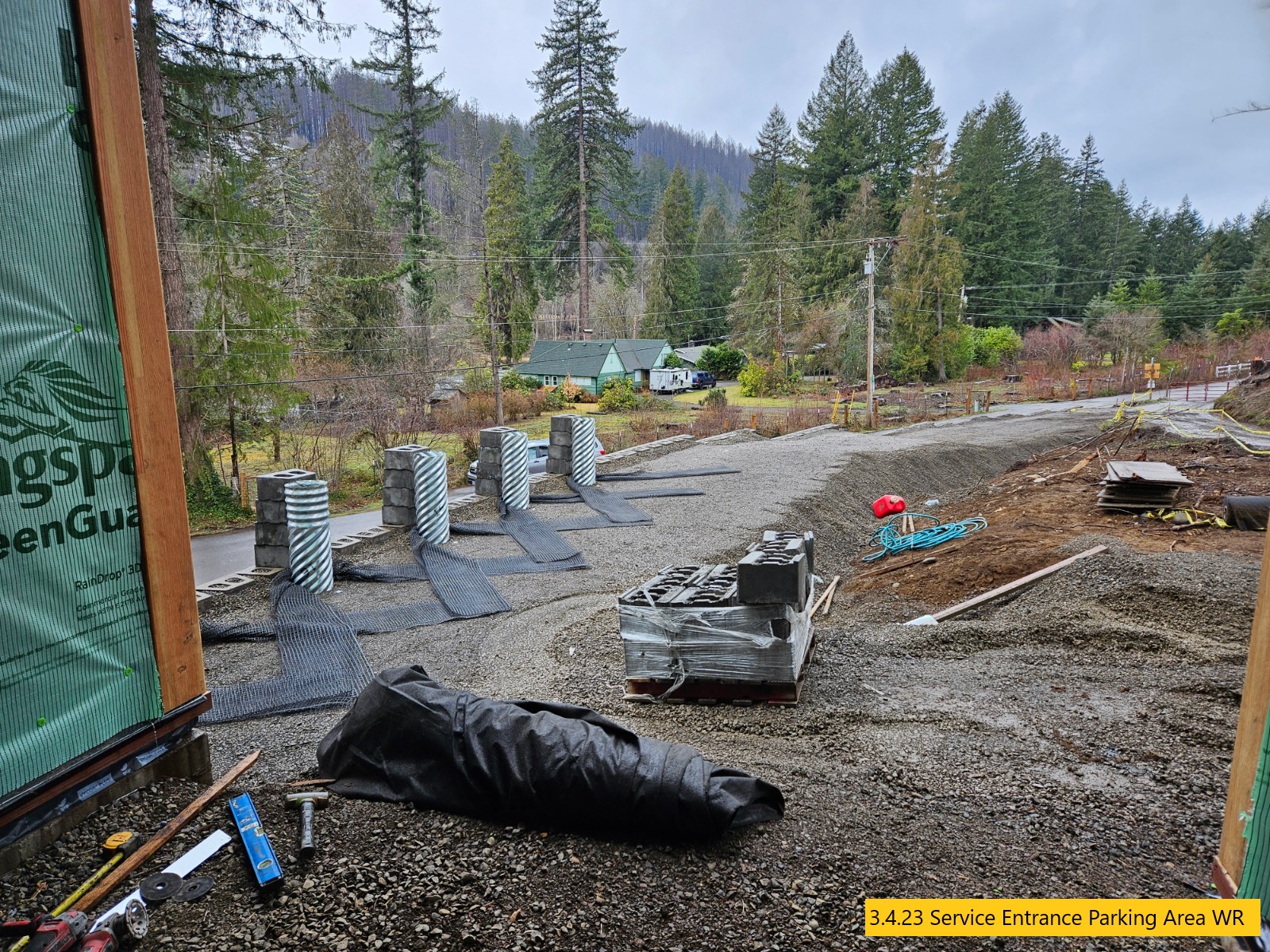

- EWEB awarded a $10,000 grant to apply to service entrance facilities
- A 1,000-gallon propane tank will be installed by R&D Propane
- Curtis Equipment has revised kitchen appliance design based on budget
- Billy Pruitt is now providing nighttime security living on-site
- Purchase of remaining construction components continues

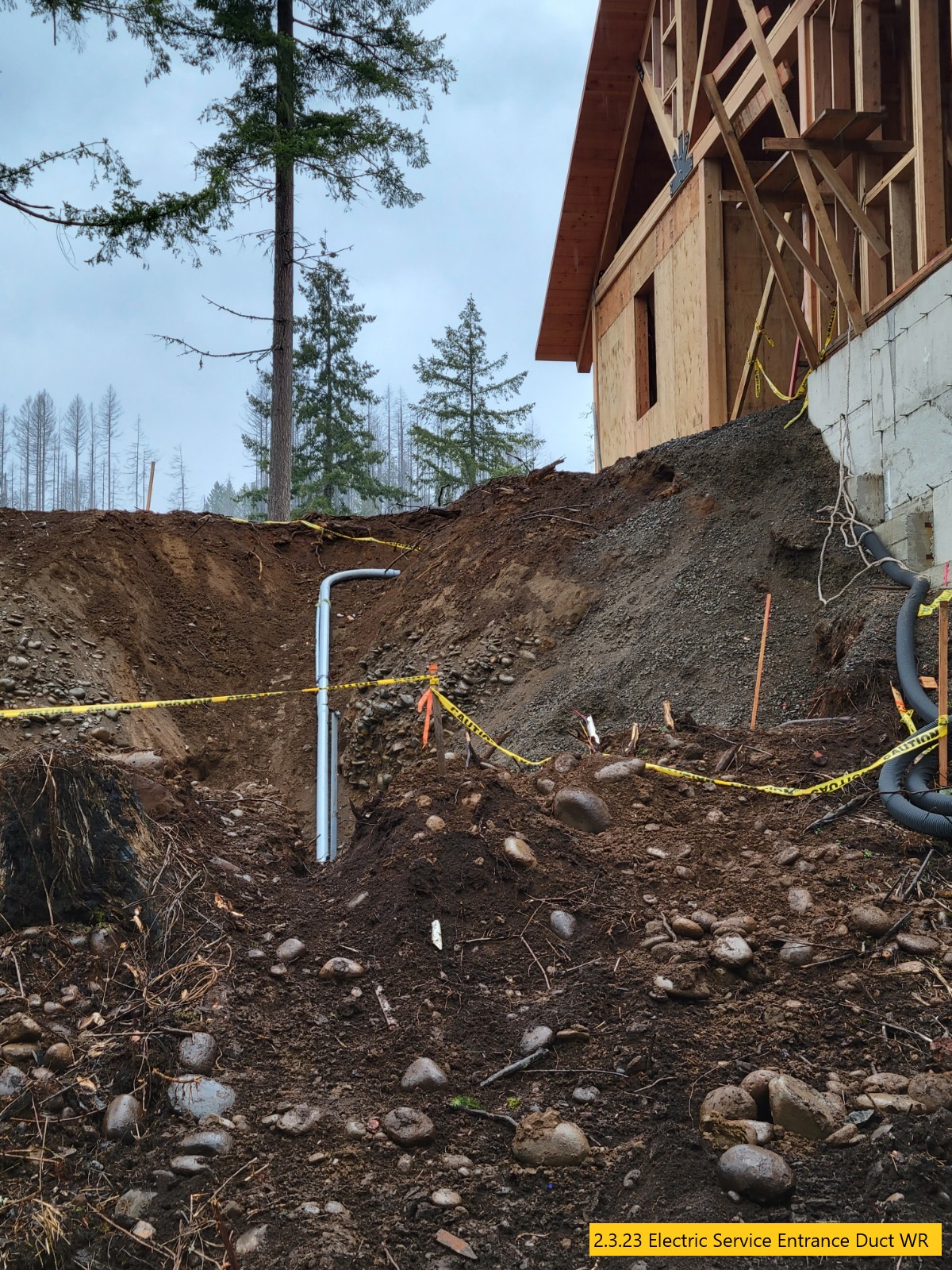

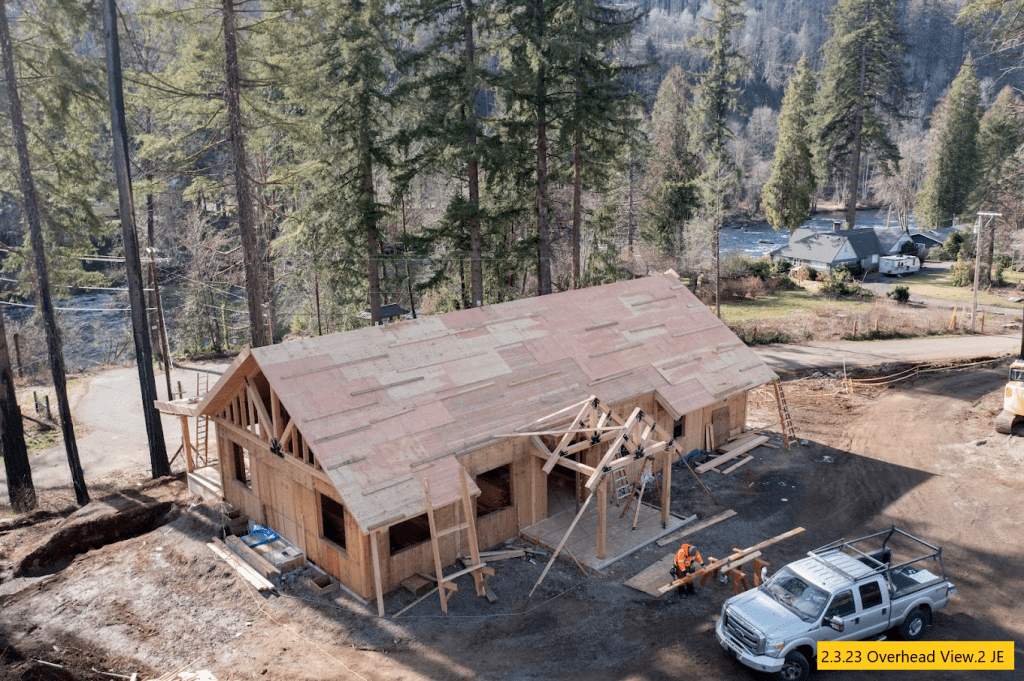

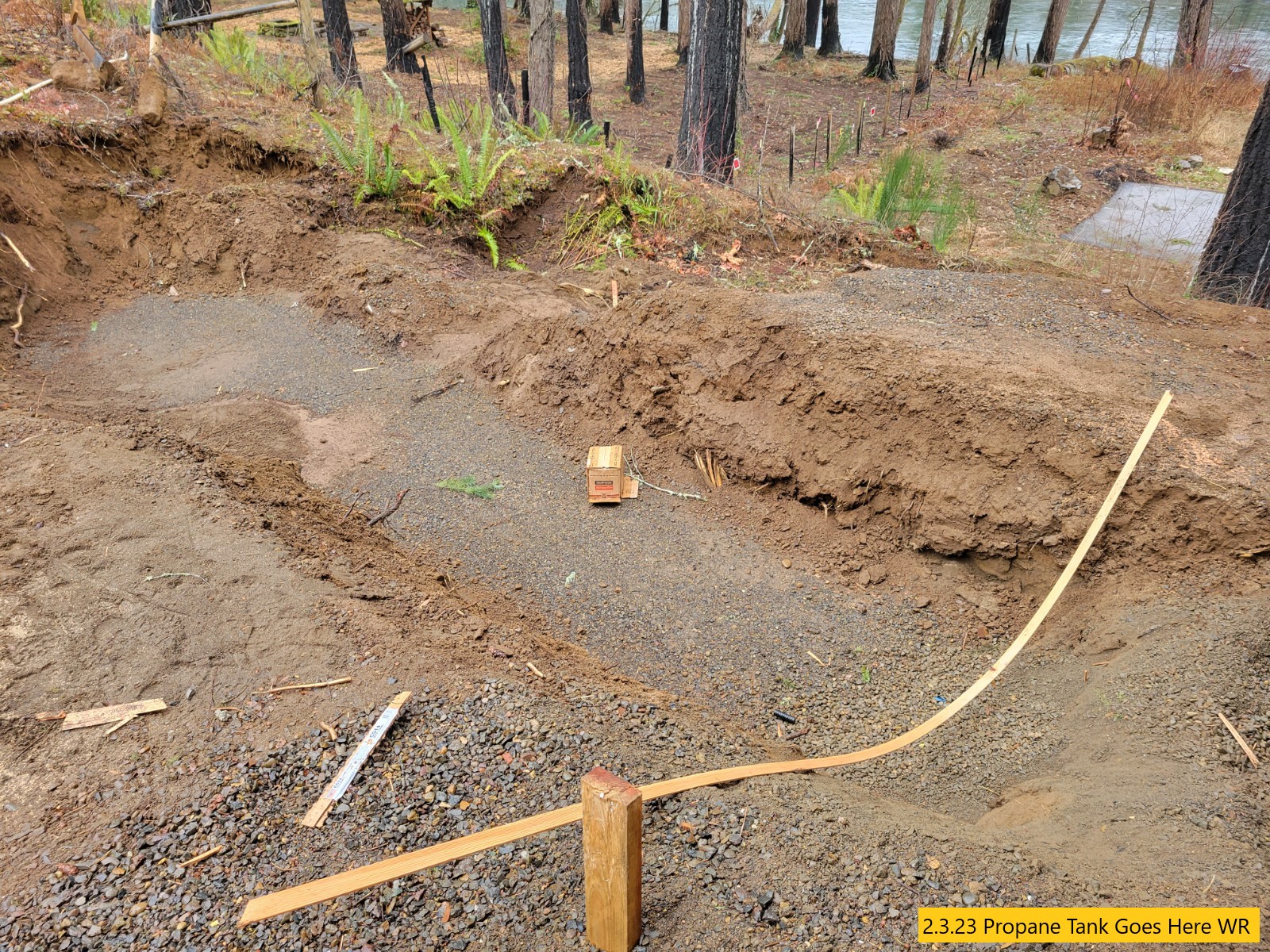

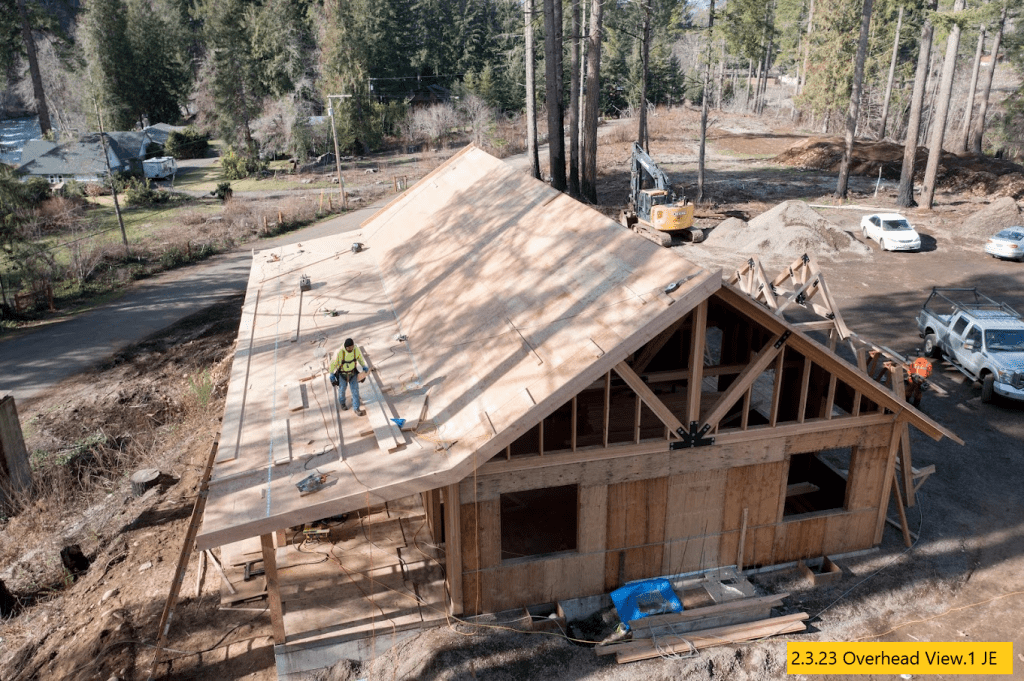

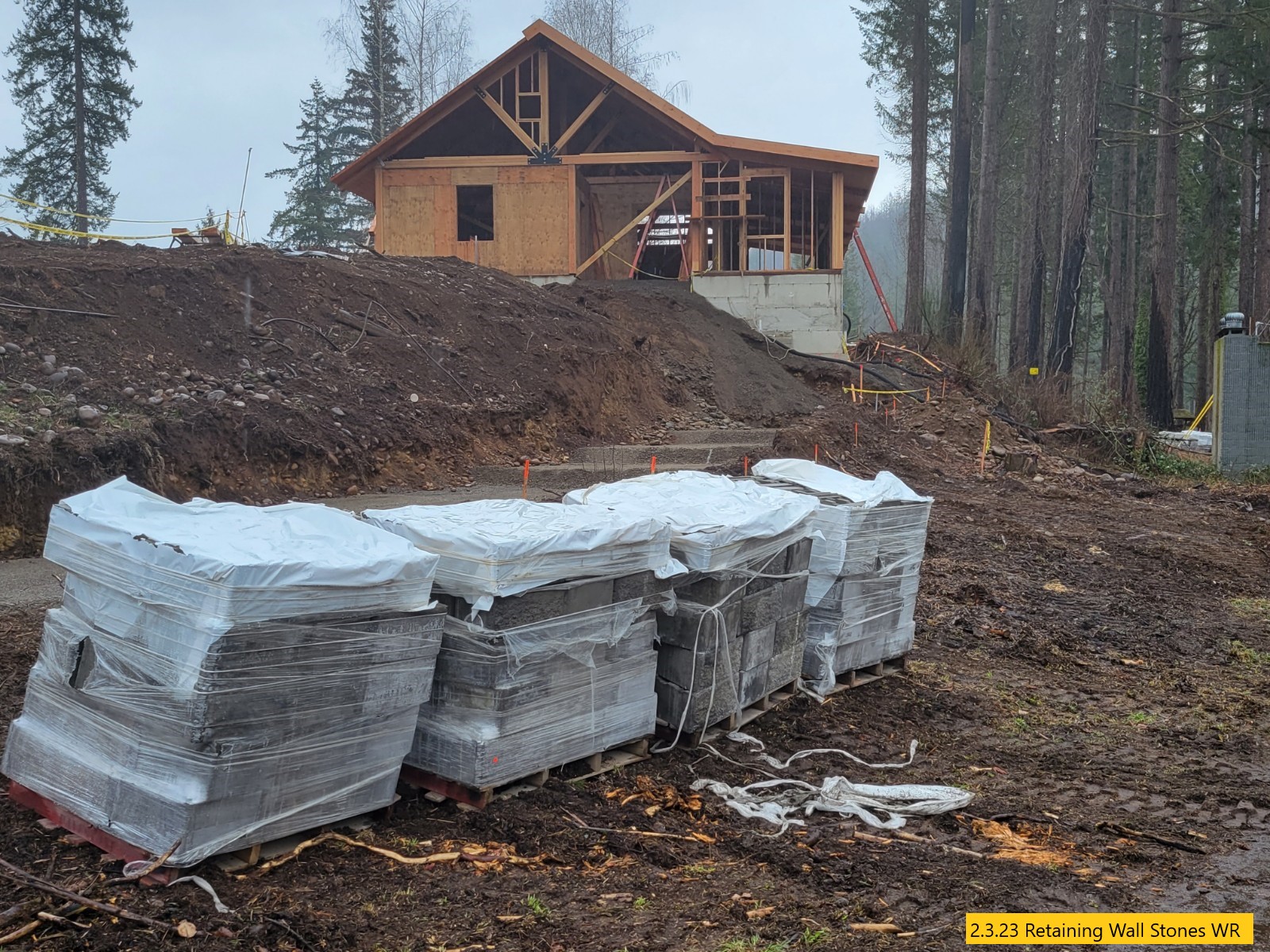

February 3, 2023

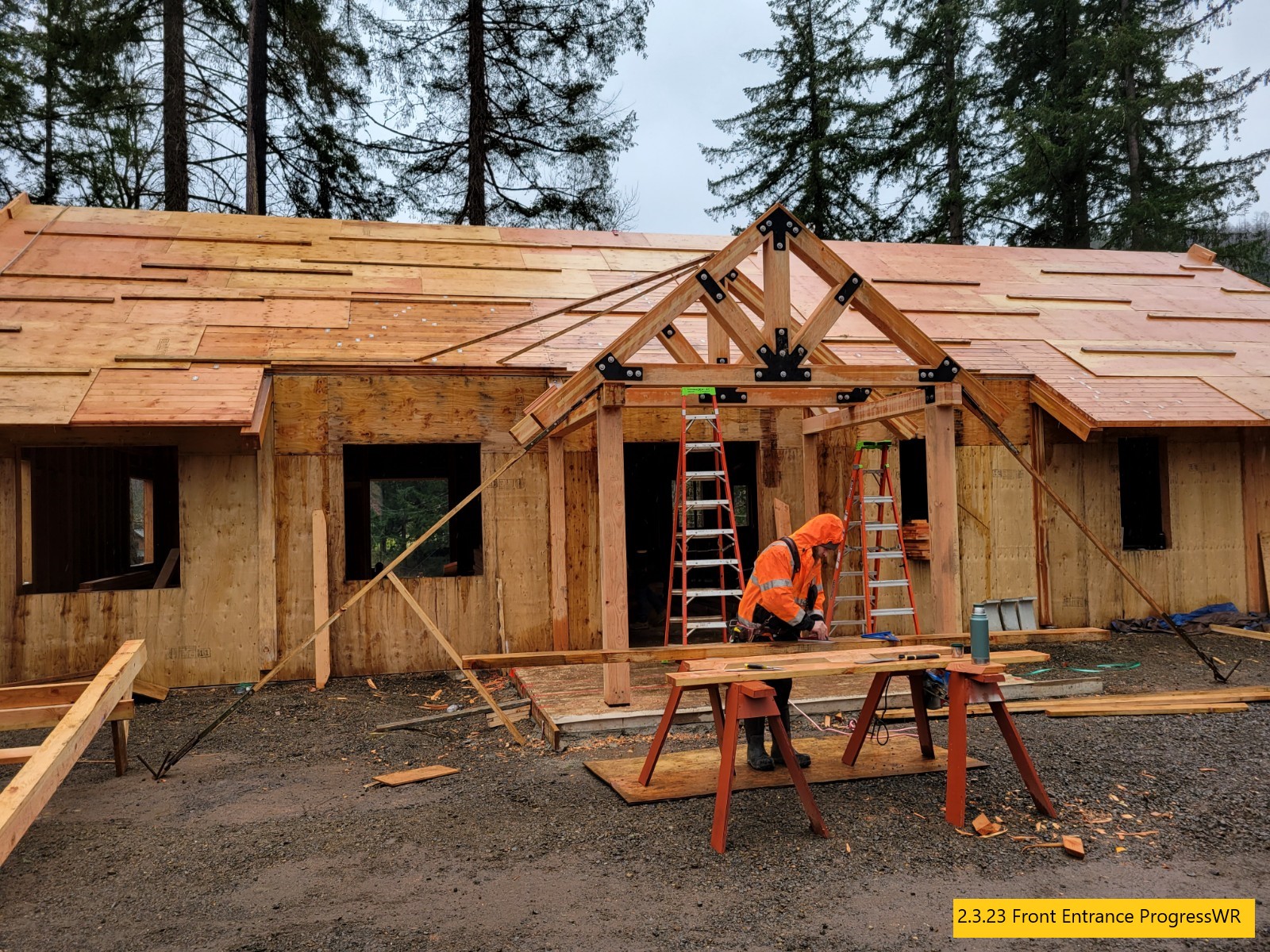

Entrance Work, Electrical Ducting, Excavations and a Fly-By!

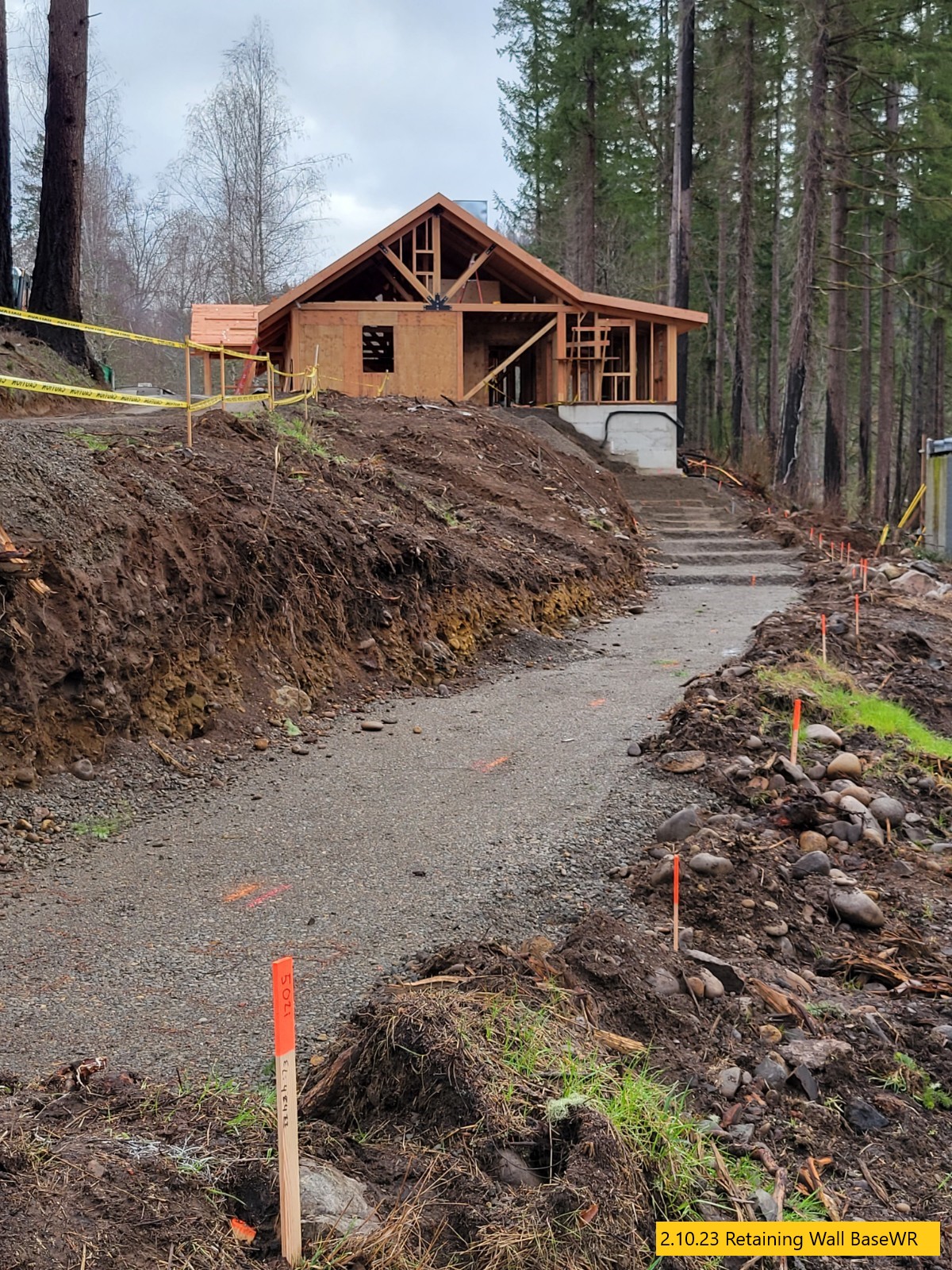

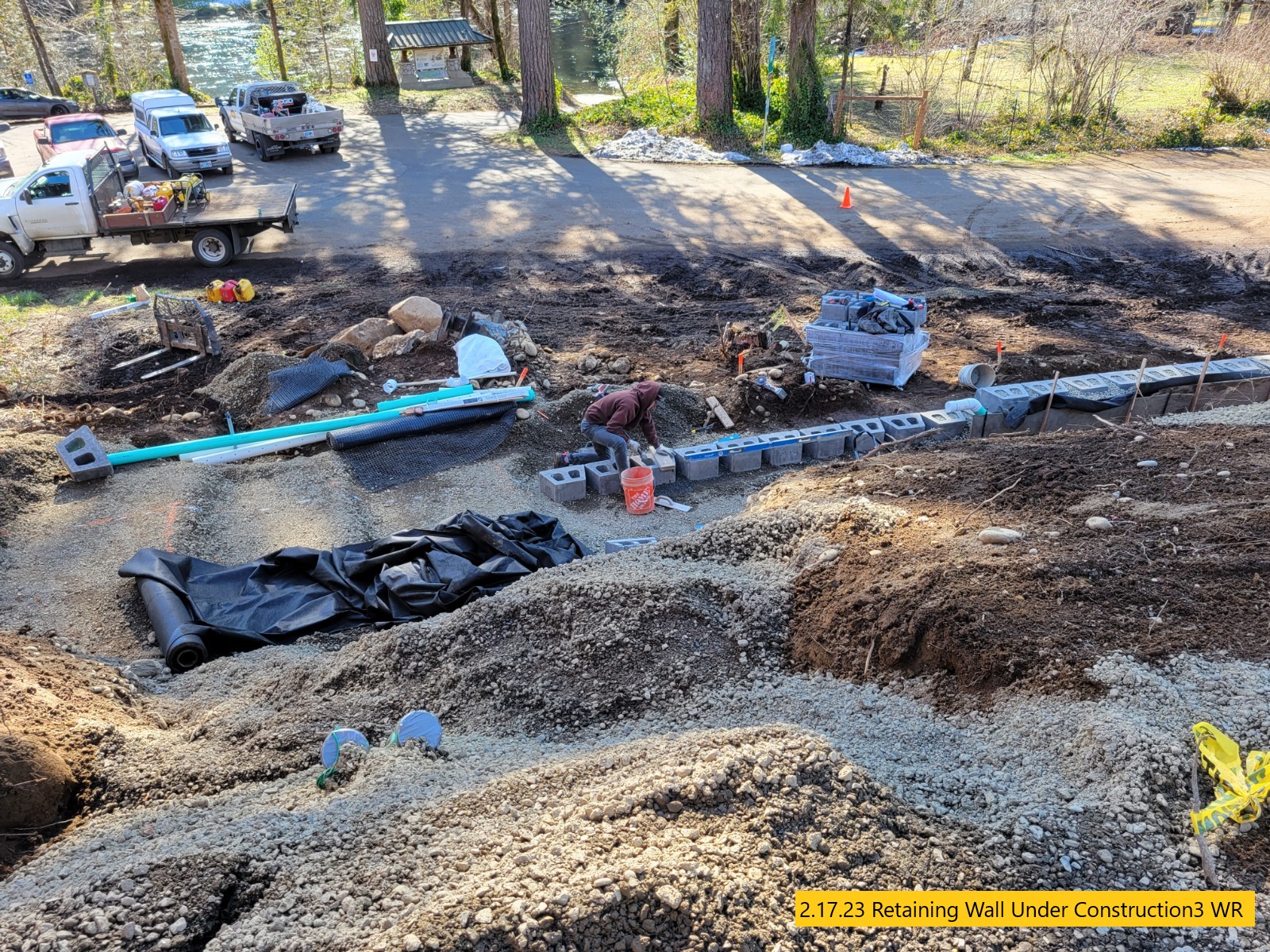

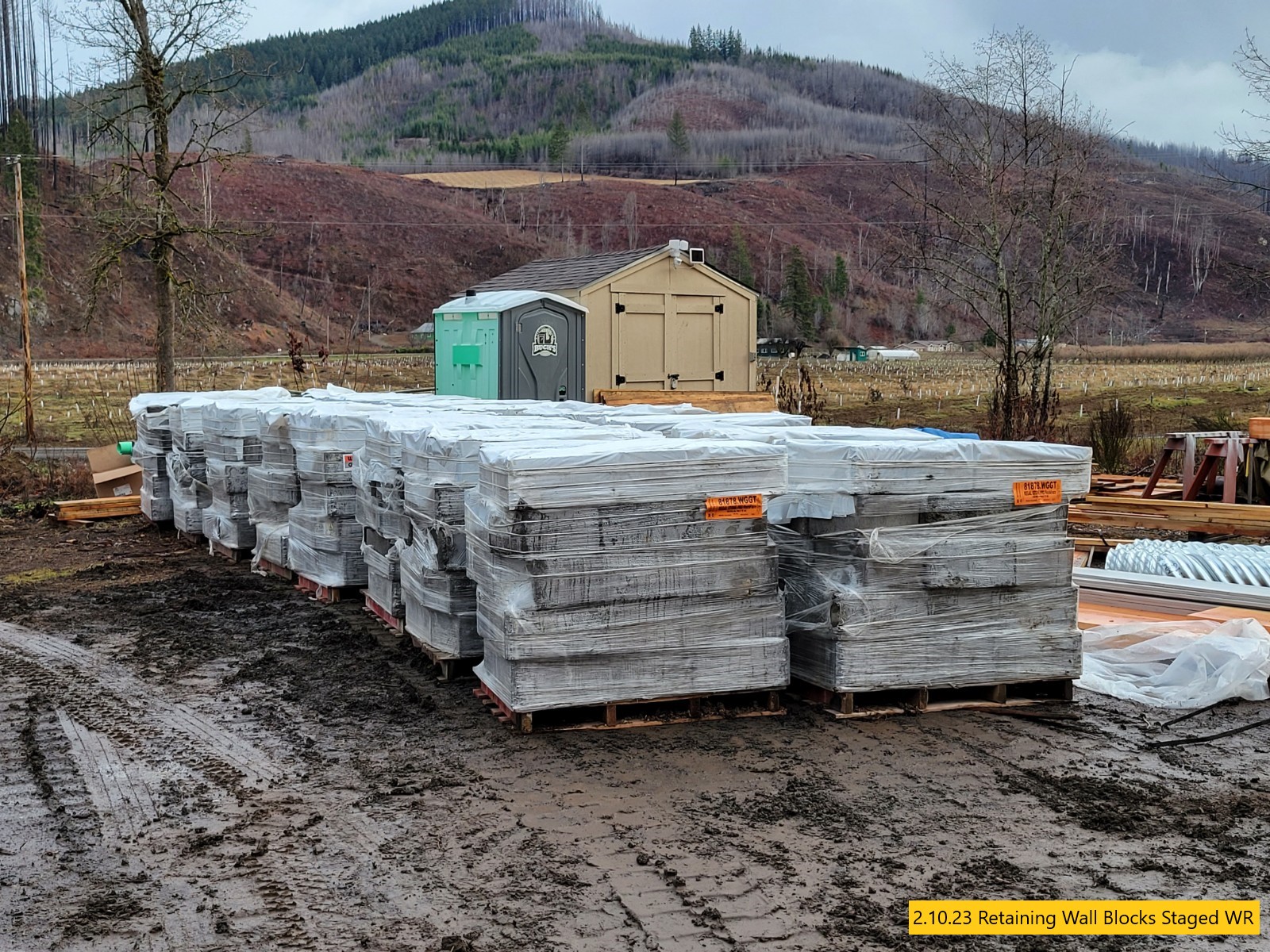

February 10, 2023
Work Continues on Retaining Wall and Roof

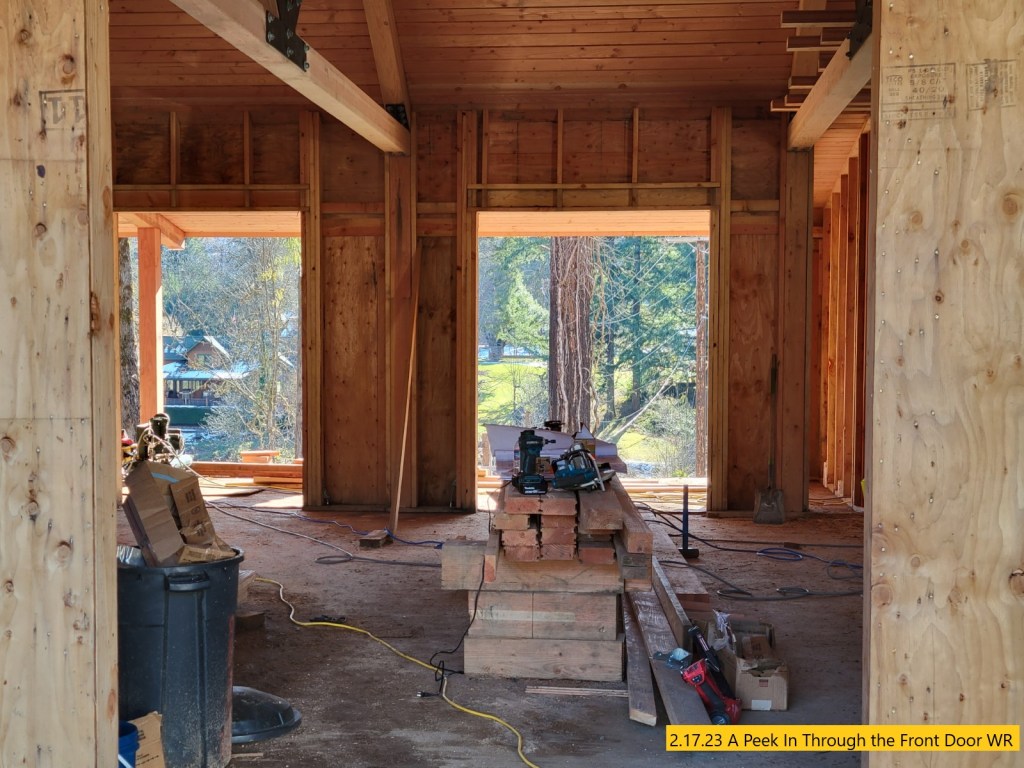

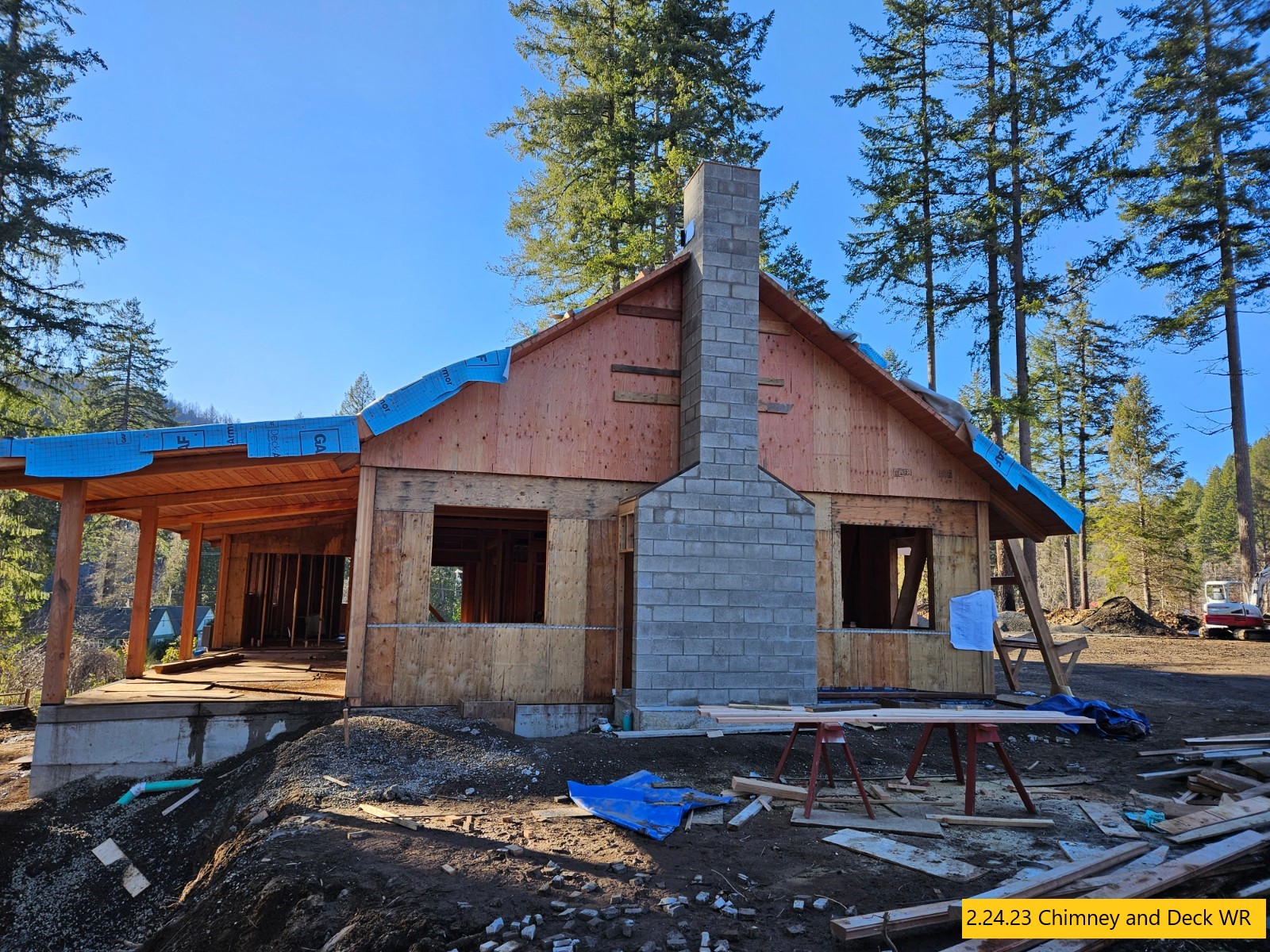

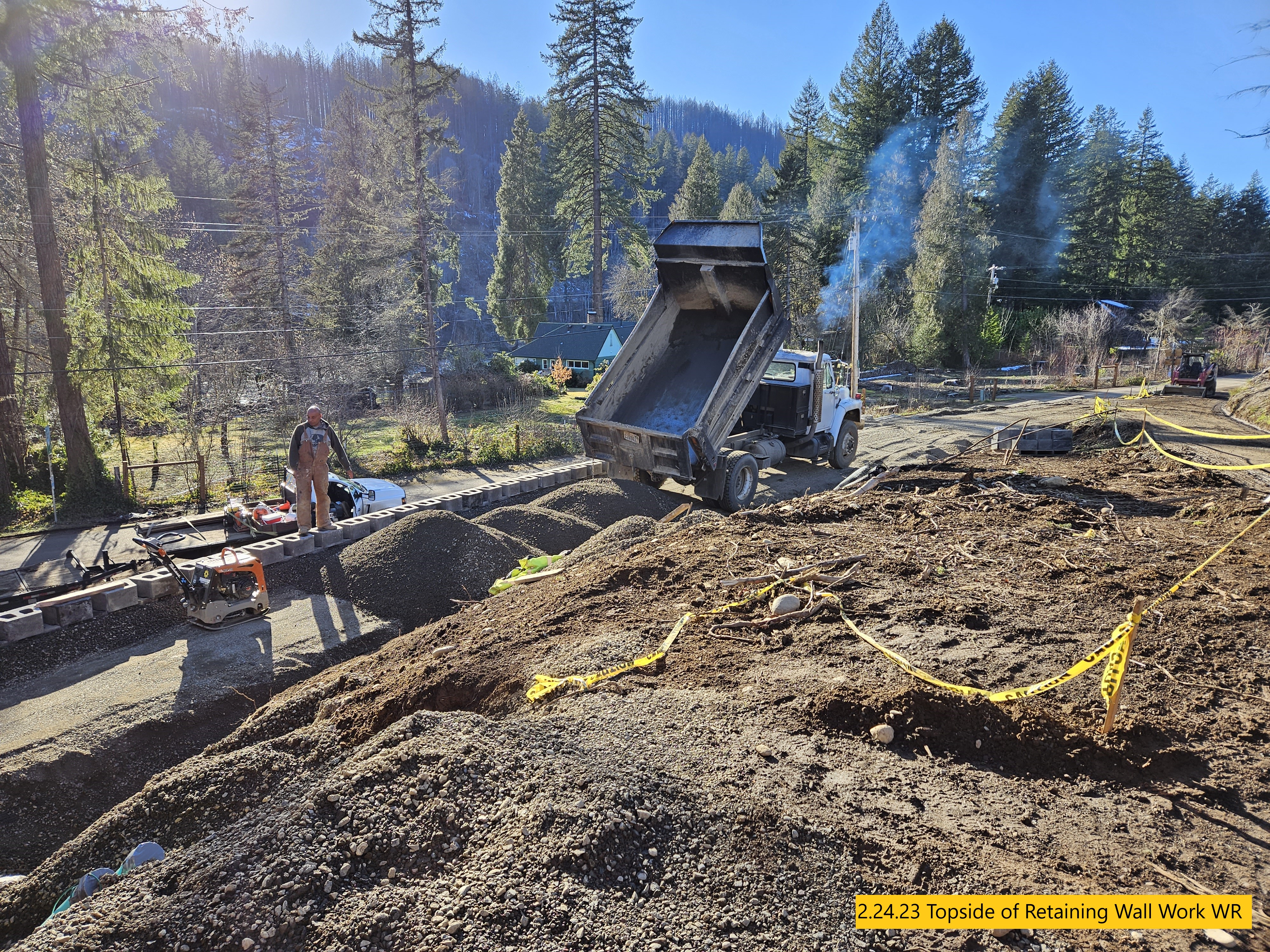

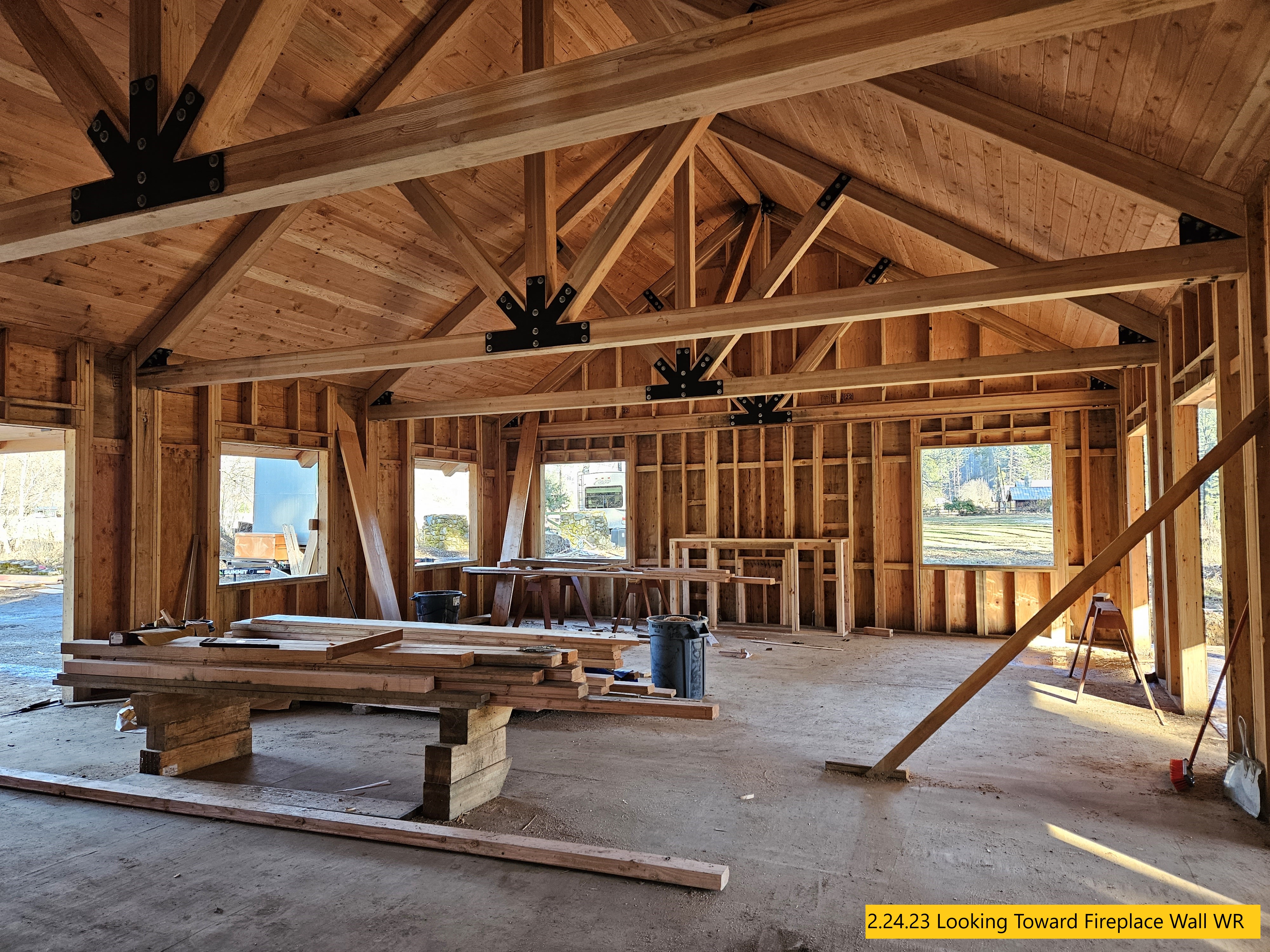

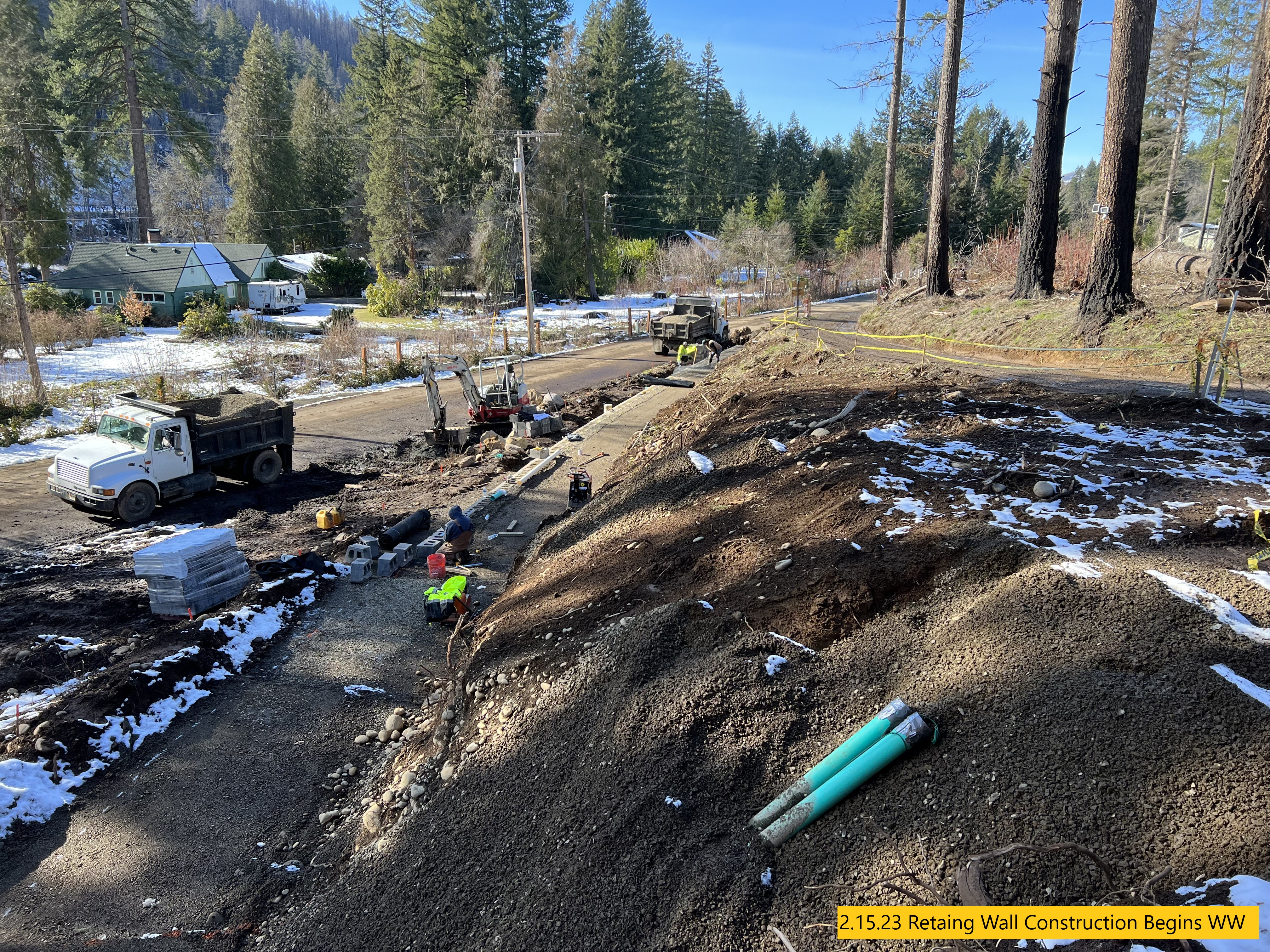

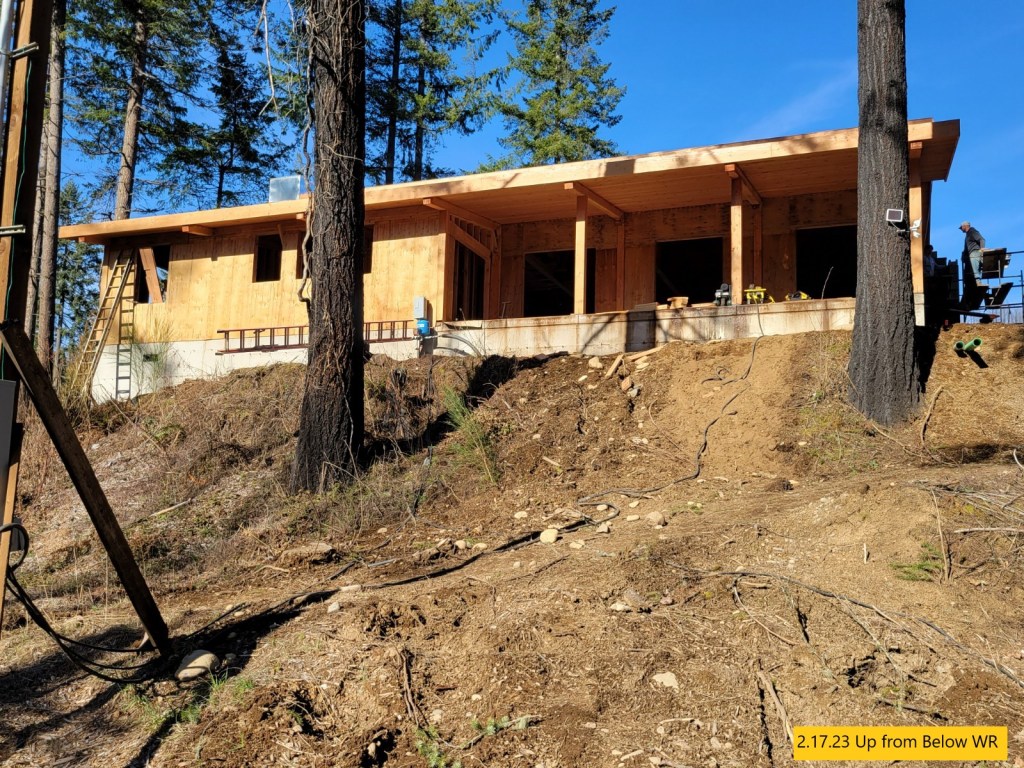

February 17, 2023

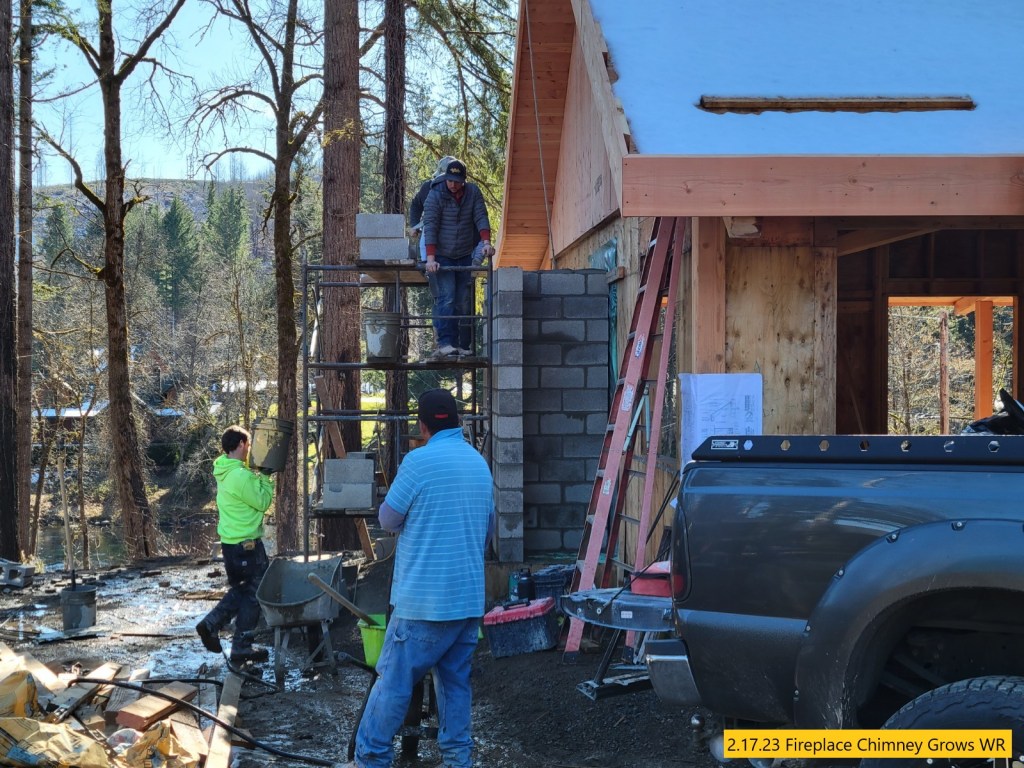

Retaining Wall Construction, Chimney Started, Carpentry Continues

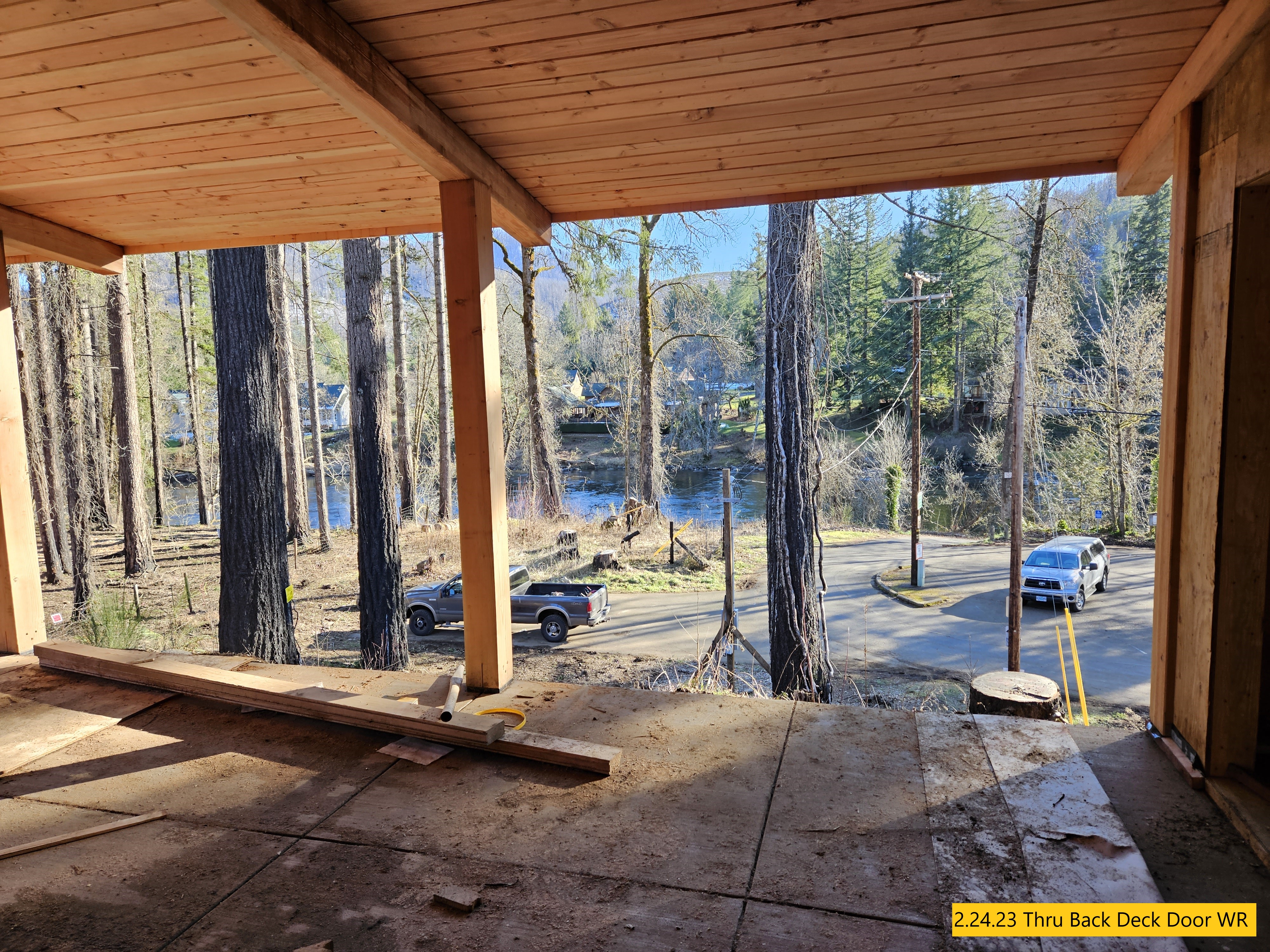

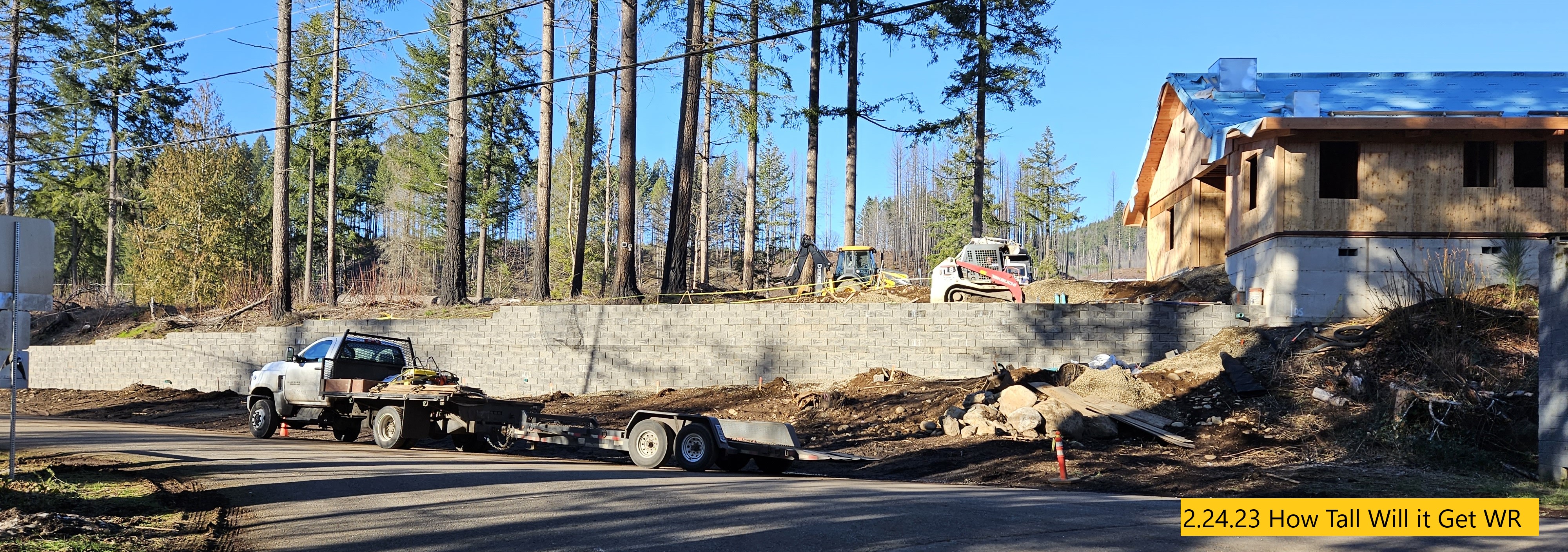

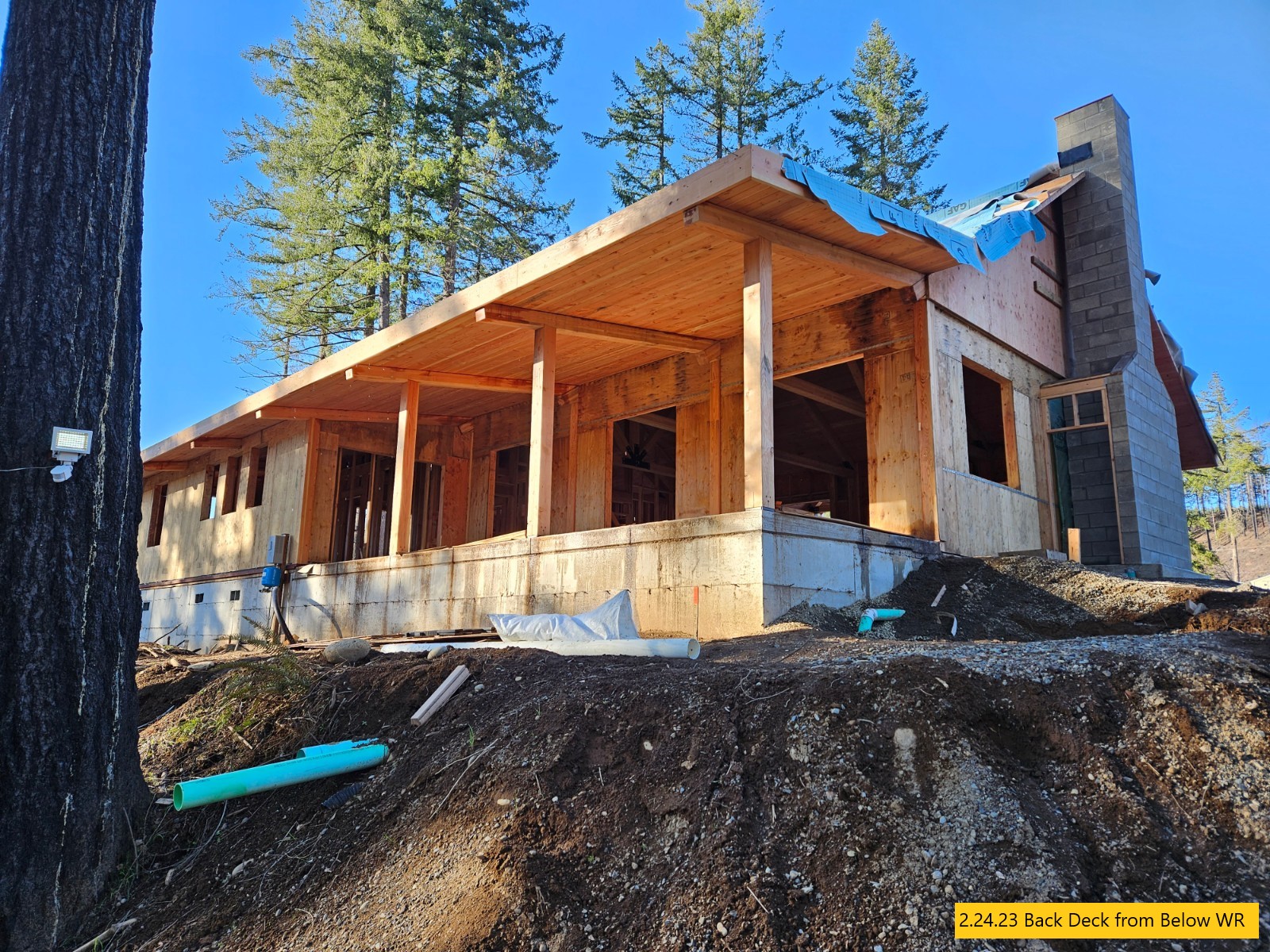

February 24, 2023

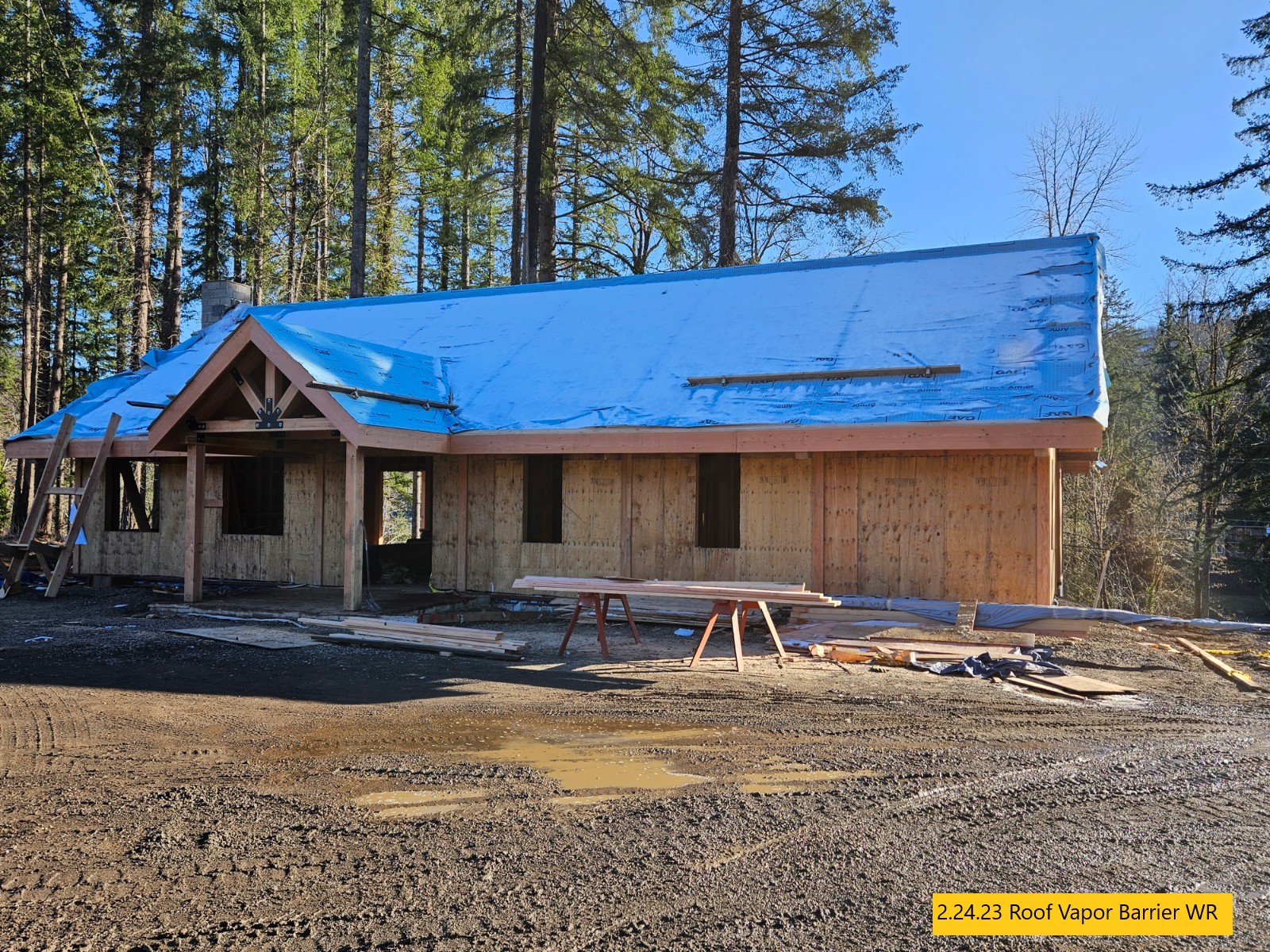

More Retaining Wall Construction, Chimney , Roof Vapor Barrier

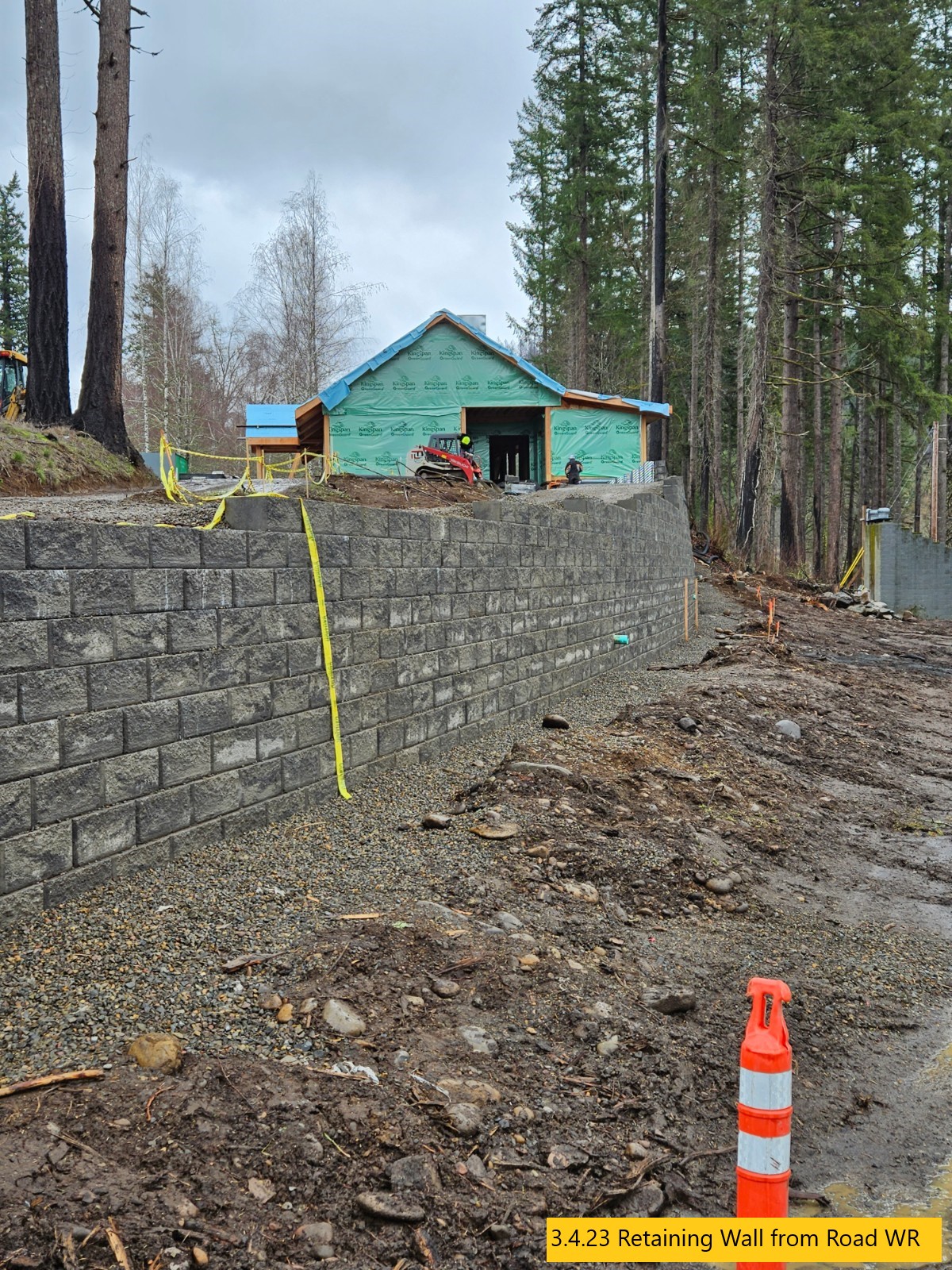

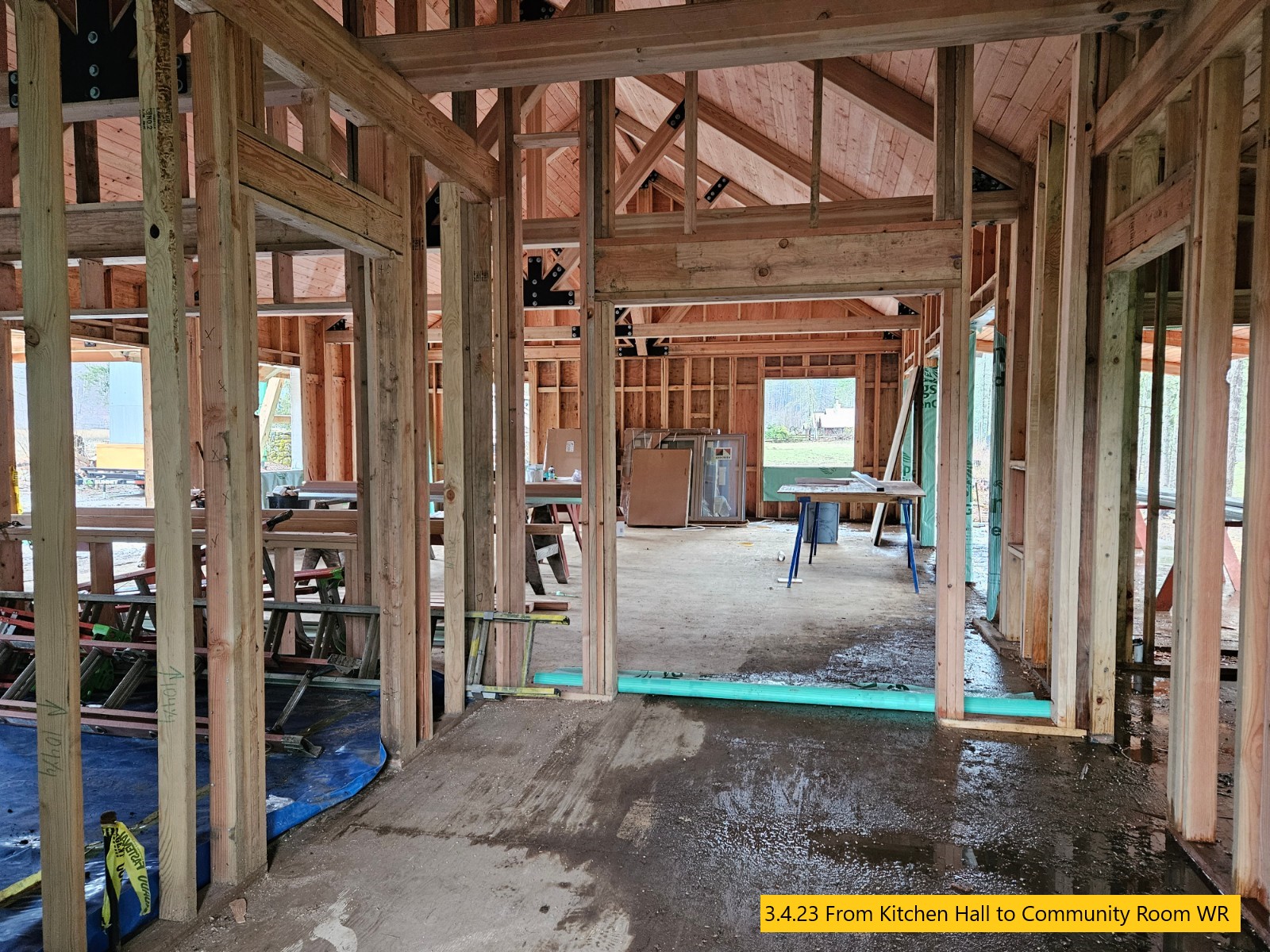

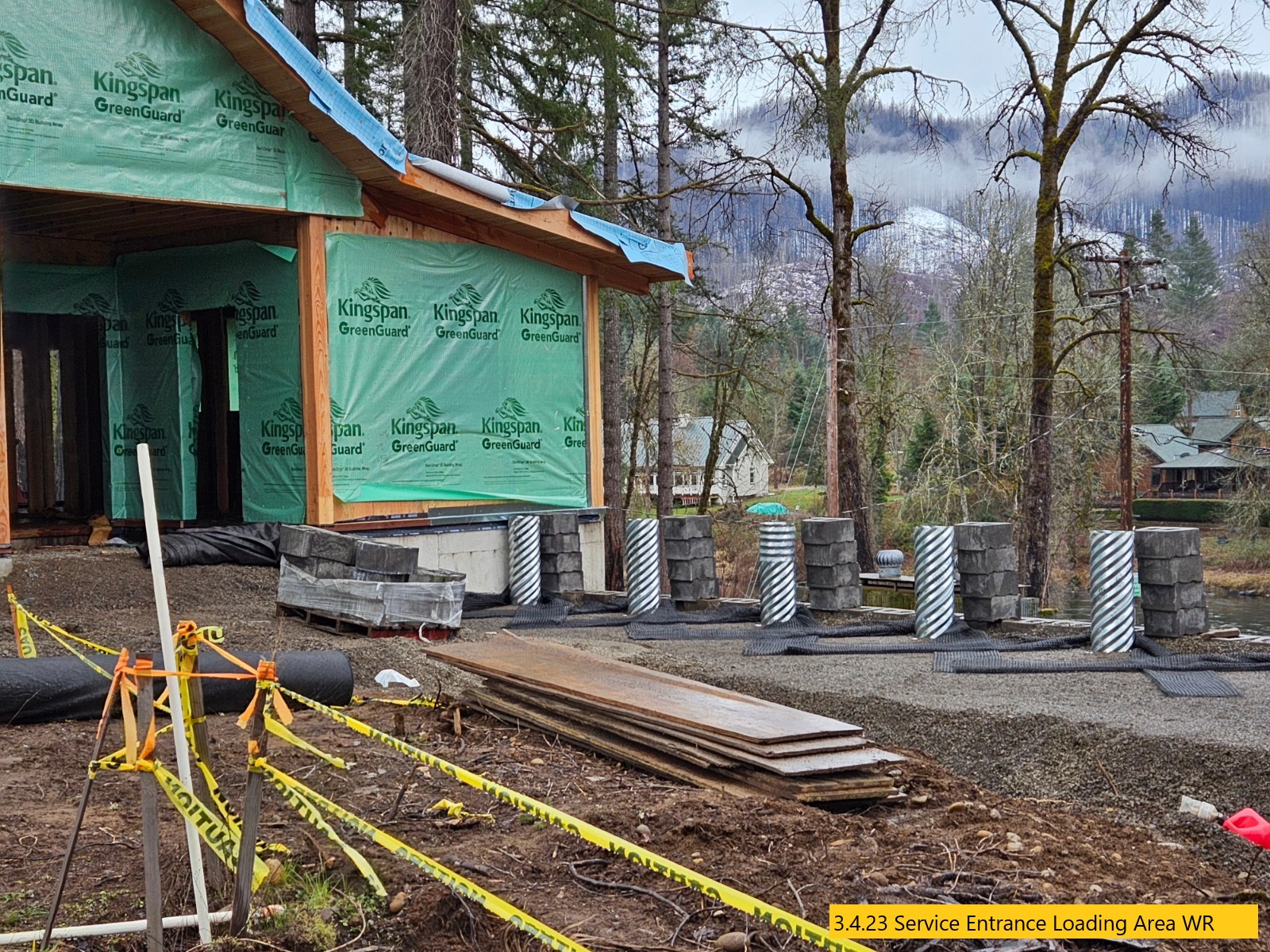

March 4, 2023

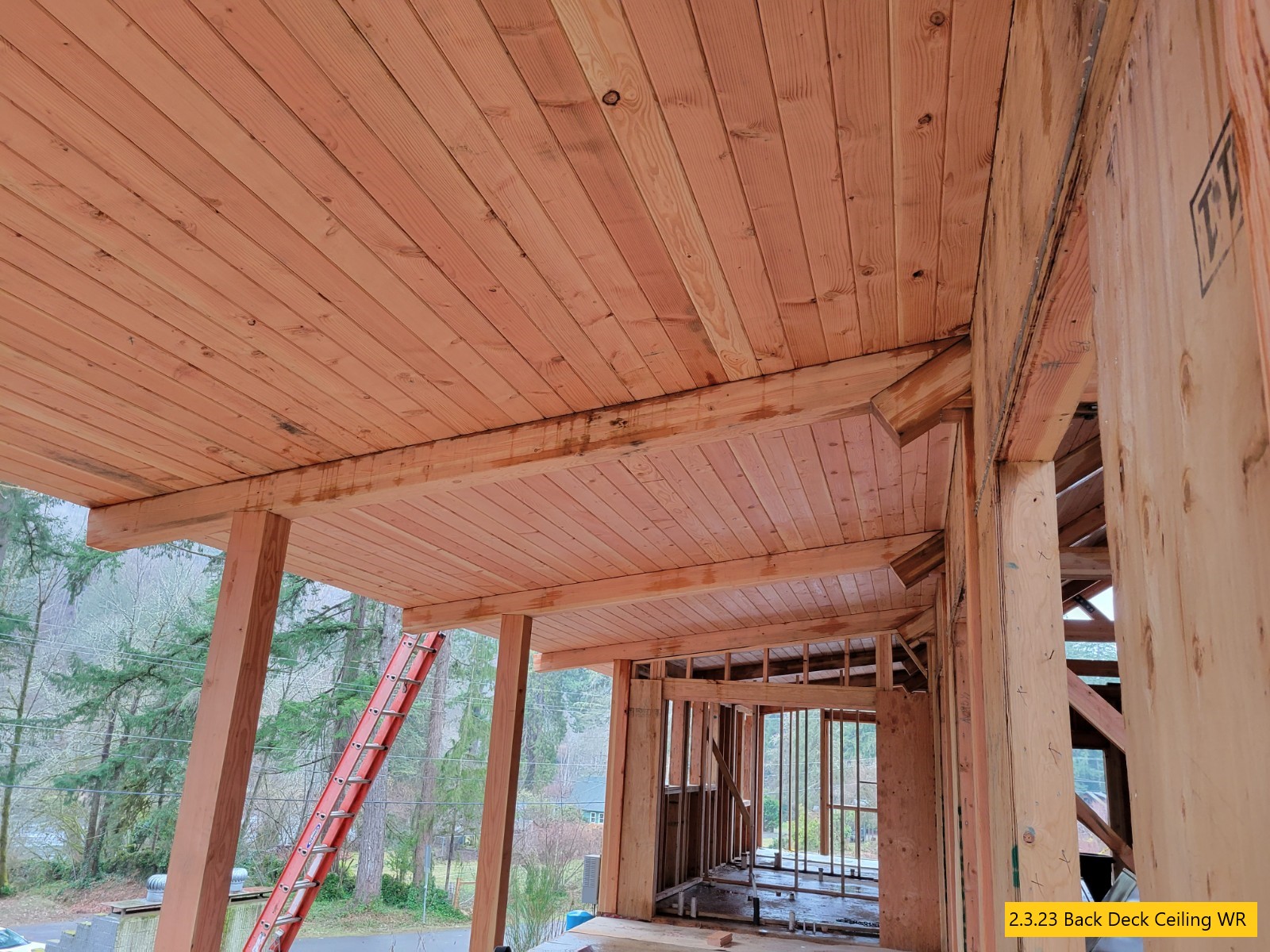

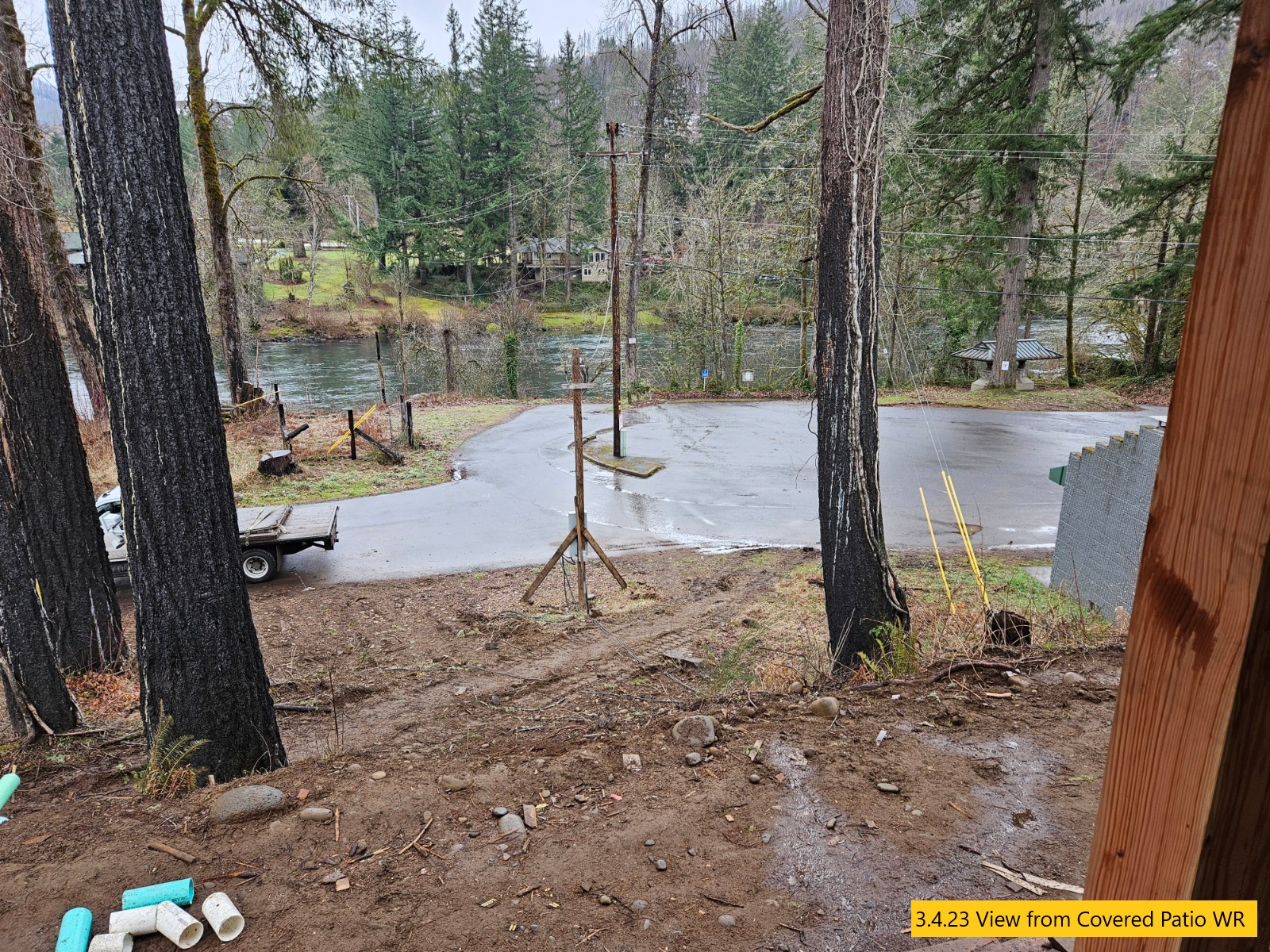

Exciting Progress Continues Outside!

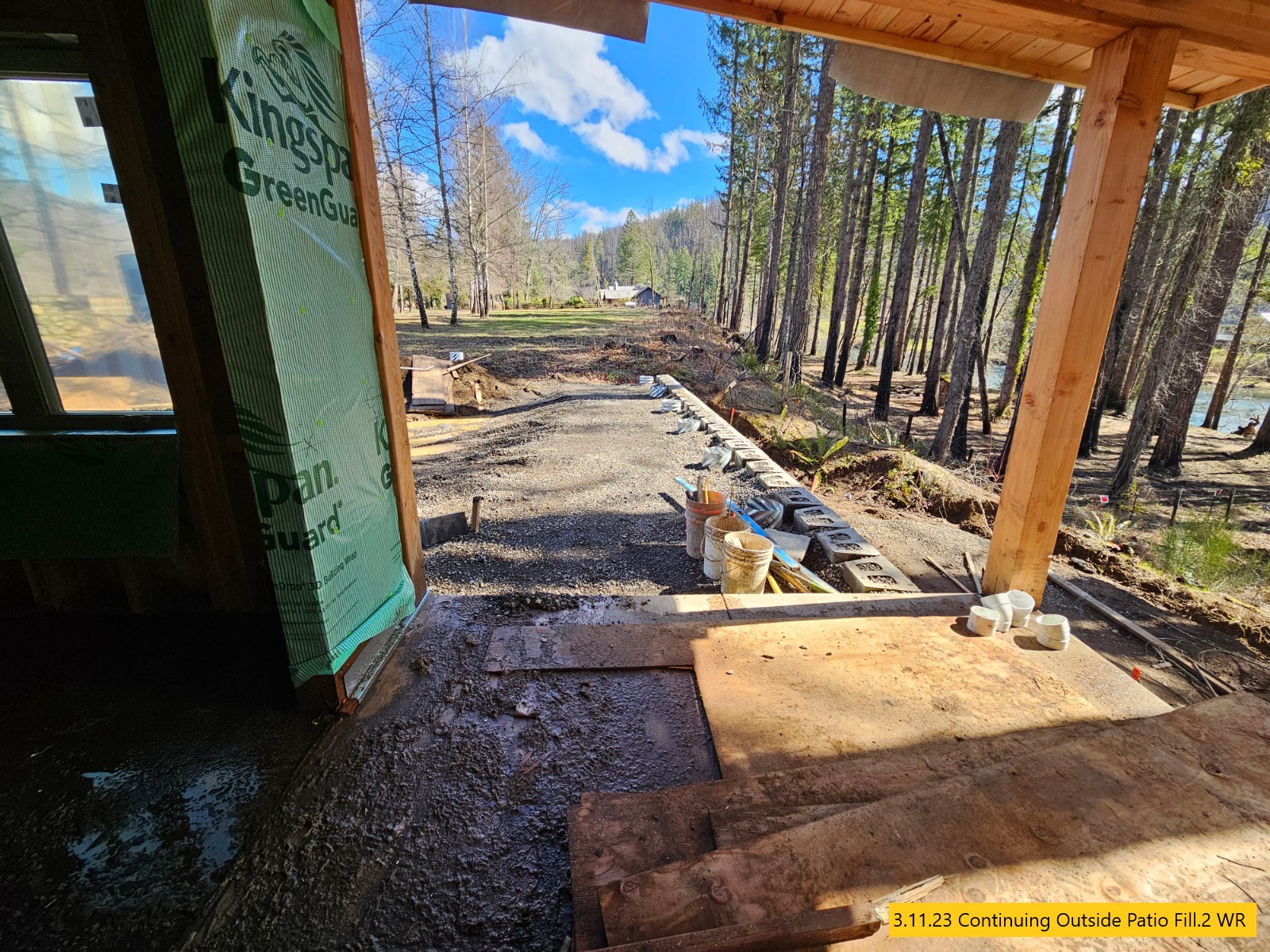

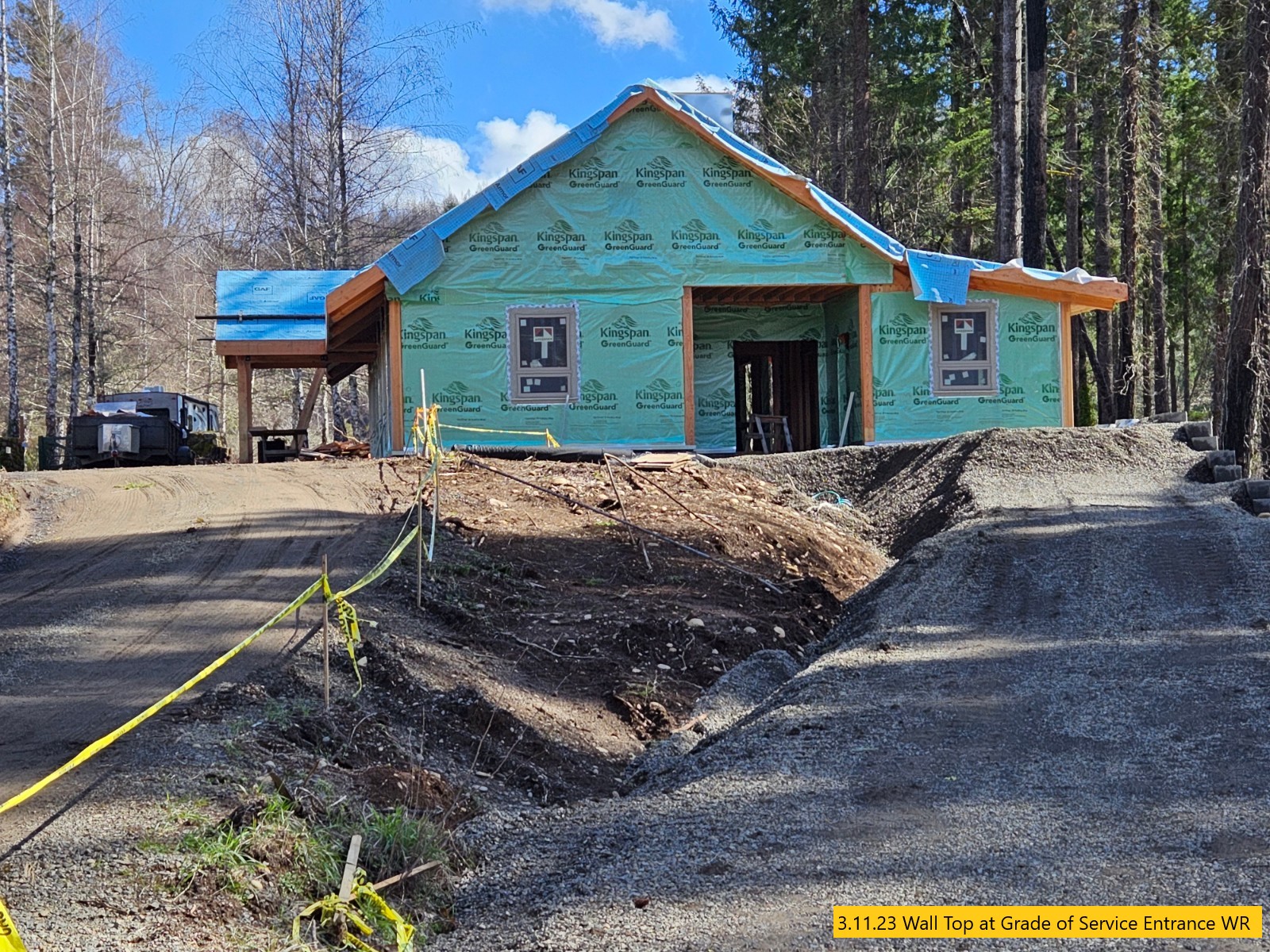

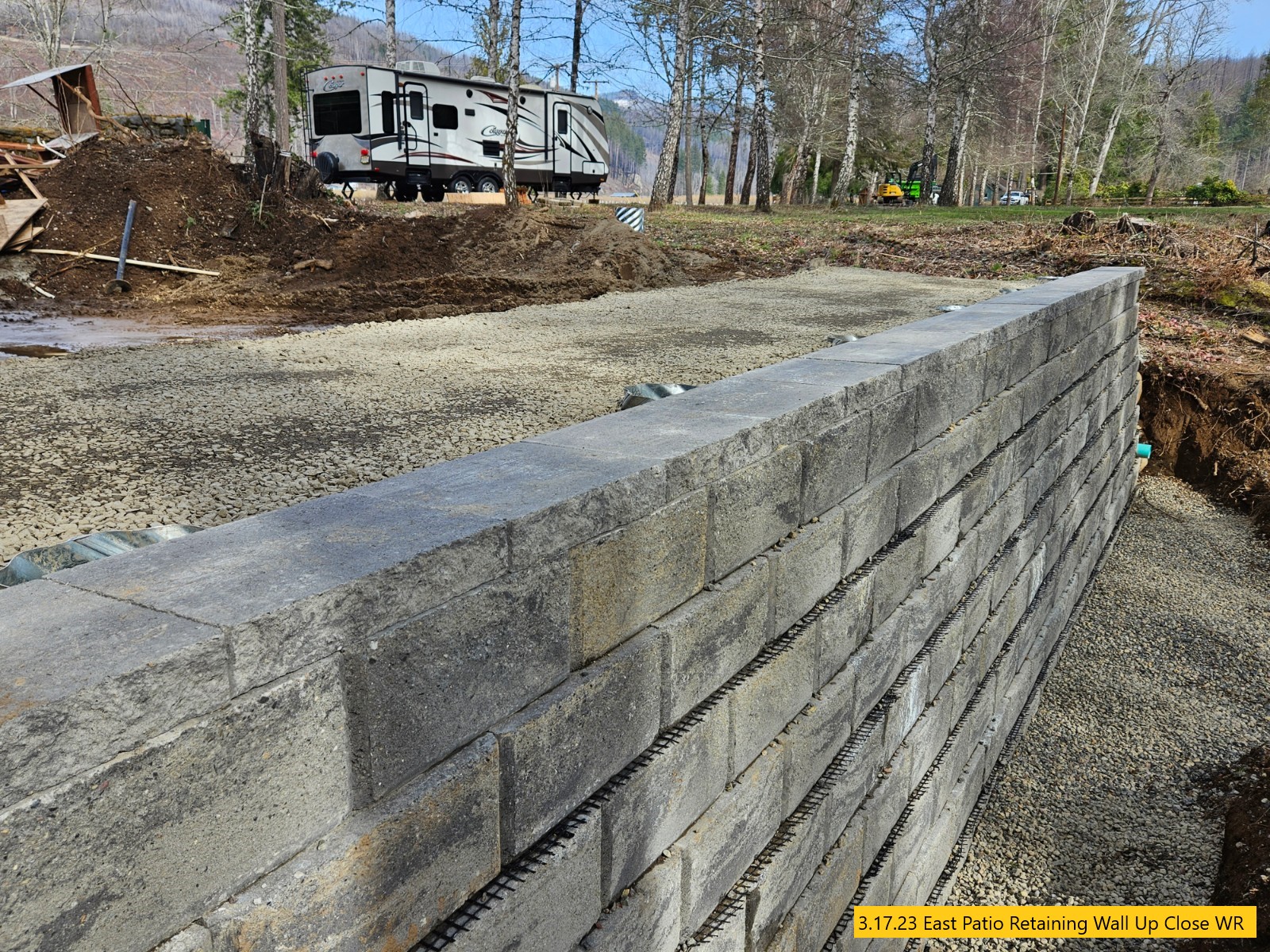

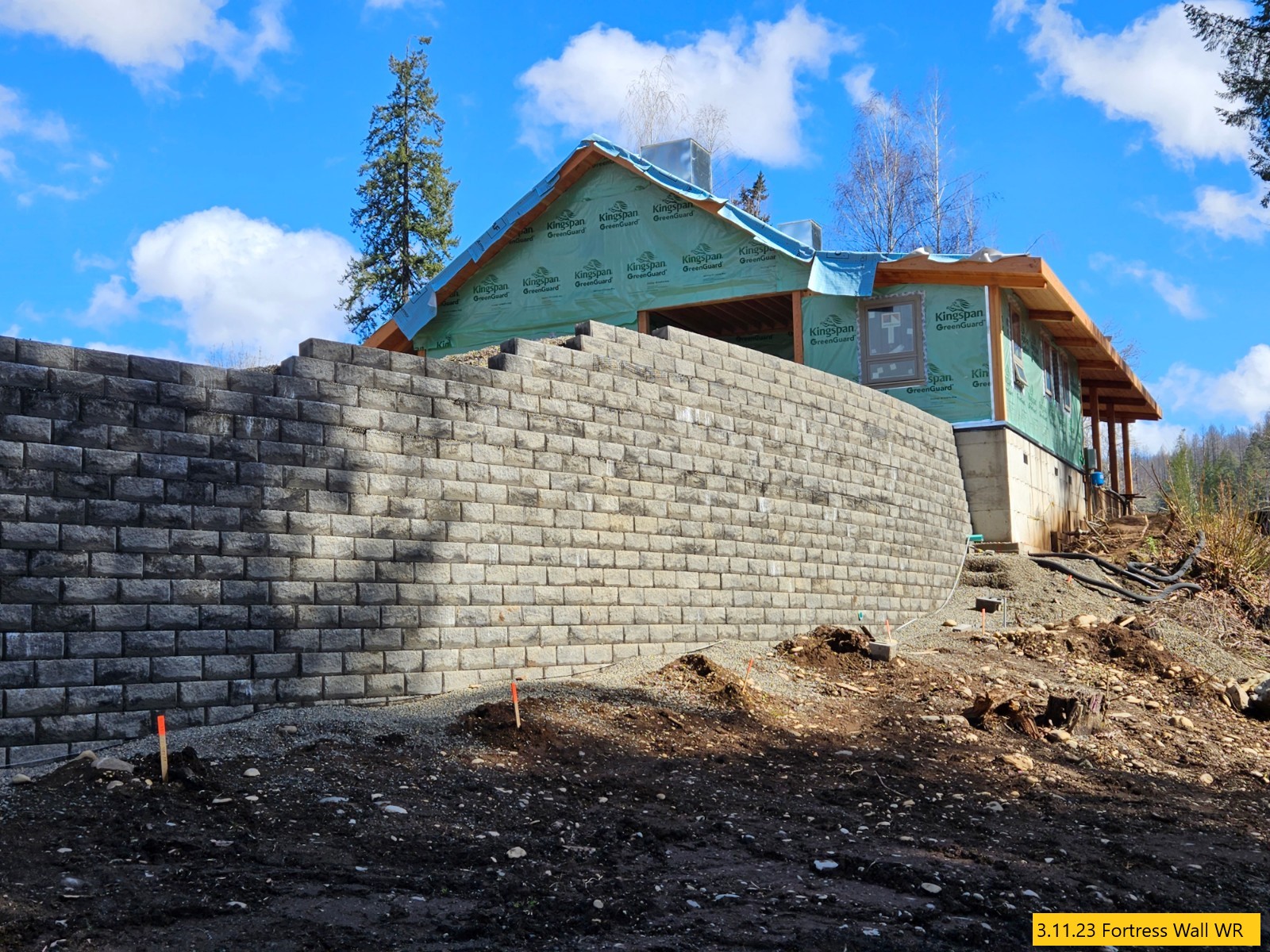

March 11, 2023

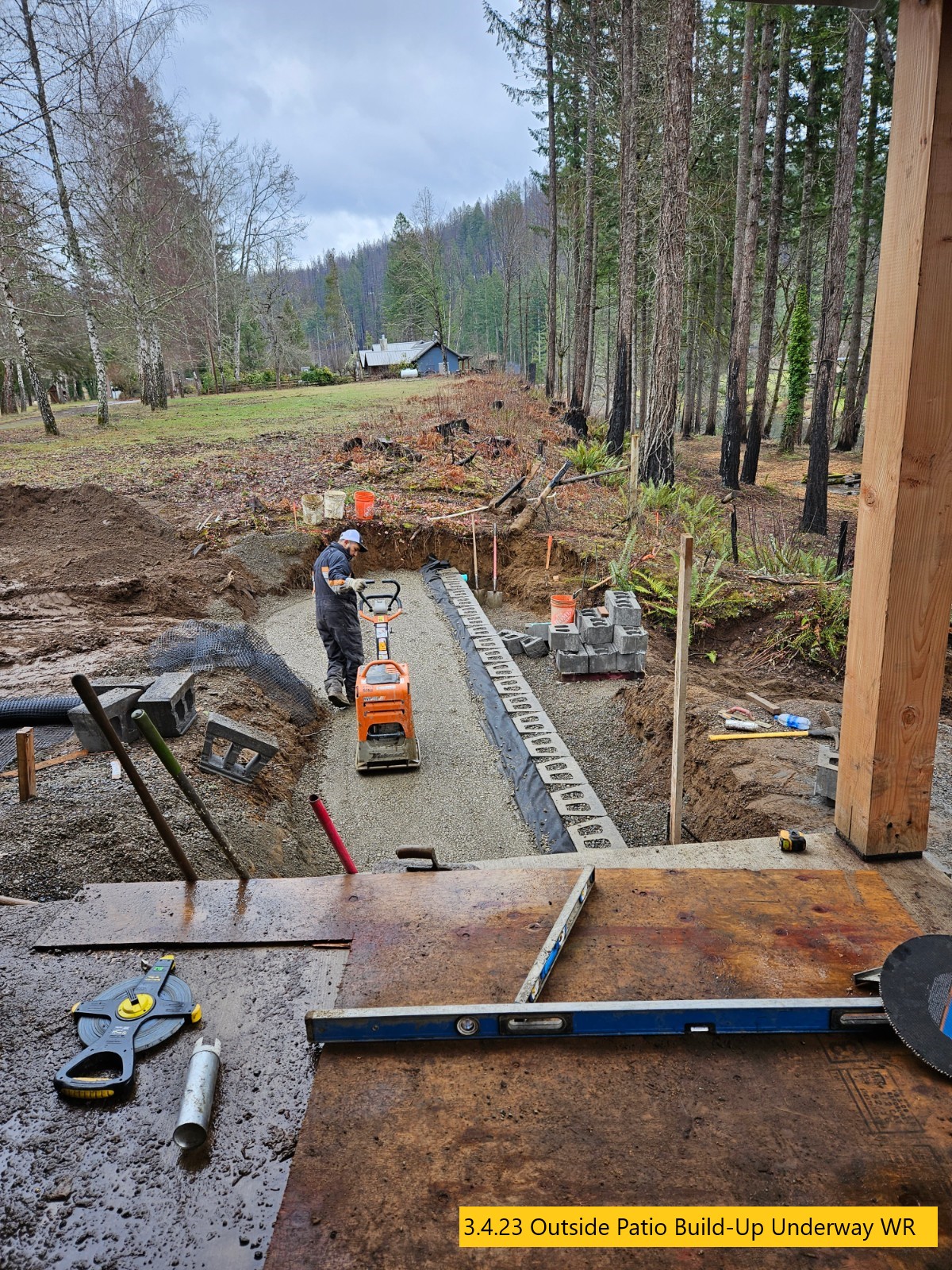

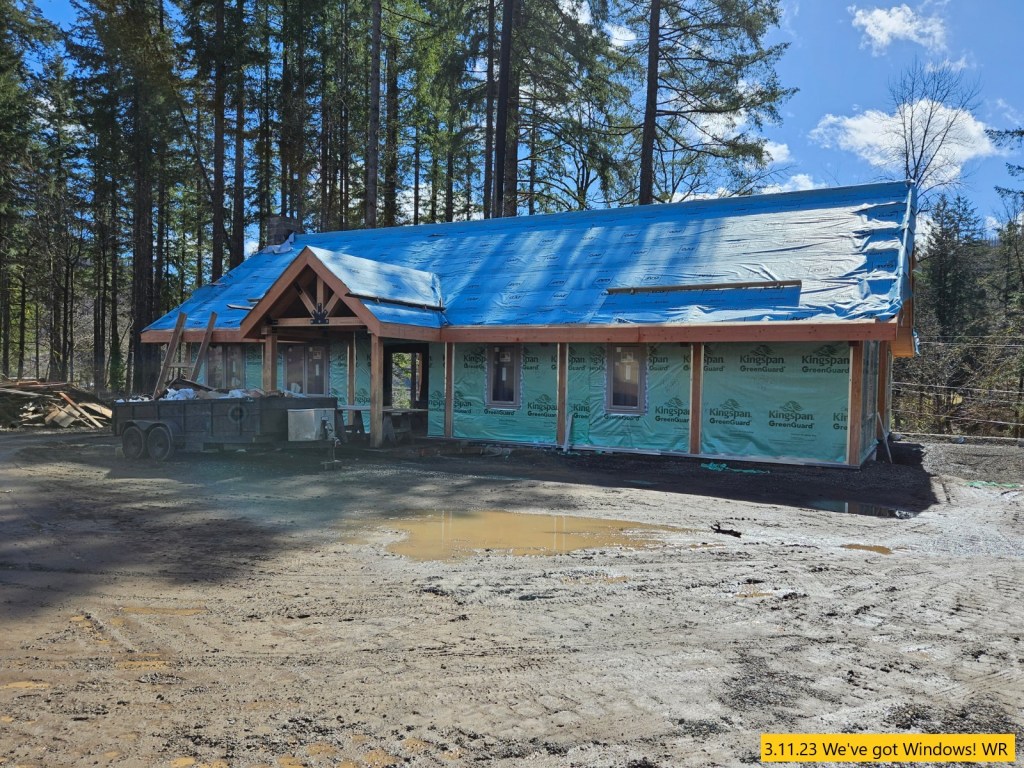

Retaining Wall, Windows, & Patios

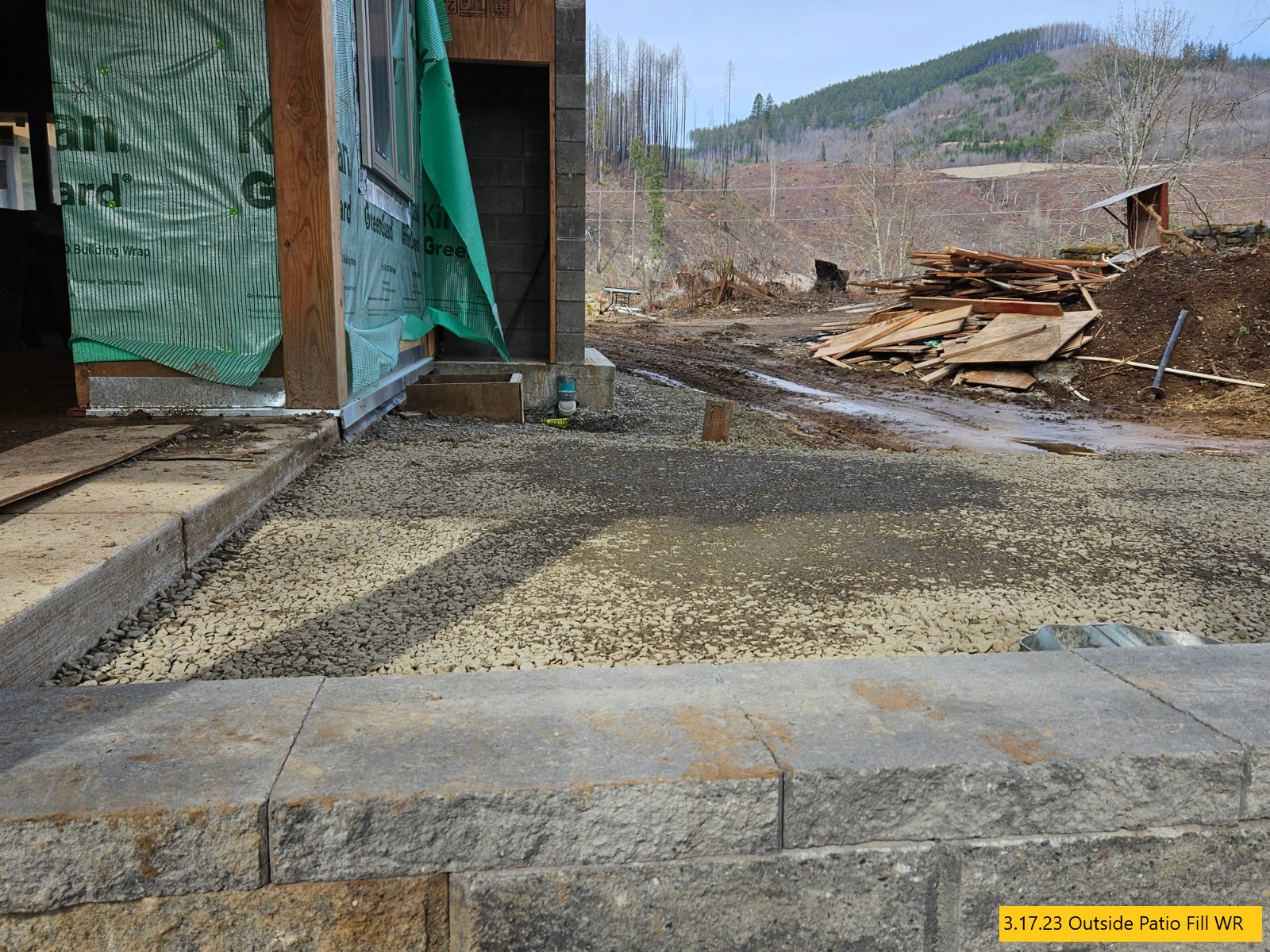

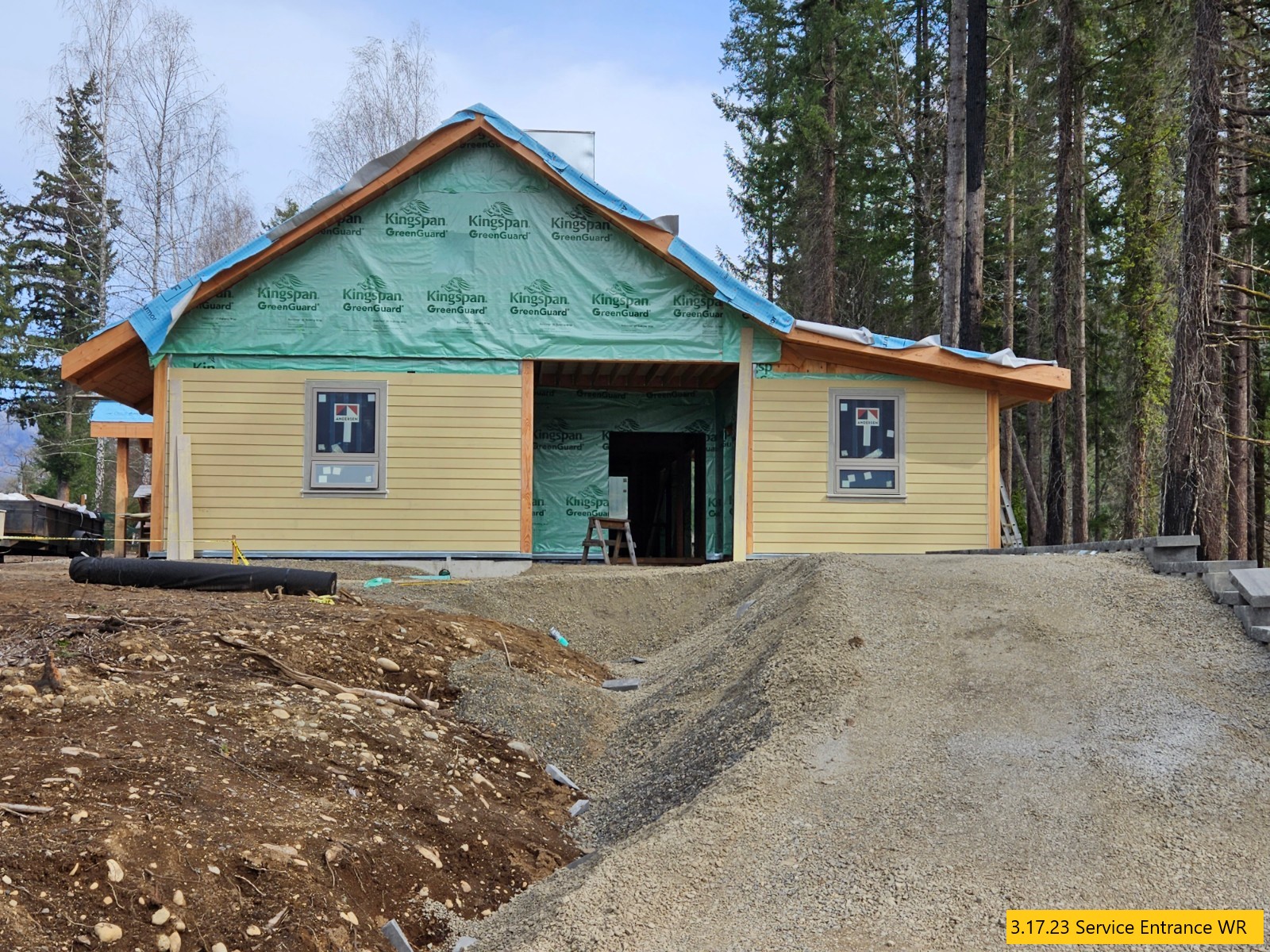

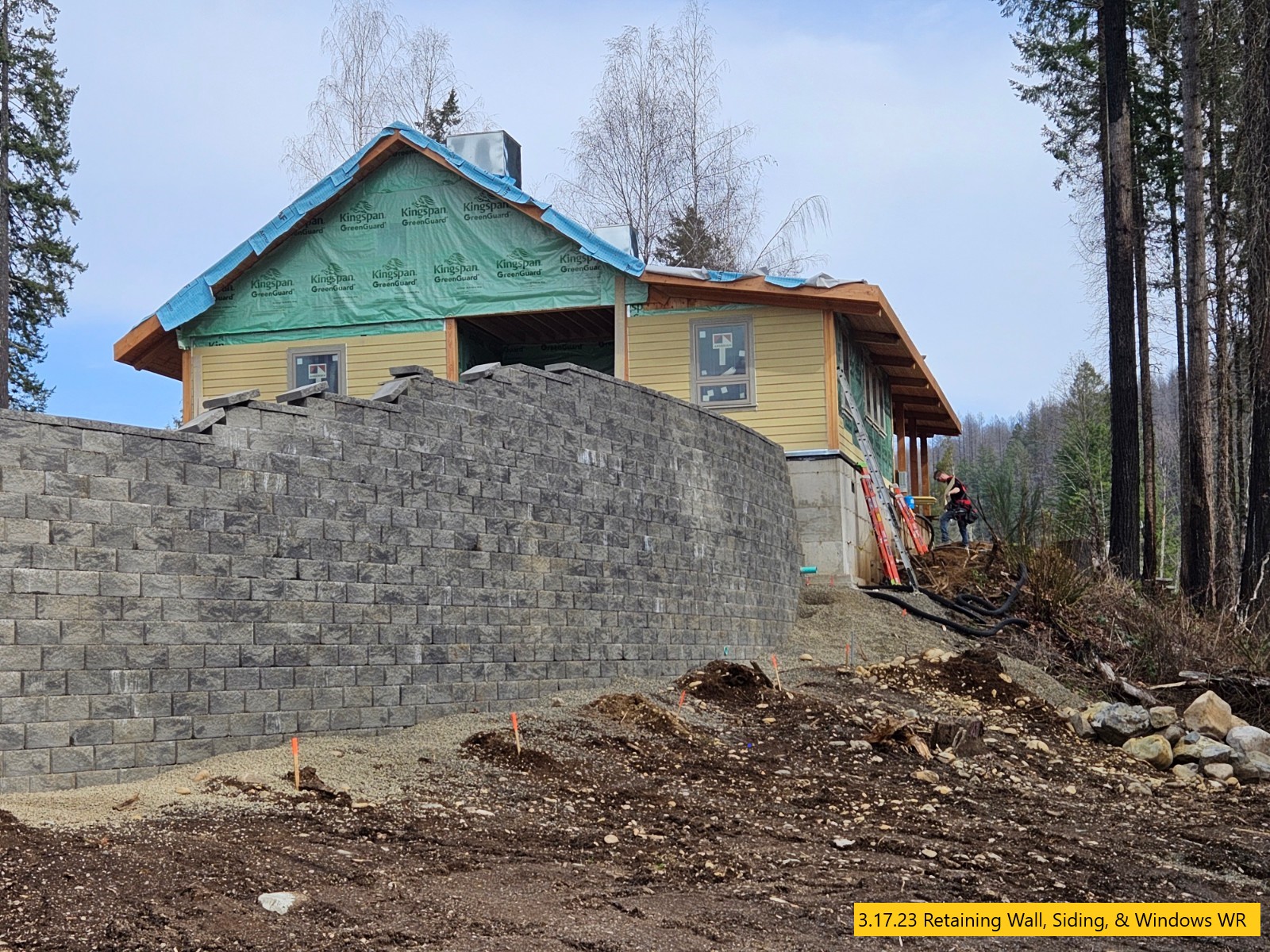

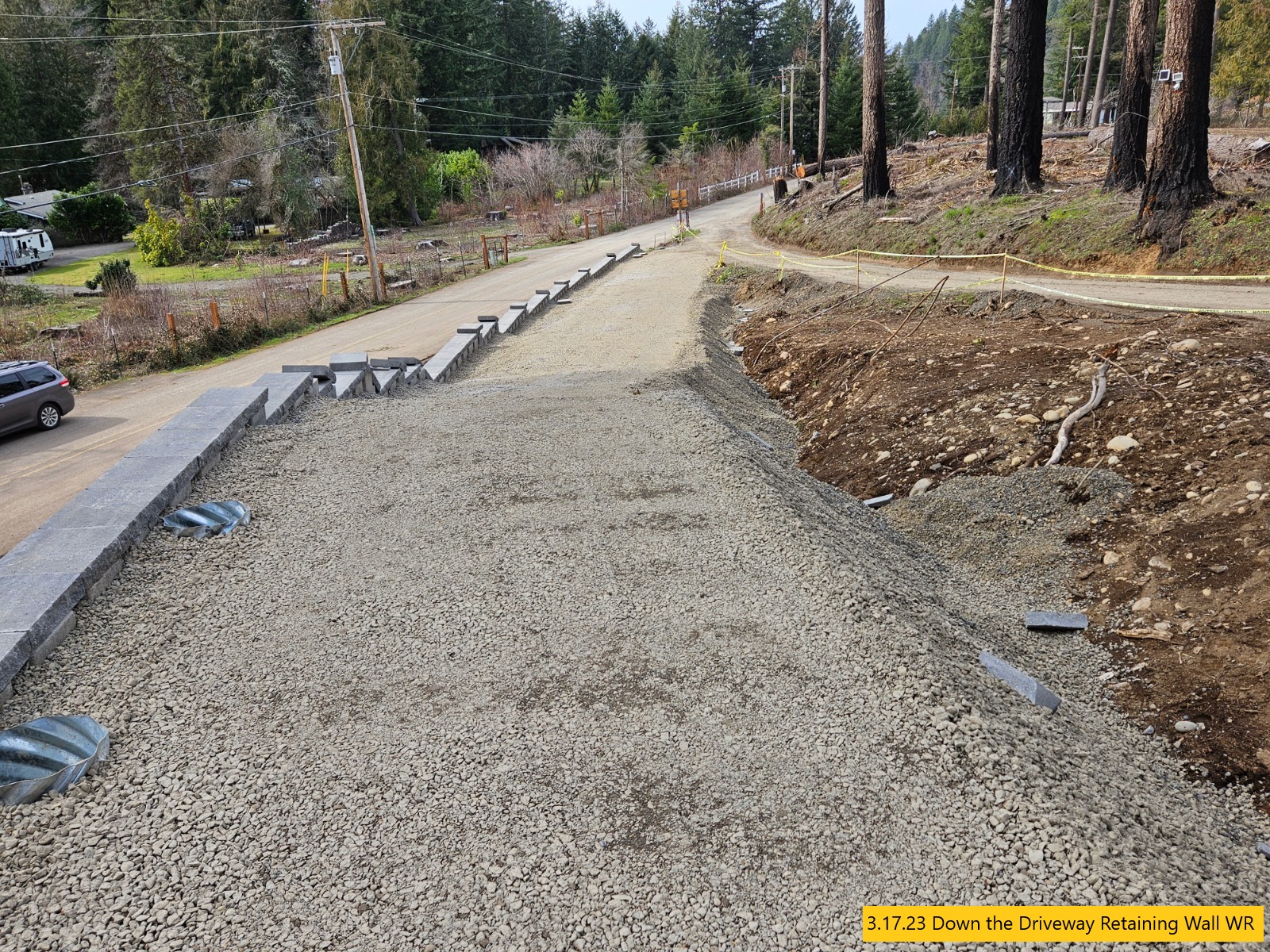

March 17, 2023

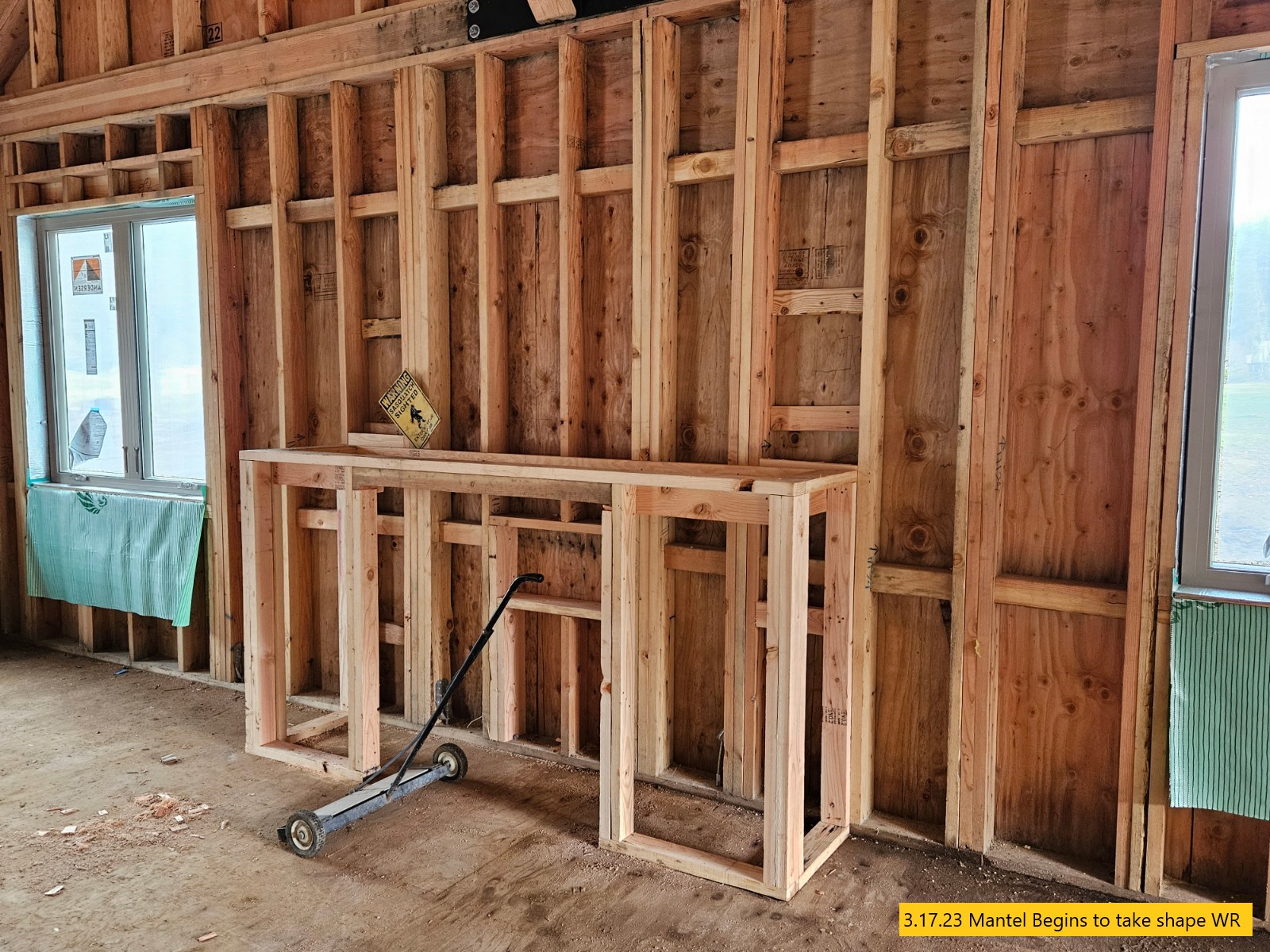

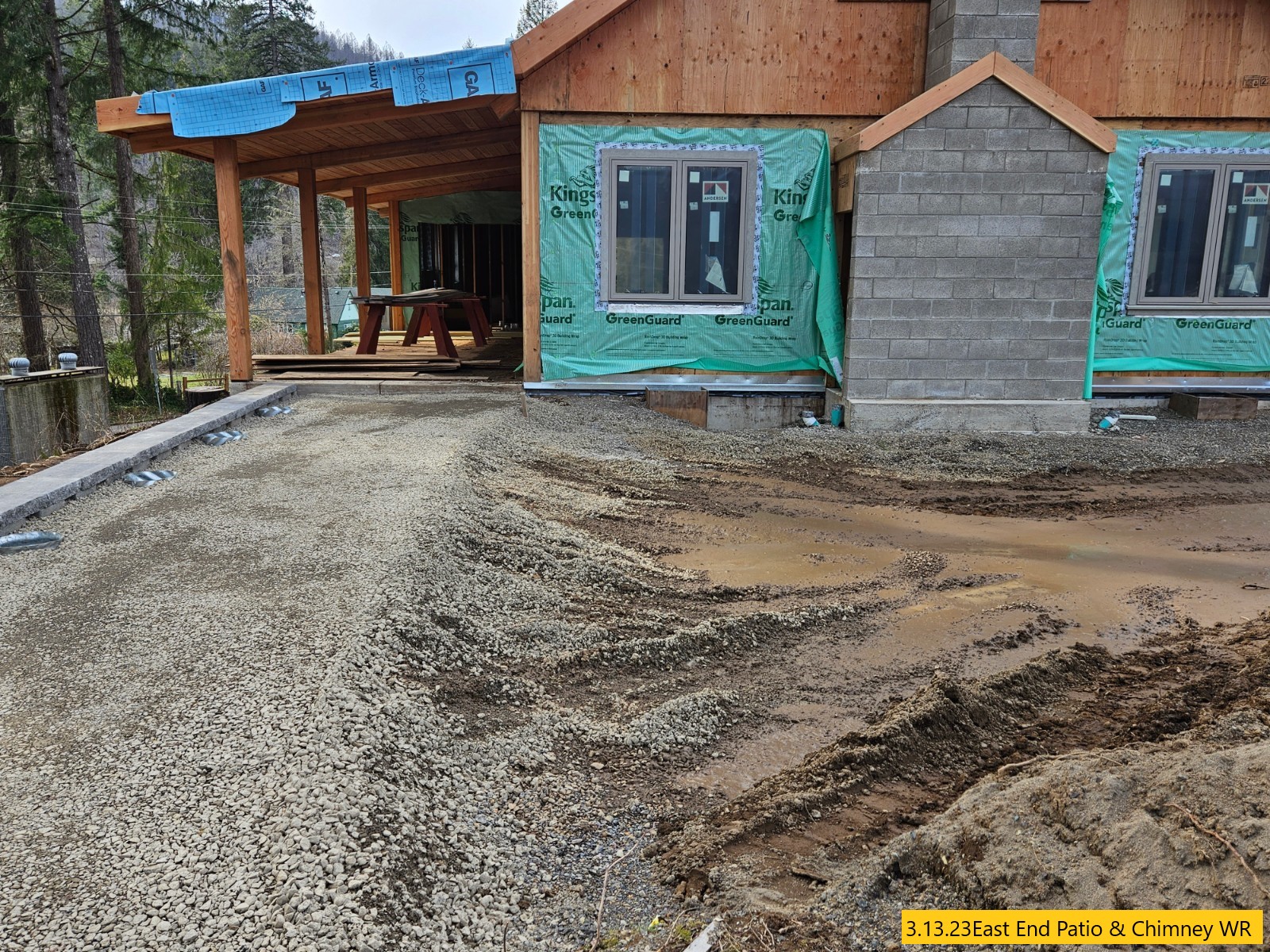

Mantel, Patio, Siding, & Retaining Walls

March 24, 2023

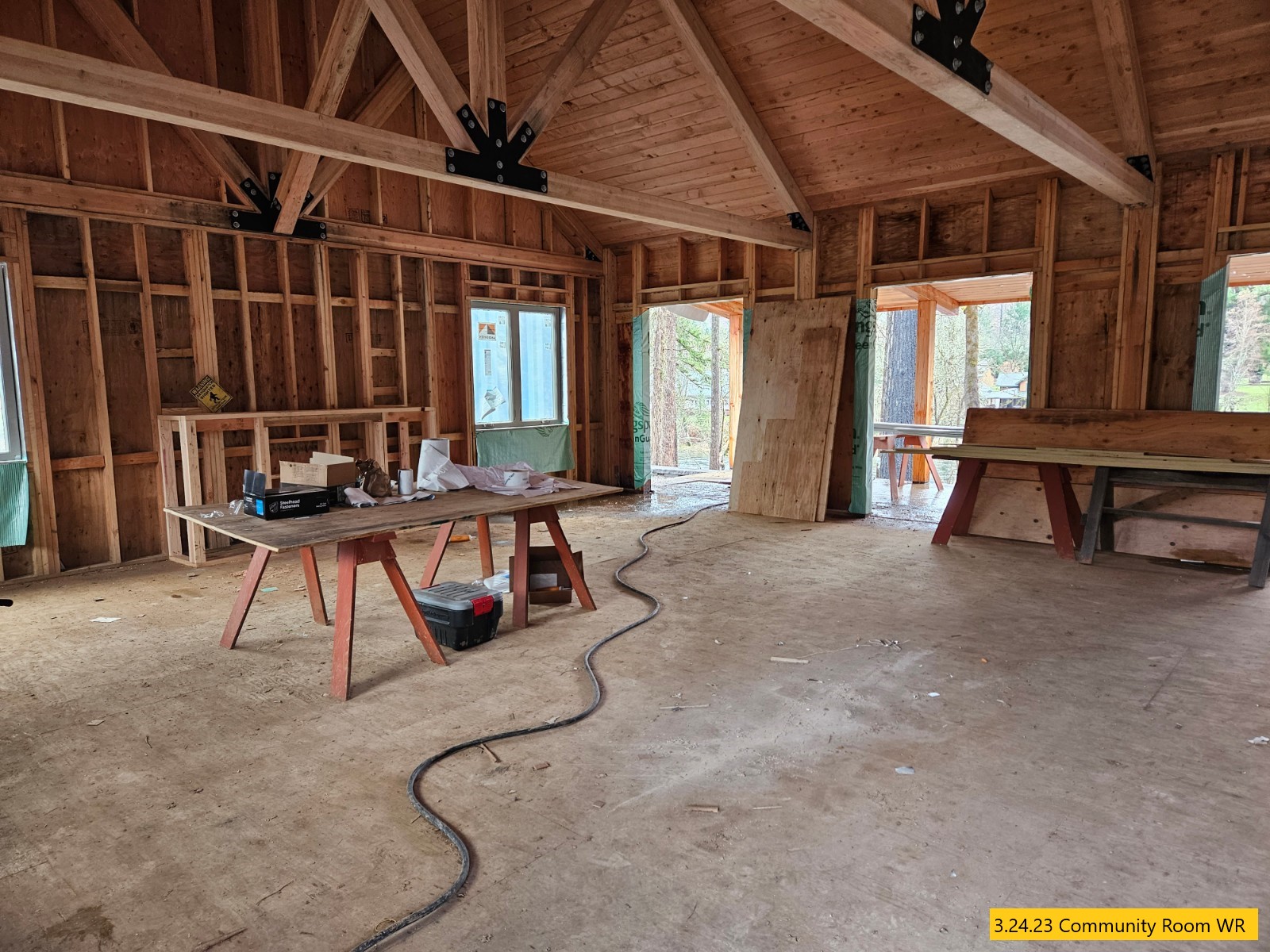

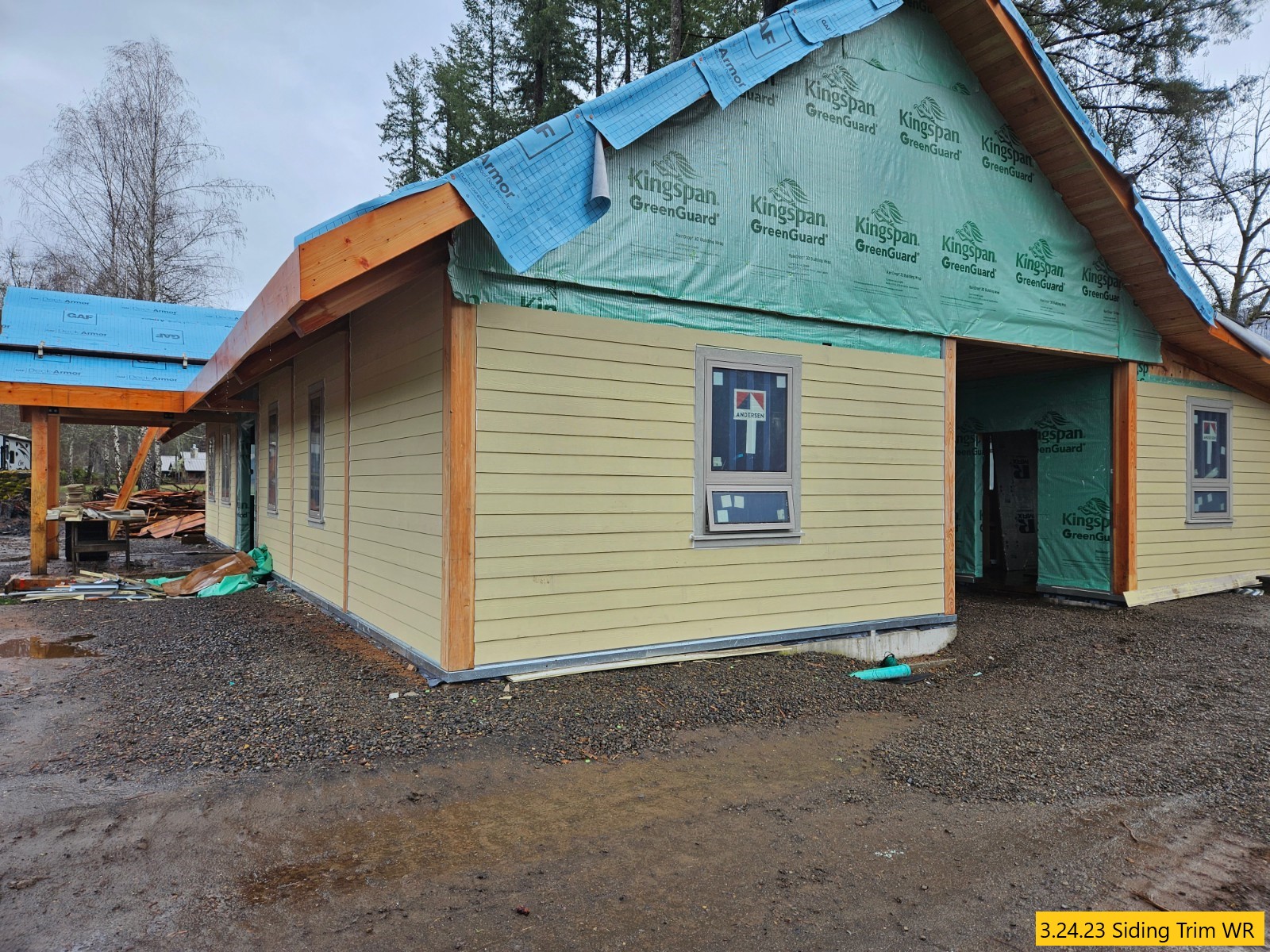

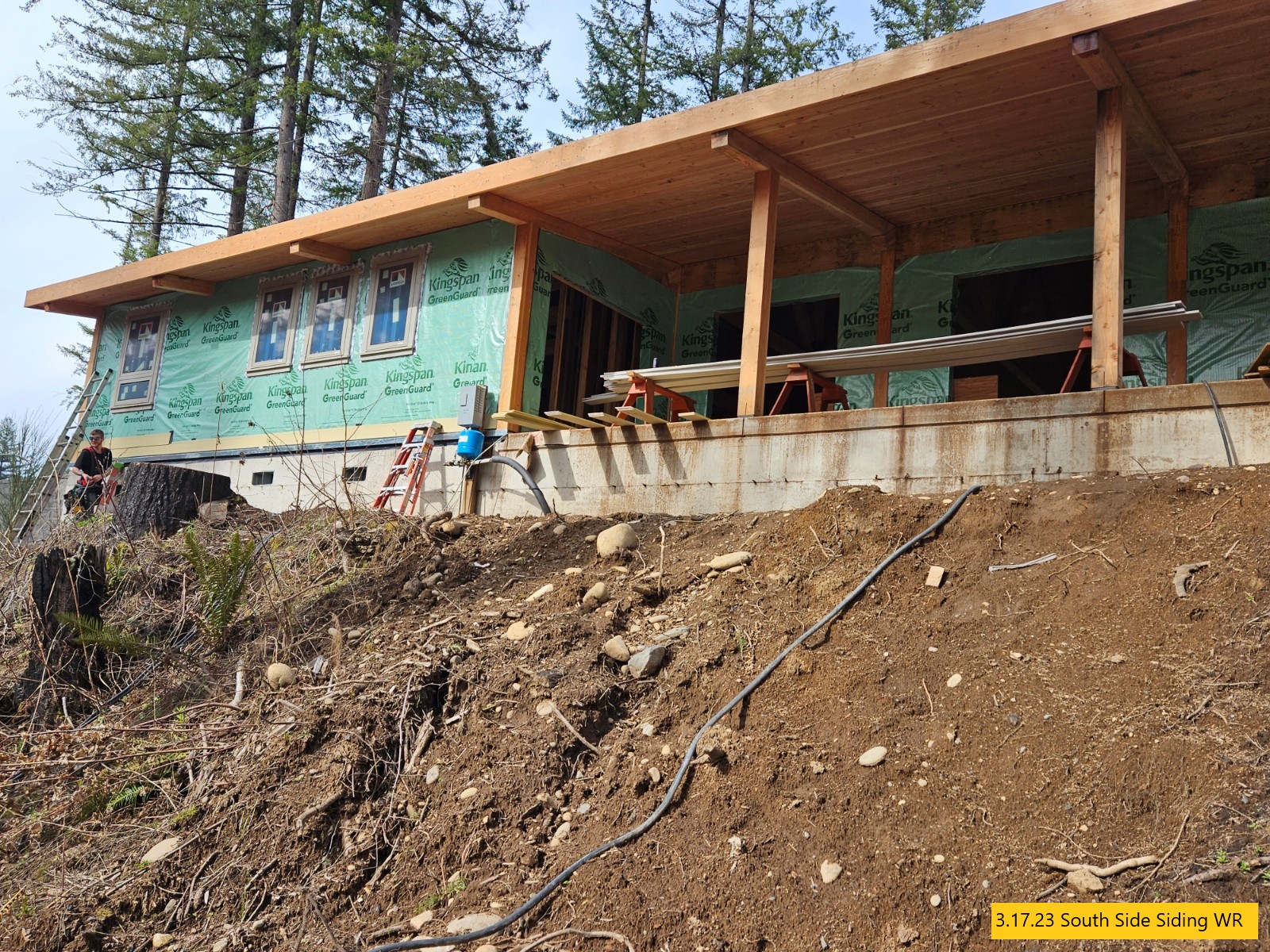

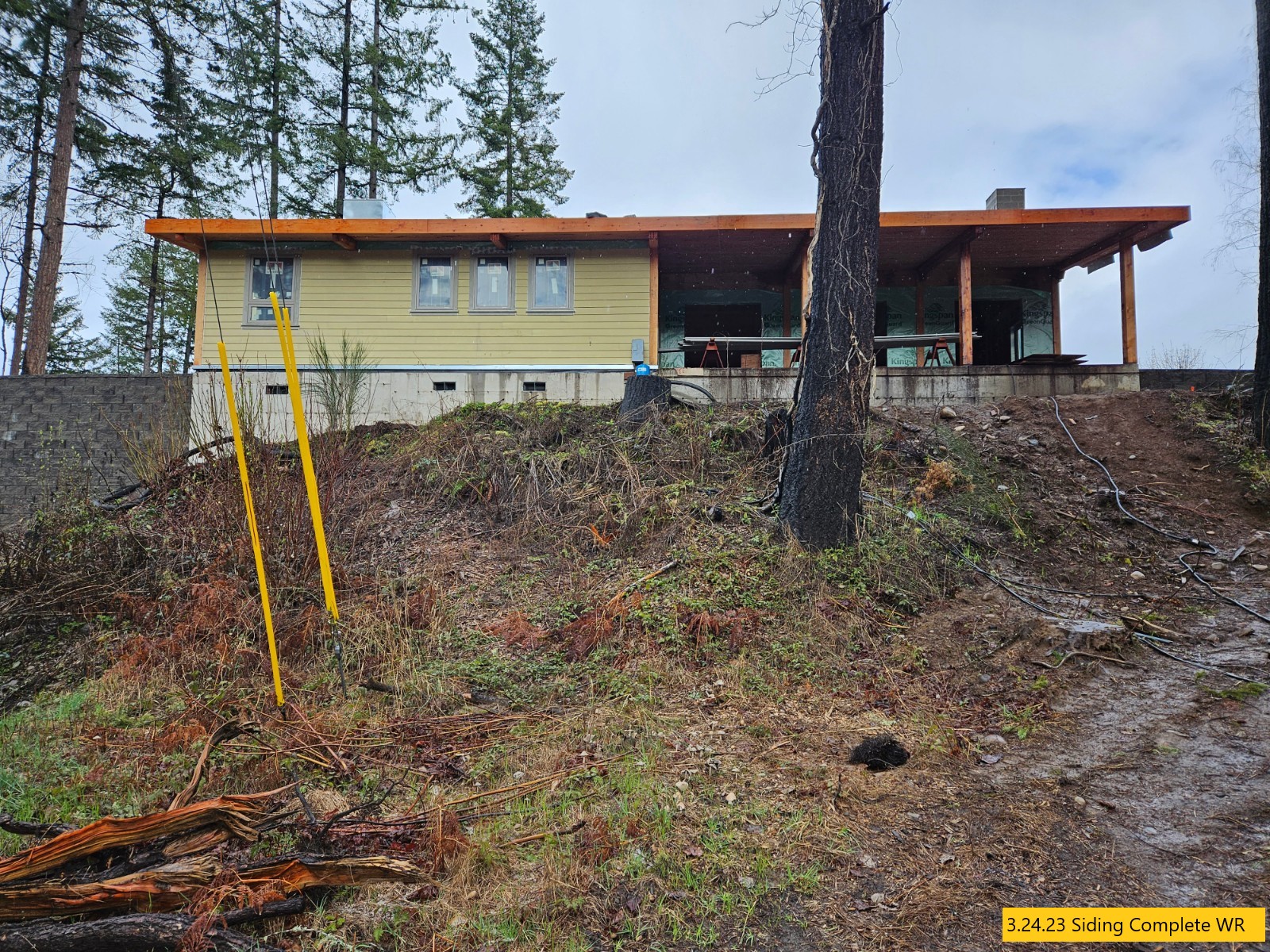

Siding and Siding Trim
Notes from Project Manager Craig Gustfson March 20:
All of the windows are installed.
The retaining wall is completed.
The exterior siding is nearing completion.

March 31, 2023
A Slow Week

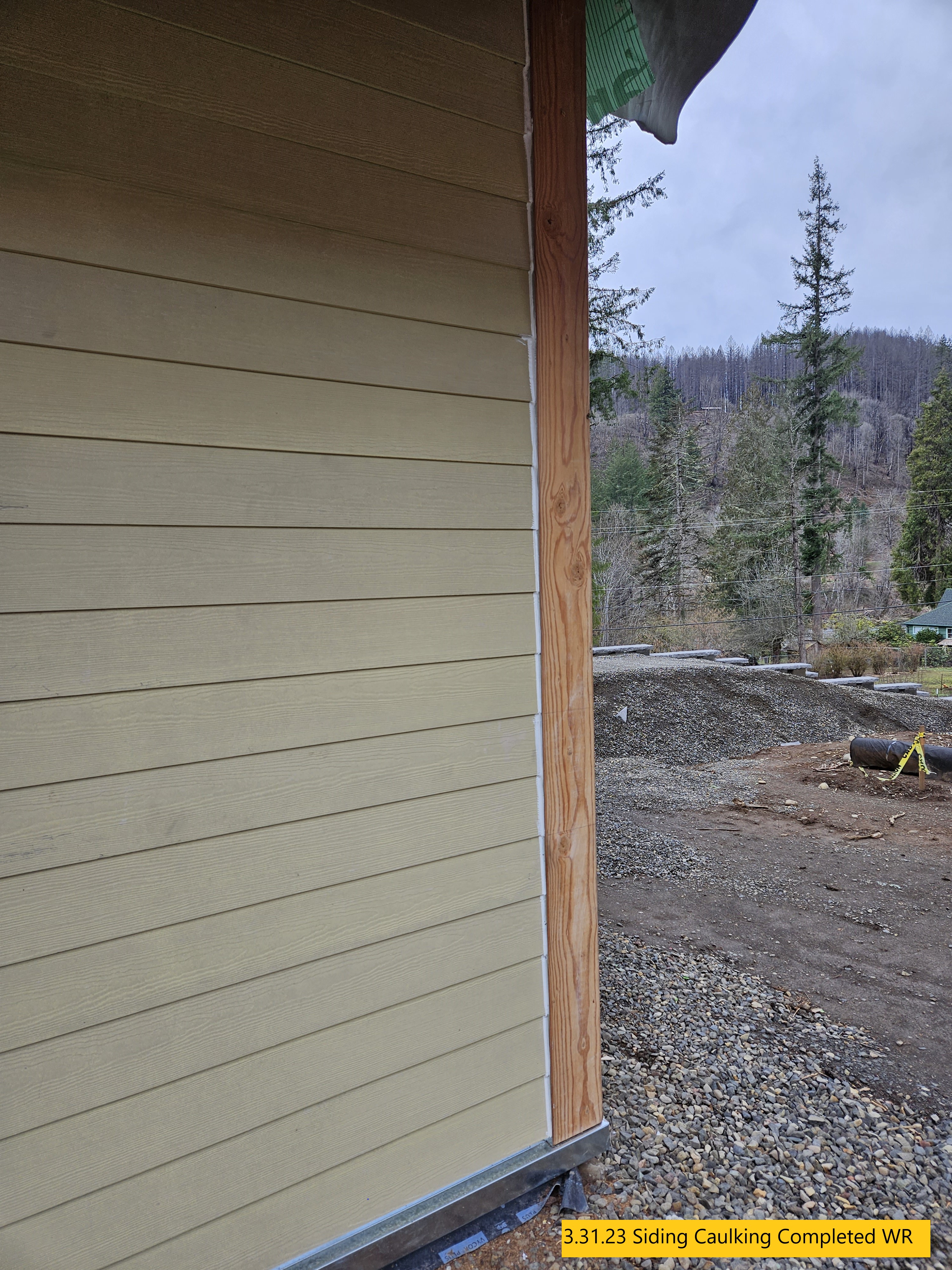

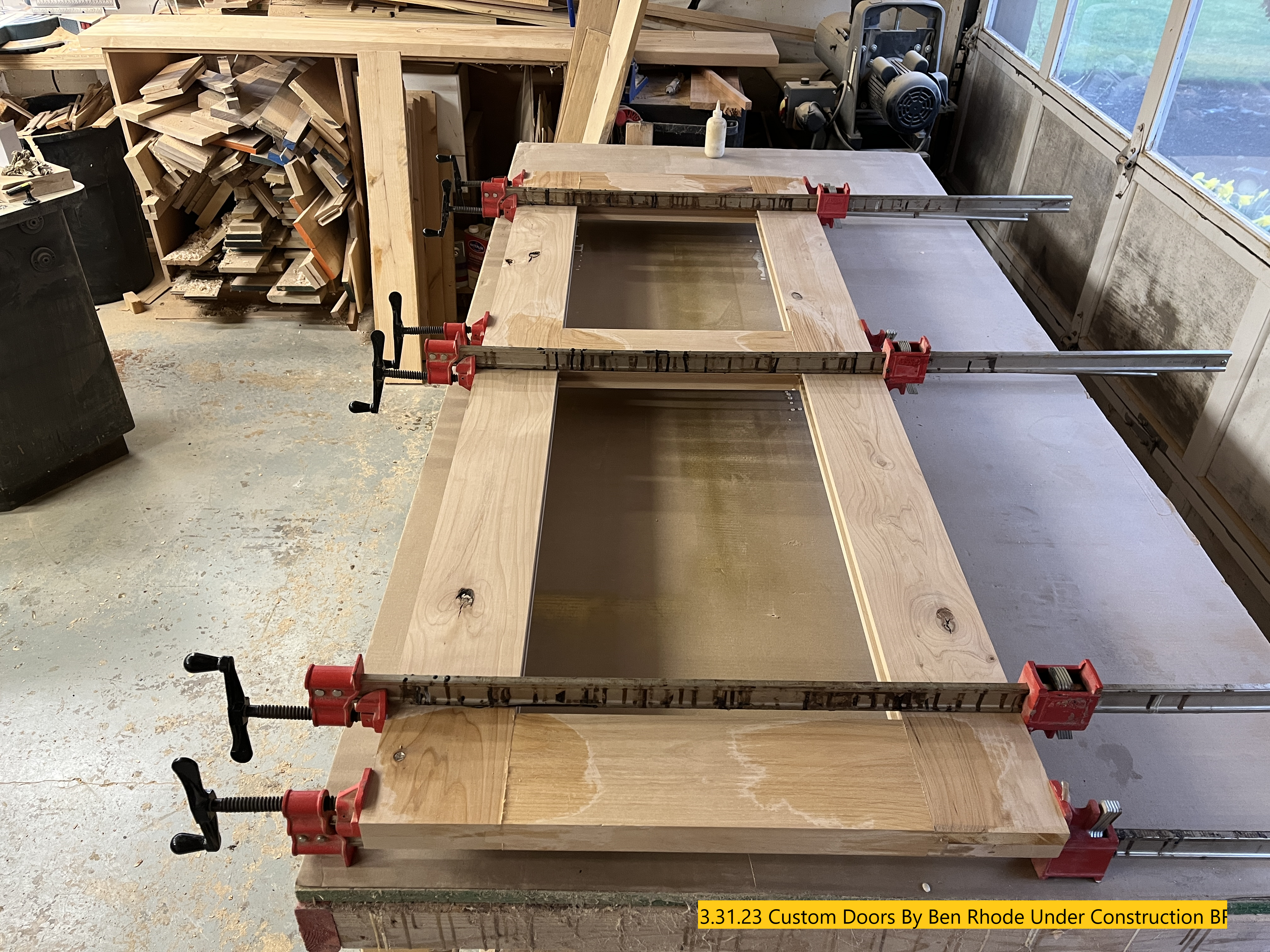

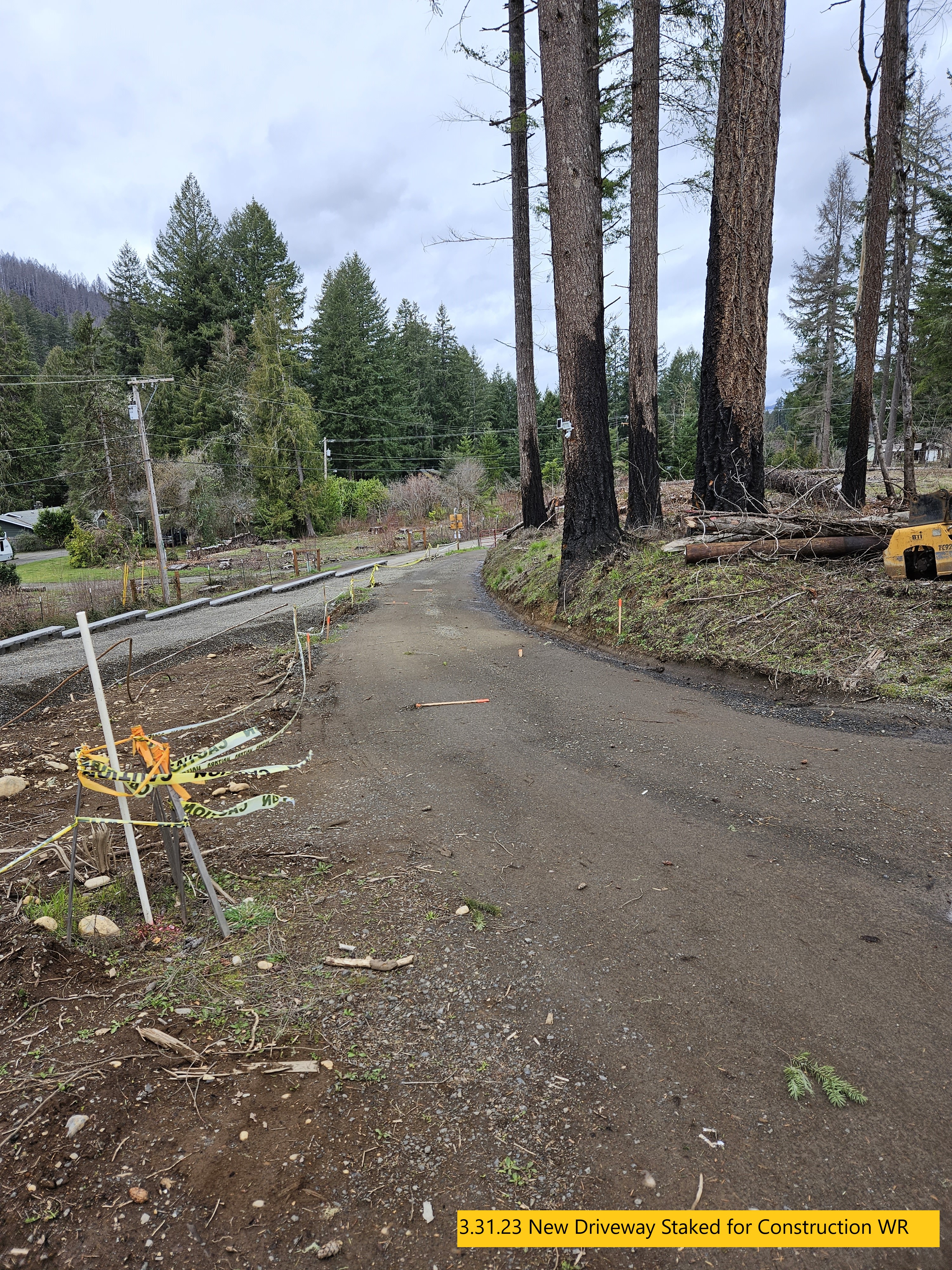

Driveway Staked, Siding Caulked, Custom Doors Being Built
